MERCHANT TRANSMISSION FACILITY
INTERCONNECTION AGREEMENT
BY AND AMONG
THE NEW YORK INDEPENDENT TRANSMISSION SYSTEM OPERATOR, INC.
AND
CONSOLIDATED EDISON COMPANY OF NEW YORK, INC.
AND
HUDSON TRANSMISSION PARTNERS, LLC
Dated As Of April 20, 2011
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
TABLE OF CONTENTS
Page No.
ARTICLE 1. DEFINITIONS...................................................1
ARTICLE 2. EFFECTIVE DATE, TERM AND TERMINATION...................11
2.1 Effective Date. ..................................................11
2.2 Term of Agreement. .............................................11
2.3 Termination. ...................................................11
2.4 Termination Costs. ..............................................12
2.5 Disconnection. ..................................................13
2.6 Survival. .......................................................13
ARTICLE 3. REGULATORY FILINGS.........................................13
3.1 Filing. .........................................................13
ARTICLE 4. SCOPE OF INTERCONNECTION SERVICE........................13
4.1 Provision of Service. .............................................13
4.2 No Transmission Delivery Service. .................................14
4.3 No Other Services. ..............................................14
ARTICLE 5. INTERCONNECTION FACILITIES ENGINEERING, PROCUREMENT,
AND CONSTRUCTION......................................................14
5.1 Options. .......................................................14
5.2 General Conditions Applicable to Option to Build. ...................16
5.3 Liquidated Damages. ............................................17
5.4 Reserved. ......................................................18
5.5 Equipment Procurement. .........................................18
5.6 Construction Commencement. ....................................19
5.7 Work Progress. .................................................19
5.8 Information Exchange. ...........................................20
5.9 Limited Operation. ..............................................20
5.10 Developer’s Attachment Facilities (“DAF”). .........................20
5.11 Connecting Transmission Owner’s Attachment Facilities Construction....21
5.12 Access Rights. ..................................................21
5.13 Lands of Other Property Owners. .................................22
5.14 Permits. .......................................................22
5.15 Early Construction of Base Case Facilities. ..........................22
5.16 Suspension. ....................................................22
5.17 Taxes...........................................................23
5.18 Tax Status; Non-Jurisdictional Entities..............................28
5.19 Modification.....................................................29
ARTICLE 6. TESTING AND INSPECTION.....................................30
6.1 Pre-Commercial Operation Date Testing and Modifications. ...........30
6.2 Post-Commercial Operation Date Testing and Modifications. ..........30
6.3 Right to Observe Testing. ........................................30
6.4 Right to Inspect. ................................................31
ARTICLE 7. METERING.....................................................31
7.1 General. ......................................................31
7.2 Check Meters. ..................................................31
7.3 Standards. .....................................................32
7.4 Testing of Metering Equipment. ...................................32
7.5 Metering Data. .................................................32
ARTICLE 8. COMMUNICATIONS............................................32
8.1 Developer Obligations. ...........................................32
8.2 Remote Terminal Unit. ..........................................33
8.3 No Annexation. .................................................33
ARTICLE 9. OPERATIONS..................................................33
9.1 General. .......................................................33
9.2 NYISO and Connecting Transmission Owner Obligations. .............33
9.3 Developer Obligations. ...........................................34
9.4 Start-Up and Synchronization. ....................................34
9.5 Real and Reactive Power Control...................................34
9.6 Outages and Interruptions.........................................35
9.7 Switching and Tagging Rules. .....................................39
9.8 Use of Attachment Facilities by Third Parties.........................39
9.9 Disturbance Analysis Data Exchange. ..............................39
ARTICLE 10. MAINTENANCE...............................................39
10.1 Connecting Transmission Owner Obligations. .......................39
10.2 Developer Obligations. ...........................................40
10.3 Coordination. ..................................................40
10.4 Secondary Systems. .............................................40
10.5 Operating and Maintenance Expenses. .............................40
ARTICLE 11. PERFORMANCE OBLIGATION.................................40
11.1 Developer Attachment Facilities. ..................................40
11.2 Connecting Transmission Owner’s Attachment Facilities. .............40
11.3 System Upgrade Facilities and System Deliverability Upgrades. .........41
11.4 Special Provisions for Affected Systems. ............................41
11.5 Provision of Security. ............................................41
11.6 Developer Compensation for Emergency Services.....................42
11.7 Line Outage Costs. ..............................................42
ARTICLE 12. INVOICE......................................................42
12.1 General. .......................................................42
12.2 Final Invoice....................................................42
12.3 Payment. ......................................................42
12.4 Disputes. .......................................................42
ARTICLE 13. EMERGENCIES................................................43
13.1 Obligations. ....................................................43
13.2 Notice. ........................................................43
13.3 Immediate Action. ..............................................43
13.4 NYISO and Connecting Transmission Owner Authority................43
13.5 Developer Authority. ............................................44
13.6 Limited Liability. ...............................................45
ARTICLE 14. REGULATORY REQUIREMENTS AND GOVERNING LAW........45
14.1 Regulatory Requirements. ........................................45
14.2 Governing Law..................................................45
ARTICLE 15. NOTICES......................................................45
15.1 General. .......................................................45
15.2 Billings and Payments. ...........................................46
15.3 Alternative Forms of Notice. ......................................46
15.4 Operations and Maintenance Notice. ...............................46
ARTICLE 16. FORCE MAJEURE.............................................46
16.1 Force Majeure...................................................46
ARTICLE 17. DEFAULT.....................................................47
17.1 Default.........................................................47
ARTICLE 18. INDEMNITY, CONSEQUENTIAL DAMAGES AND INSURANCE....47
18.1 Indemnity. .....................................................47
18.2 No Consequential Damages. ......................................49
18.3 Insurance. .....................................................49
ARTICLE 19. ASSIGNMENT.................................................51
19.1 Assignment. ....................................................51
ARTICLE 20. SEVERABILITY................................................51
20.1 Severability. ....................................................51
ARTICLE 21. COMPARABILITY.............................................52
21.1 Comparability. .................................................52
ARTICLE 22. CONFIDENTIALITY............................................52
22.1 Confidentiality. .................................................52
ARTICLE 23. ENVIRONMENTAL RELEASES..................................55
23.1 Developer and Connecting Transmission Owner Notice. ...............55
ARTICLE 24. INFORMATION REQUIREMENT................................55
24.1 Information Acquisition. .........................................56
24.2 Information Submission by Connecting Transmission Owner. ..........56
24.3 Updated Information Submission by Developer. ......................56
24.4 Information Supplementation......................................56
ARTICLE 25. INFORMATION ACCESS AND AUDIT RIGHTS...................57
25.1 Information Access. .............................................57
25.2 Reporting of Non-Force Majeure Events. ...........................57
25.3 Audit Rights. ...................................................57
25.4 Audit Rights Periods..............................................58
25.5 Audit Results. ..................................................58
ARTICLE 26. SUBCONTRACTORS...........................................58
26.1 General. .......................................................58
26.2 Responsibility of Principal. .......................................58
26.3 No Limitation by Insurance. ......................................59
ARTICLE 27. DISPUTES.....................................................59
27.1 Submission. ....................................................59
27.2 External Arbitration Procedures. ..................................59
27.3 Arbitration Decisions. ............................................59
27.4 Costs. .........................................................60
27.5 Termination. ...................................................60
ARTICLE 28. REPRESENTATIONS, WARRANTIES AND COVENANTS..........60
28.1 General. .......................................................60
ARTICLE 29. MISCELLANEOUS.............................................61
29.1 Binding Effect. .................................................61
29.2 Conflicts. ......................................................61
29.3 Rules of Interpretation. ..........................................61
29.4 Compliance. ....................................................62
29.5 Joint and Several Obligations. .....................................62
29.6 Entire Agreement. ..............................................62
29.7 No Third Party Beneficiaries. ......................................62
29.8 Waiver. ........................................................62
29.9 Headings. ......................................................62
29.10 Multiple Counterparts. ...........................................62
29.11 Amendment. ...................................................63
29.12 Modification by the Parties. .......................................63
29.13 Reservation of Rights. ...........................................63
29.14 No Partnership. .................................................63
29.15 Other Transmission Rights. .......................................63
Appendices.............................................................65
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
MERCHANT TRANSMISSION FACILITY INTERCONNECTION AGREEMENT
THIS MERCHANT FACILITY INTERCONNECTION AGREEMENT (“Agreement”) is made and entered into this 20th day of April 2011, by and among Hudson Transmission Partners, LLC, a limited liability company organized and existing under the laws of the State of New York (“Developer”), the New York Independent System Operator, Inc., a not-for-profit corporation organized and existing under the laws of the State of New York (“NYISO”), and Consolidated Edison Company of New York, Inc., a corporation organized and existing under the laws of the State of New York (“Connecting Transmission Owner”). Developer, the NYISO, or Connecting Transmission Owner each may be referred to as a “Party” or collectively referred to as the “Parties.”
RECITALS
WHEREAS, NYISO operates the Transmission System and Connecting Transmission Owner owns certain facilities included in the Transmission System; and
WHEREAS, Developer intends to own, lease and/or control and operate the Merchant Transmission Facility identified in Appendix C to this Agreement; and
WHEREAS, Developer, NYISO, and Connecting Transmission Owner have agreed to enter into this Agreement for the purpose of interconnecting the Merchant Transmission Facility with the New York State Transmission System;
NOW, THEREFORE, in consideration of and subject to the mutual covenants contained herein, it is agreed:
Whenever used in this Agreement with initial capitalization, the following terms shall have the meanings specified in this Article 1. Terms used in this Agreement with initial capitalization that are not defined in this Article 1, shall have the meanings specified in Section 30.1.0 or Attachment S of the NYISO OATT.
Affected System shall mean an electric system other than the transmission system owned, controlled or operated by the Connecting Transmission Owner that may be affected by the proposed interconnection.
Affected System Operator shall mean the entity that operates an Affected System.
Affected Transmission Owner shall mean the New York public utility or authority (or its designated agent) other than the Connecting Transmission Owner that (i) owns facilities used for the transmission of Energy in interstate commerce and provides Transmission Service under the Tariff, and (ii) owns, leases or otherwise possesses an interest in a portion of the New York State Transmission System where System Deliverability Upgrades or System Upgrade Facilities are installed pursuant to Attachment X and Attachment S of the Tariff.
Affiliate shall mean, with respect to a person or entity, any individual, corporation, partnership, firm, joint venture, association, joint-stock company, trust or unincorporated organization, directly or indirectly controlling, controlled by, or under common control with, such person or entity. The term “control” shall mean the possession, directly or indirectly, of the power to direct the management or policies of a person or an entity. A voting interest of ten percent or more shall create a rebuttable presumption of control.
Ancillary Services shall mean those services that are necessary to support the transmission of Capacity and Energy from resources to Loads while maintaining reliable operation of the New York State Transmission System in accordance with Good Utility Practice.
Applicable Laws and Regulations shall mean all duly promulgated applicable federal, state and local laws, regulations, rules, ordinances, codes, decrees, judgments, directives, or judicial or administrative orders, permits and other duly authorized actions of any Governmental Authority, including but not limited to Environmental Law.
Applicable Reliability Councils shall mean the NERC, the NPCC and the NYSRC and to the extent applicable for portions of the Merchant Transmission Facility and Developer Attachment Facilities located beyond the New York Control Area, the PJM Interconnection LLC (“PJM”) and Reliability First Corporation (“RFC”).
Applicable Reliability Standards shall mean the requirements and guidelines of the Applicable Reliability Councils, and the Transmission District to which the Developer’s Merchant Transmission Facility is directly interconnected, as those requirements and guidelines are amended and modified and in effect from time to time; provided that no Party shall waive its right to challenge the applicability or validity of any requirement or guideline as applied to it in the context of this Agreement.
Attachment Facilities shall mean the Connecting Transmission Owner’s Attachment Facilities and the Developer’s Attachment Facilities. Collectively, Attachment Facilities include all facilities and equipment between the Merchant Transmission Facility and the Point of Interconnection, including any modification, additions or upgrades that are necessary to physically and electrically interconnect the Merchant Transmission Facility to the New York State Transmission System. Attachment Facilities are sole use facilities and shall not include Stand Alone System Upgrade Facilities or System Upgrade Facilities or System Deliverability Upgrades.
Base Case shall mean the base case power flow, short circuit, and stability data bases used for the Interconnection Studies by NYISO, Connecting Transmission Owner or Developer; described in Section 30.2.3 of the Large Facility Interconnection Procedures.
Breach shall mean the failure of a Party to perform or observe any material term or condition of this Agreement.
Breaching Party shall mean a Party that is in Breach of this Agreement.
Business Day shall mean Monday through Friday, excluding federal holidays.
Byway shall mean all transmission facilities comprising the New York State Transmission System that are neither Highways nor Other Interfaces. All transmission facilities in Zone J and Zone K are Byways.
Calendar Day shall mean any day including Saturday, Sunday or a federal holiday.
Capacity Region shall mean one of three subsets of the Installed Capacity statewide markets comprised of Rest of State (Zones A through I), Long Island (Zone K), and New York City (Zone J).
Capacity Resource Interconnection Service (“CRIS”) shall mean the service provided by NYISO to interconnect the Developer’s Merchant Transmission Facility to the New York State Transmission System in accordance with the NYISO Deliverability Interconnection Standard, to enable the New York State Transmission System to deliver electric capacity from the Merchant Transmission Facility, pursuant to the terms of the NYISO OATT.
Class Year Deliverability Study shall mean an assessment, conducted by the NYISO staff in cooperation with Market Participants, to determine the System Deliverability Upgrades required for each generation and merchant transmission project included in the Class Year Interconnection Facilities Study to interconnect to the New York State Transmission System in compliance with the NYISO Deliverability Interconnection Standard.
Clustering shall mean the process whereby a group of Interconnection Requests is studied together, instead of serially, for the purpose of conducting the Interconnection System Reliability Impact Study.
Commercial Operation shall mean the status of a Merchant Transmission Facility that has commenced transmitting electricity, excluding electricity transmitted during Trial Operation.
Commercial Operation Date of a unit shall mean the date on which the Merchant Transmission Facility commences Commercial Operation as agreed to by the Parties pursuant to Appendix E to this Agreement.
Confidential Information shall mean any information that is defined as confidential by Article 22 of this Agreement.
Connecting Transmission Owner shall mean the New York public utility or authority (or its designated agent) that (i) owns facilities used for the transmission of Energy in interstate commerce and provides Transmission Service under the Tariff, (ii) owns, leases or otherwise possesses an interest in the portion of the New York State Transmission System at the Point of Interconnection, and (iii) is a Party to the Standard Large Interconnection Agreement.
Connecting Transmission Owner’s Attachment Facilities shall mean all facilities and equipment owned, controlled or operated by the Connecting Transmission Owner from the Point of Change of Ownership to the Point of Interconnection as identified in Appendix A to this Agreement, including any modifications, additions or upgrades to such facilities and equipment. Connecting Transmission Owner’s Attachment Facilities are sole use facilities and shall not include Stand Alone System Upgrade Facilities or System Upgrade Facilities.
Control Area shall mean an electric power system or combination of electric power systems to which a common automatic generation control scheme is applied in order to: (1) match, at all times, the power output of the Generators within the electric power system(s) and capacity and energy purchased from entities outside the electric power system(s), with the Load within the electric power system(s); (2) maintain scheduled interchange with other Control Areas, within the limits of Good Utility Practice; (3) maintain the frequency of the electric power system(s) within reasonable limits in accordance with Good Utility Practice; and (4) provide sufficient generating capacity to maintain Operating Reserves in accordance with Good Utility Practice. A Control Area must be certified by the NPCC or RFC, as applicable.
Default shall mean the failure of a Party in Breach of this Agreement to cure such Breach in accordance with Article 17 of this Agreement.
Deliverability Interconnection Standard shall mean the standard that must be met by any Merchant Transmission Facility proposing to interconnect to the New York State Transmission System and become a qualified Installed Capacity Supplier. To meet the NYISO Deliverability Interconnection Standard, the Developer of the proposed Merchant Transmission Facility must, in accordance with the rules in Attachment S to the NYISO OATT, fund or commit to fund the System Deliverability Upgrades identified for its project in the Class Year Deliverability Study.
Developer shall mean an Eligible Customer developing a Merchant Transmission Facility, proposing to connect to the New York State Transmission System, in compliance with the NYISO Minimum Interconnection Standard.
Developer’s Attachment Facilities shall mean all facilities and equipment, as identified in Appendix A of this Agreement, that are located between the Merchant Transmission Facility and the Point of Change of Ownership, including any modification, addition, or upgrades to such facilities and equipment necessary to physically and electrically interconnect the Merchant Transmission Facility to the New York State Transmission System. Developer’s Attachment Facilities are sole use facilities.
Dispute Resolution shall mean the procedure described in Article 27 of this Agreement for resolution of a dispute between the Parties.
Effective Date shall mean the date on which this Agreement becomes effective upon execution by the Parties, subject to acceptance by the Commission, or if filed unexecuted, upon the date specified by the Commission.
Emergency State shall mean the condition or state that the New York State Power System is in when an abnormal condition occurs that requires automatic or immediate manual action to prevent or limit loss of the New York State Transmission System or Generators that could adversely affect the reliability of the New York State Power System.
Energy Resource Interconnection Service (“ERIS”) shall mean the service provided by NYISO to interconnect the Developer’s Merchant Transmission Facility to the New York State Transmission System in accordance with the NYISO Minimum Interconnection Standard, to enable the New York State Transmission System to receive Energy and Ancillary Services from the Merchant Transmission Facility, pursuant to the terms of the NYISO OATT.
Engineering & Procurement (E&P) Agreement shall mean an agreement that authorizes Connecting Transmission Owner to begin engineering and procurement of long lead-time items necessary for the establishment of the interconnection in order to advance the implementation of the Interconnection Request.
Environmental Law shall mean Applicable Laws or Regulations relating to pollution or protection of the environment or natural resources.
Federal Power Act shall mean the Federal Power Act, as amended, 16 U.S.C. §§ 791a et seq. (“FPA”).
FERC shall mean the Federal Energy Regulatory Commission (“Commission”) or its successor.
Force Majeure shall mean any act of God, labor disturbance, act of the public enemy, war, insurrection, riot, fire, storm or flood, explosion, breakage or accident to machinery or equipment, any order, regulation or restriction imposed by governmental, military or lawfully established civilian authorities, or any other cause beyond a Party’s control. A Force Majeure event does not include acts of negligence or intentional wrongdoing by the Party claiming Force Majeure.
Good Utility Practice shall mean any of the practices, methods and acts engaged in or approved by a significant portion of the electric industry during the relevant time period, or any of the practices, methods and acts which, in the exercise of reasonable judgment in light of the facts known at the time the decision was made, could have been expected to accomplish the desired result at a reasonable cost consistent with good business practices, reliability, safety and expedition. Good Utility Practice is not intended to be limited to the optimum practice, method, or act to the exclusion of all others, but rather to delineate acceptable practices, methods, or acts generally accepted in the region.
Governmental Authority shall mean any federal, state, local or other governmental regulatory or administrative agency, court, commission, department, board, or other governmental subdivision, legislature, rulemaking board, tribunal, or other governmental authority having jurisdiction over any of the Parties, their respective facilities, or the respective services they provide, and exercising or entitled to exercise any administrative, executive, police, or taxing authority or power; provided, however, that such term does not include Developer, NYISO, Affected Transmission Owner, Connecting Transmission Owner, or any Affiliate thereof.
Hazardous Substances shall mean any chemicals, materials or substances defined as or included in the definition of “hazardous substances,” “hazardous wastes,” “hazardous materials,” “hazardous constituents,” “restricted hazardous materials,” “extremely hazardous substances,” “toxic substances,” “radioactive substances,” “contaminants,” “pollutants,” “toxic pollutants” or words of similar meaning and regulatory effect under any applicable Environmental Law, or any other chemical, material or substance, exposure to which is prohibited, limited or regulated by any applicable Environmental Law.
Highway shall mean 115 kV and higher transmission facilities that comprise the following NYCA interfaces: Dysinger East, West Central, Volney East, Moses South, Central East/Total East, UPNY-SENY and UPNY-ConEd, and their immediately connected, in series, Bulk Power System facilities in New York State. Each interface shall be evaluated to determine additional “in series” facilities, defined as any transmission facility higher than 115 kV that (a) is located in an upstream or downstream zone adjacent to the interface and (b) has a power transfer distribution factor (DFAX) equal to or greater than five percent when the aggregate of generation in zones or systems adjacent to the upstream zone or zones which define the interface is shifted to the aggregate of generation in zones or systems adjacent to the downstream zone or zones which define the interface. In determining “in series” facilities for Dysinger East and West Central interfaces, the 115 kV and 230 kV tie lines between NYCA and PJM located in LBMP Zones A and B shall not participate in the transfer. Highway transmission facilities are listed in ISO Procedures.
Initial Synchronization Date shall mean the date upon which the Merchant Transmission Facility is initially synchronized with the New York State Transmission System and upon which Trial Operation begins.
In-Service Date shall mean the date upon which the Developer reasonably expects it will be ready to begin use of the Connecting Transmission Owner’s Attachment Facilities or System Upgrade Facilities to obtain back feed power.
Interconnection Facilities Study shall mean a study conducted by NYISO or a third party consultant for the Developer to determine a list of facilities (including Connecting Transmission Owner’s Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades as identified in the Interconnection System Reliability Impact Study), the cost of those facilities, and the time required to interconnect the Merchant Transmission Facility with the New York State Transmission System. The scope of the study is defined in Section 30.8 of the Standard Large Facility Interconnection Procedures.
Interconnection Facilities Study Agreement shall mean the form of agreement contained in Appendix 4 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection Facilities Study.
Interconnection Feasibility Study shall mean a preliminary evaluation of the system impact and cost of interconnecting the Merchant Transmission Facility to the New York State Transmission System, the scope of which is described in Section 30.6 of the Standard Large Facility Interconnection Procedures.
Interconnection Feasibility Study Agreement shall mean the form of agreement contained in Appendix 2 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection Feasibility Study.
Interconnection Request shall mean a Developer’s request, in the form of Appendix 1 to the Standard Large Facility Interconnection Procedures, in accordance with the Tariff, to interconnect a new Merchant Transmission Facility to the New York State Transmission System, or to increase the capacity of, or make a material modification to the operating characteristics of, an existing Merchant Transmission Facility that is interconnected with the New York State Transmission System.
Interconnection Study shall mean any of the following studies: the Interconnection Feasibility Study, the Interconnection System Reliability Impact Study, and the Interconnection Facilities Study described in the Standard Large Facility Interconnection Procedures.
Interconnection System Reliability Impact Study (“SRIS”) shall mean an engineering study, conducted in accordance with Section 30.7 of the Large Facility Interconnection Procedures, that evaluates the impact of the proposed Merchant Transmission Facility on the safety and reliability of the New York State Transmission System and, if applicable, an Affected System, to determine what Attachment Facilities and System Upgrade Facilities are needed for the proposed Merchant Transmission Facility of the Developer to connect reliably to the New York State Transmission System in a manner that meets the NYISO Minimum Interconnection Standard.
Interconnection System Reliability Impact Study Agreement shall mean the form of agreement contained in Appendix 3 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection System Reliability Impact Study.
IRS shall mean the Internal Revenue Service.
Loss shall mean any and all losses relating to injury to or death of any person or damage to property, demand, suits, recoveries, costs and expenses, court costs, attorney fees, and all other obligations by or to third parties, arising out of or resulting from the Indemnified Party’s performance or non-performance of its obligations under this Agreement on behalf of the Indemnifying Party, except in cases of gross negligence or intentional wrongdoing by the Indemnified Party.
Material Modification shall mean those modifications that have a material impact on the cost or timing of any Interconnection Request with a later queue priority date.
Merchant Transmission Facility shall mean generally a merchant facility for the transmission of electricity, and specifically the Developer’s facility for the transmission of electricity as described in this Agreement and the Appendices hereto.
Merchant Transmission Facility Interconnection Agreement shall mean this Agreement.
Metering Equipment shall mean all metering equipment installed or to be installed at the Point of Interconnection, including but not limited to instrument transformers, MWh-meters, data acquisition equipment, transducers, remote terminal unit, communications equipment, phone lines, and fiber optics.
Minimum Interconnection Standard shall mean the reliability standard that must be met by any Merchant Transmission Facility proposing to connect to the New York State Transmission System. The Standard is designed to ensure reliable access by the proposed project to the New York State Transmission System. The Standard does not impose any deliverability test or deliverability requirement on the proposed interconnection.
NERC shall mean the North American Electric Reliability Council or its successor organization.
New York State Transmission System shall mean the entire New York State electric transmission system, which includes (i) the Transmission Facilities under ISO Operational Control; (ii) the Transmission Facilities Requiring ISO Notification; and (iii) all remaining transmission facilities within the New York Control Area.
Notice of Dispute shall mean a written notice of a dispute or claim that arises out of or in connection with this Agreement or its performance.
NPCC shall mean the Northeast Power Coordinating Council or its successor organization.
NYSRC shall mean the New York State Reliability Council or its successor organization.
Optional Interconnection Study shall mean a sensitivity analysis based on assumptions specified by the Developer in the Optional Interconnection Study Agreement.
Optional Interconnection Study Agreement shall mean the form of agreement contained in Appendix 5 of the Standard Large Facility Interconnection Procedures for conducting the Optional Interconnection Study.
Other Interfaces shall mean interfaces into New York capacity regions, Zone J and Zone K, and external ties into the New York Control Area.
Party or Parties shall mean NYISO, Connecting Transmission Owner, or Developer or any combination of the above.
Point of Change of Ownership shall mean the point, as set forth in Appendix A to this Agreement, where the Developer’s Attachment Facilities connect to the Connecting Transmission Owner’s Attachment Facilities.
Point of Interconnection shall mean the point, as set forth in Appendix A to this Agreement, where the Attachment Facilities connect to the New York State Transmission System.
Queue Position shall mean the order of a valid Interconnection Request, relative to all other pending valid Interconnection Requests, that is established based upon the date and time of receipt of the valid Interconnection Request by NYISO.
Reasonable Efforts shall mean, with respect to an action required to be attempted or taken by a Party under this Agreement, efforts that are timely and consistent with Good Utility Practice and are otherwise substantially equivalent to those a Party would use to protect its own interests.
Scoping Meeting shall mean the meeting between representatives of the Developer, NYISO and Connecting Transmission Owner conducted for the purpose of discussing alternative interconnection options, to exchange information including any transmission data and earlier study evaluations that would be reasonably expected to impact such interconnection options, to analyze such information, and to determine the potential feasible Points of Interconnection.
Services Tariff shall mean the NYISO Market Administration and Control Area Tariff, as filed with the Commission, and as amended or supplemented from time to time, or any successor tariff thereto.
Site Control shall mean documentation reasonably demonstrating: (1) ownership of, a leasehold interest in, or a right to develop a site for the purpose of constructing the Merchant Transmission Facility; (2) an option to purchase or acquire a leasehold site for such purpose; or (3) an exclusivity or other business relationship between Developer and the entity having the right to sell, lease or grant Developer the right to possess or occupy a site for such purpose.
Stand Alone System Upgrade Facilities shall mean System Upgrade Facilities that a Developer may construct without affecting day-to-day operations of the New York State Transmission System during their construction. NYISO, the Connecting Transmission Owner and the Developer must agree as to what constitutes Stand Alone System Upgrade Facilities and identify them in Appendix A to this Agreement.
Standard Large Facility Interconnection Procedures (“LFIP”) shall mean the interconnection procedures applicable to an Interconnection Request pertaining to a Merchant Transmission Facility that are included in Attachment X of the NYISO OATT.
Standard Large Generator Interconnection Agreement (“LGIA”) shall mean the form of interconnection agreement applicable to an Interconnection Request pertaining to a Large Generating Facility, that is included in Attachment X of the NYISO OATT.
System Deliverability Upgrades shall mean the least costly configuration of commercially available components of electrical equipment that can be used, consistent with Good Utility Practice and Applicable Reliability Requirements, to make the modifications or additions to Byways and Highways and Other Interfaces on the existing New York State Transmission System that are required for the proposed project to connect reliably to the system in a manner that meets the NYISO Deliverability Interconnection Standard at the requested level of Capacity Resource Interconnection Service.
System Protection Facilities shall mean the equipment, including necessary protection signal communications equipment, required to (1) protect the New York State Transmission System from faults or other electrical disturbances occurring at the Merchant Transmission Facility and (2) protect the Merchant Transmission Facility from faults or other electrical system disturbances occurring on the New York State Transmission System or on other delivery systems or other generating systems to which the New York State Transmission System is directly connected.
System Upgrade Facilities shall mean the least costly configuration of commercially available components of electrical equipment that can be used, consistent with Good Utility Practice and Applicable Reliability Requirements, to make the modifications to the existing transmission system that are required to maintain system reliability due to: (i) changes in the system, including such changes as load growth and changes in load pattern, to be addressed in the form of generic generation or transmission projects; and (ii) proposed interconnections. In the case of proposed interconnection projects, System Upgrade Facilities are the modifications or additions to the existing New York State Transmission System that are required for the proposed project to connect reliably to the system in a manner that meets the NYISO Minimum Interconnection Standard.
Tariff shall mean the NYISO Open Access Transmission Tariff (“OATT”), as filed with the Commission, and as amended or supplemented from time to time, or any successor tariff.
Trial Operation shall mean the period during which Developer is engaged in on-site test operations and commissioning of the Merchant Transmission Facility prior to Commercial Operation.
If Developer terminates this Agreement, it shall be responsible for all costs incurred in association with Developer’s interconnection, including any cancellation costs relating to orders or contracts for Attachment Facilities and equipment, and other expenses including any System Upgrade Facilities and System Deliverability Upgrades for which the Connecting Transmission Owner has incurred expenses and has not been reimbursed by the Developer.
However, in no event shall the total liquidated damages exceed 20 percent of the actual cost of the Connecting Transmission Owner Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades for which the Connecting Transmission Owner has assumed responsibility to design, procure, and construct. The foregoing payments will be made by the Connecting Transmission Owner to the Developer as just compensation for the damages caused to the Developer, which actual damages are uncertain and impossible to determine at this time, and as reasonable liquidated damages, but not as a penalty or a method to secure performance of this Agreement. Liquidated damages, when the Developer and Connecting Transmission Owner agree to them, are the exclusive remedy for the Connecting Transmission Owner’s failure to meet its schedule.
Further, Connecting Transmission Owner shall not pay liquidated damages to Developer if: (1) Developer is not ready to commence use of the Connecting Transmission Owner’s Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades to take the delivery of power for the Developer’s Merchant Transmission Facility’s Trial Operation or to transmit power from the Developer’s Merchant Transmission Facility on the specified dates, unless the Developer would have been able to commence use of the Connecting Transmission Owner’s Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades to take the delivery of power for Developer’s Merchant Transmission Facility’s Trial Operation or to transmit power from the Developer’s Merchant Transmission Facility, but for Connecting Transmission Owner’s delay; (2) the Connecting Transmission Owner’s failure to meet the specified dates is the result of the action or inaction of the Developer or any other Developer who has entered into a Merchant Transmission Facility Interconnection Agreement with the Connecting Transmission Owner and NYISO, or action or inaction by any other Party, or any other cause beyond Connecting Transmission Owner’s reasonable control or reasonable ability to cure; (3) the Developer has assumed responsibility for the design, procurement and construction of the Connecting Transmission Owner’s Attachment Facilities and Stand Alone System Upgrade Facilities; or (4) the Connecting Transmission Owner and Developer have otherwise agreed.
In no event shall NYISO have any liability whatever to Developer for liquidated damages associated with the engineering, procurement or construction of Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades.
The Connecting Transmission Owner shall transfer operational control of the Connecting Transmission Owner’s Attachment Facilities and Stand Alone System Upgrade Facilities to the NYISO upon completion of such facilities.
Connecting Transmission Owner shall invoice Developer for such costs pursuant to Article 12 and shall use due diligence to minimize its costs. In the event Developer suspends work by Connecting Transmission Owner required under this Agreement pursuant to this Article 5.16, and has not requested Connecting Transmission Owner to recommence the work required under this Agreement on or before the expiration of three (3) years following commencement of such suspension, this Agreement shall be deemed terminated. The three-year period shall begin on the date the suspension is requested, or the date of the written notice to Connecting Transmission Owner and NYISO, if no effective date is specified.
At Connecting Transmission Owner’s request, Developer shall provide Connecting Transmission Owner with a report from an independent engineer confirming its representation in clause (iii), above. Connecting Transmission Owner represents and covenants that the cost of the Connecting Transmission Owner’s Attachment Facilities paid for by Developer will have no net effect on the base upon which rates are determined.
Connecting Transmission Owner shall not include a gross-up for the cost consequences of any current tax liability in the amounts it charges Developer under this Agreement unless (i) Connecting Transmission Owner has determined, in good faith, that the payments or property transfers made by Developer to Connecting Transmission Owner should be reported as income subject to taxation or (ii) any Governmental Authority directs Connecting Transmission Owner to report payments or property as income subject to taxation; provided, however, that Connecting Transmission Owner may require Developer to provide security, in a form reasonably acceptable to Connecting Transmission Owner (such as a parental guarantee or a letter of credit), in an amount equal to the cost consequences of any current tax liability under this Article 5.17. Developer shall reimburse Connecting Transmission Owner for such costs on a fully grossed-up basis, in accordance with Article 5.17.4, within thirty (30) Calendar Days of receiving written notification from Connecting Transmission Owner of the amount due, including detail about how the amount was calculated.
This indemnification obligation shall terminate at the earlier of (1) the expiration of the ten-year testing period and the applicable statute of limitation, as it may be extended by the Connecting Transmission Owner upon request of the IRS, to keep these years open for audit or adjustment, or (2) the occurrence of a subsequent taxable event and the payment of any related indemnification obligations as contemplated by this Article 5.17.
For this purpose, (i) Current Taxes shall be computed based on Connecting Transmission Owner’s composite federal and state tax rates at the time the payments or property transfers are received and Connecting Transmission Owner will be treated as being subject to tax at the highest marginal rates in effect at that time (the “Current Tax Rate”), and (ii) the Present Value Depreciation Amount shall be computed by discounting Connecting Transmission Owner’s anticipated tax depreciation deductions as a result of such payments or property transfers by Connecting Transmission Owner’s current weighted average cost of capital. Thus, the formula for calculating Developer’s liability to Connecting Transmission Owner pursuant to this Article 5.17.4 can be expressed as follows: (Current Tax Rate x (Gross Income Amount - Present Value of Tax Depreciation))/(1 - Current Tax Rate).
Developer’s estimated tax liability in the event taxes are imposed shall be stated in Appendix A, Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades.
Connecting Transmission Owner shall keep Developer fully informed of the status of such request for a private letter ruling and shall execute either a privacy act waiver or a limited power of attorney, in a form acceptable to the IRS, that authorizes Developer to participate in all discussions with the IRS regarding such request for a private letter ruling. Connecting Transmission Owner shall allow Developer to attend all meetings with IRS officials about the request and shall permit Developer to prepare the initial drafts of any follow-up letters in connection with the request.
Developer shall pay to Connecting Transmission Owner on a periodic basis, as invoiced by Connecting Transmission Owner, Connecting Transmission Owner’s documented reasonable costs of prosecuting such appeal, protest, abatement or other contest. At any time during the contest, Connecting Transmission Owner may agree to a settlement either with Developer’s consent or after obtaining written advice from nationally-recognized tax counsel, selected by Connecting Transmission Owner, but reasonably acceptable to Developer, that the proposed settlement represents a reasonable settlement given the hazards of litigation. Developer’s obligation shall be based on the amount of the settlement agreed to by Developer, or if a higher amount, so much of the settlement that is supported by the written advice from nationally-recognized tax counsel selected under the terms of the preceding sentence. The settlement amount shall be calculated on a fully grossed-up basis to cover any related cost consequences of the current tax liability. Any settlement without Developer’s consent or such written advice will relieve Developer from any obligation to indemnify Connecting Transmission Owner for the tax at issue in the contest.
(i) Any payment made by Developer under this Article 5.17 for taxes that is attributable to the amount determined to be non-taxable, together with interest thereon,
(ii) Interest on any amounts paid by Developer to Connecting Transmission Owner for such taxes which Connecting Transmission Owner did not submit to the taxing authority, calculated in accordance with the methodology set forth in FERC’s regulations at 18 C.F.R. §35.19a(a)(2)(iii) from the date payment was made by Developer to the date Connecting Transmission Owner refunds such payment to Developer, and
(iii) With respect to any such taxes paid by Connecting Transmission Owner, any refund or credit Connecting Transmission Owner receives or to which it may be entitled from any Governmental Authority, interest (or that portion thereof attributable to the payment described in clause (i), above) owed to the Connecting Transmission Owner for such overpayment of taxes (including any reduction in interest otherwise payable by Connecting Transmission Owner to any Governmental Authority resulting from an offset or credit); provided, however, that Connecting Transmission Owner will remit such amount promptly to Developer only after and to the extent that Connecting Transmission Owner has received a tax refund, credit or offset from any Governmental Authority for any applicable overpayment of income tax related to the Connecting Transmission Owner’s Attachment Facilities.
The intent of this provision is to leave both the Developer and Connecting Transmission Owner, to the extent practicable, in the event that no taxes are due with respect to any payment for Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades hereunder, in the same position they would have been in had no such tax payments been made.
In the case of Merchant Transmission Facility modifications that do not require Developer to submit an Interconnection Request, the NYISO shall provide, within sixty (60) Calendar Days (or such other time as the Parties may agree), an estimate of any additional modifications to the New York State Transmission System, Connecting Transmission Owner’s Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades necessitated by such Developer modification and a good faith estimate of the costs thereof. The Developer shall be responsible for the cost of any such additional modifications, including the cost of studying the impact of the Developer modification.
Each Party will promptly advise the appropriate other Party if it detects or otherwise learns of any metering, telemetry or communications equipment errors or malfunctions that require the attention and/or correction by that other Party. The Party owning such equipment shall correct such error or malfunction as soon as reasonably feasible.
In addition:
NYISO and Connecting Transmission Owner shall use Reasonable Efforts to minimize the effect of such actions or inactions on the Merchant Transmission Facility or the Developer Attachment Facilities. NYISO or Connecting Transmission Owner may, on the basis of technical considerations, require the Merchant Transmission Facility to mitigate an Emergency State by taking actions necessary and limited in scope to remedy the Emergency State, including, but not limited to, directing Developer to shut-down, start-up, increase or decrease the real or reactive power output of the Merchant Transmission Facility; implementing a reduction or disconnection pursuant to Article 13.4.2; directing the Developer to assist with blackstart (if available) or restoration efforts; or altering the outage schedules of the Merchant Transmission Facility and the Developer Attachment Facilities. Developer shall comply with all of the NYISO and Connecting Transmission Owner’s operating instructions concerning Merchant Transmission Facility real power and reactive power output within the manufacturer’s design limitations of the Merchant Transmission Facility’s equipment that is in service and physically available for operation at the time, in compliance with Applicable Laws and Regulations.
A Party may change the notice information in this Agreement by giving five (5) Business Days written notice prior to the effective date of the change.
Except as stated below, the Indemnifying Party shall have the right to assume the defense thereof with counsel designated by such Indemnifying Party and reasonably satisfactory to the Indemnified Party. If the defendants in any such action include one or more Indemnified Parties and the Indemnifying Party and if the Indemnified Party reasonably concludes that there may be legal defenses available to it and/or other Indemnified Parties which are different from or additional to those available to the Indemnifying Party, the Indemnified Party shall have the right to select separate counsel to assert such legal defenses and to otherwise participate in the defense of such action on its own behalf. In such instances, the Indemnifying Party shall only be required to pay the fees and expenses of one additional attorney to represent an Indemnified Party or Indemnified Parties having such differing or additional legal defenses.
The Indemnified Party shall be entitled, at its expense, to participate in any such action, suit or proceeding, the defense of which has been assumed by the Indemnifying Party. Notwithstanding the foregoing, the Indemnifying Party (i) shall not be entitled to assume and control the defense of any such action, suit or proceedings if and to the extent that, in the opinion of the Indemnified Party and its counsel, such action, suit or proceeding involves the potential imposition of criminal liability on the Indemnified Party, or there exists a conflict or adversity of interest between the Indemnified Party and the Indemnifying Party, in such event the Indemnifying Party shall pay the reasonable expenses of the Indemnified Party, and (ii) shall not settle or consent to the entry of any judgment in any action, suit or proceeding without the consent of the Indemnified Party, which shall not be unreasonably withheld, conditioned or delayed.
If requested by a Party receiving information, the Party supplying the information shall provide in writing, the basis for asserting that the information referred to in this Article warrants confidential treatment, and the requesting Party may disclose such writing to the appropriate Governmental Authority. Each Party shall be responsible for the costs associated with affording confidential treatment to its information.
If the Developer’s data is different from what was originally provided to Connecting Transmission Owner and NYISO pursuant to an Interconnection Study Agreement among Connecting Transmission Owner, NYISO and Developer and this difference may be reasonably expected to affect the other Parties’ facilities or the New York State Transmission System, but does not require the submission of a new Interconnection Request, then NYISO will conduct appropriate studies to determine the impact on the New York State Transmission System based on the actual data submitted pursuant to this Article 24.3. Such studies will provide an estimate of any additional modifications to the New York State Transmission System, Connecting Transmission Owner’s Attachment Facilities, or System Upgrade Facilities or System Deliverability Upgrades based on the actual data and a good faith estimate of the costs thereof. The Developer shall not begin Trial Operation until such studies are completed. The Developer shall be responsible for the cost of any modifications required by the actual data, including the cost of any required studies.
Developer shall provide the Connecting Transmission Owner and NYISO validated test recordings showing the responses of its Merchant Transmission Facility.
Subsequent to the Commercial Operation Date, the Developer shall provide Connecting Transmission Owner and NYISO any information changes due to equipment replacement, repair, or adjustment. Connecting Transmission Owner shall provide the Developer and NYISO any information changes due to equipment replacement, repair or adjustment in the directly connected substation or any adjacent Connecting Transmission Owner substation that may affect the Merchant Transmission Facility or Developer Attachment Facilities equipment ratings, protection or operating requirements. The Developer and Connecting Transmission Owner shall provide such information no later than thirty (30) Calendar Days after the date of the equipment replacement, repair or adjustment.

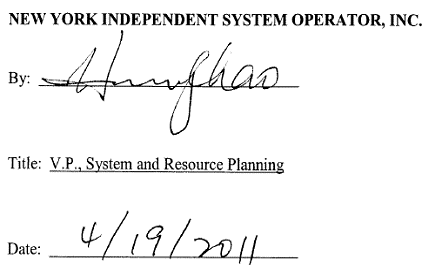

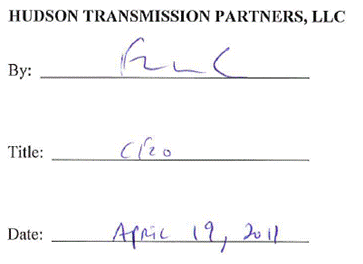

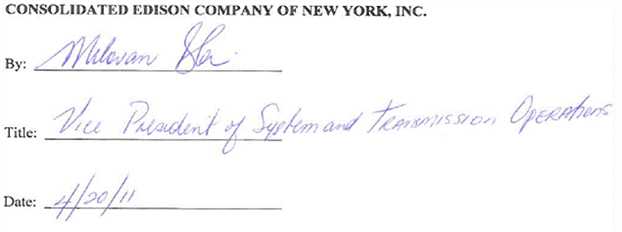

IN WITNESS WHEREOF, the Parties have executed this LGIA in duplicate originals, each of which shall constitute and be an original effective Agreement between the Parties.
Appendix A
Attachment Facilities and System Upgrade Facilities
Appendix B
Milestones
Appendix C
Interconnection Details
Appendix D
Security Arrangements
Appendix E
Commercial Operation Date
Appendix F
Addresses for Delivery of Notices and Billings
Appendix G
Merchant Transmission Facility and Developer Attachment Facilities Performance Specifications
Appendix H
Project Principles
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
APPENDIX A
Attachment Facilities and System Upgrade Facilities
(a) Developer’s Attachment Facilities (“DAF”):
The Merchant Transmission Facility shall interconnect at the available bus position of the Connecting Transmission Owner’s West 49th Street 345 kilovolt (“kV”) Gas Insulated Switchgear (“GIS”) substation (“West 49th Street Substation”) between existing circuit breakers 7 and 8. The DAF, as identified in Figure A-1, will be located between the West 49th Street Substation and the cable transition splice vault at West 52nd Street. Specifically, the DAF will be a single circuit, three phase, 345kV buried electric cable system comprised of (i) an approximately 1800 foot solid dielectric cable segment installed in the public roadways of New York City from the point at which it exits a cable transition splice vault on West 52nd Street to a 345kV GIS design termination in the West 49th Street Substation; and (ii) all necessary terminations, splices and appurtenances as necessary to construct, operate and maintain the DAF. Figure A-1 identifies the DAF, Point of Change of Ownership, and the Point of Interconnection.
Technical details of the major DAF equipment are as follows:
(b) Connecting Transmission Owner’s Attachment Facilities (“CTOAF”):
There are no CTOAFs that are covered by this Agreement.
2. System Upgrade Facilities:
(a) System Upgrade Facilities:
The System Upgrade Facilities (“SUF”) shall include the necessary removal, addition or modifications to the existing structural steel termination and accessories stand at the West 49th Street Substation allowing the DAF to interconnect to the point as illustrated in Figure A-1. SUFs shall also include the addition of a GIS design revenue metering package.
The West 49th Street 345kV substation is an existing indoor GIS design and is configured as a ring bus as shown on Figure A-1. Currently, the pothead for the bus section between breakers 7 and 8 is designed for an oil filled pipe type connection. The Developer selected a solid dielectric cable which is not compatible with the existing pothead. Accordingly, the pipe type cable potheads will need to be replaced, certain conduit in the cable tunnel will need to be removed to make room for the Developer’s cable, and modifications to the relay protection equipment will be required to effectuate the interconnection. Technical details of the SUFs are as follows:
Rated Voltage - 362kV;
Rated Interrupting Rating - 63kA;
Rated Current - 3000A;
Rated 60 Hz. Withstand - 555kV;
Rated BIL in the pressurized SF6 housing - 1050kV;
Rated BIL across any open contacts – 1300kV;
Rated Test Voltage Withstand for Pothead Compartments – 540kVDC for 15 minutes.
The following are details regarding the protection and control equipment required at the West 49th Street Substation:
(b) Other System Upgrade Facilities:
There are no Other System Upgrade Facilities that are covered by this Agreement.
3. System Deliverability Upgrades:
There are no System Deliverability Upgrades that are covered by this Agreement.
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1

Figure A-1 – Single Line Diagram for System Interconnection
4. Cost Estimates: Cost estimates from the Class Year 2008 Interconnection Facilities Study for the CTOAF and System Upgrade Facilities.
(a) Attachment Facilities
Not applicable, because there are no CTOAFs for the Merchant Transmission Facility that are covered by this Agreement.
(b) System Upgrade Facilities

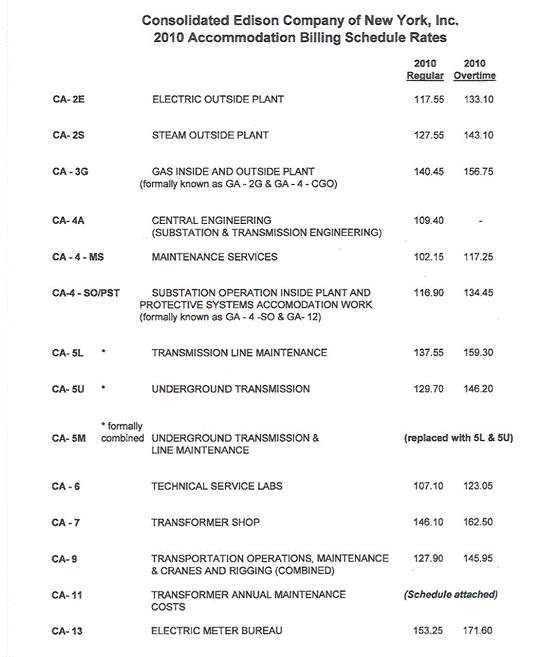

The estimated cost of constructing the System Upgrade Facilities is $16,471,000.00.
(c) Deliverability System Upgrades
Not applicable, because there are no Deliverability System Upgrades for the Merchant Transmission Facility that are covered by this Agreement.
(d) Tax Liability
As of the Effective Date, Developer and Transmission owner are not aware of Developer having any tax liability under Article 5.17 of this Agreement.
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
APPENDIX B
Milestones
1. Selected Option Pursuant to Article 5.1
Developer has selected the Standard Option pursuant to Article 5.1
The following milestones shall apply to the engineering, procurement, construction, and testing for the interconnection of the Merchant Transmission Facility, DAF and SUFs.
The actual dates for completion of the milestones are highly dependent upon lead times for the procurement of equipment and material, the availability of labor, outage scheduling, receipt of regulatory approvals, and the results of equipment testing. The completion and results of environmental remediation of the site, and other unforeseen events could also affect the achievement of the milestones. The Connecting Transmission Owner is under no obligation to undertake any engineering, procurement, or construction work pursuant to this Agreement, until the requirements of Appendix H, section 2 are satisfied, except as specified in Appendix H, section 1(d).
2. Milestones
Item | Milestone | Responsible Party | Due Date |
(a) | Developer issues written authorization to proceed with construction under Article 5.6.2 | Developer | 5/31/2011 |
(b) | Developer replaces existing security with cash or letter of credit or conditions on security are satisfied | Developer | 5/31/2011 |
(c) | Connecting Transmission Owner initiates action to issue GIS Purchase Order | Connecting Transmission Owner | 5/31/2011 |
(d) | Connecting Transmission Owner removes partial amount of retired equipment from West 49th St Substation tunnel to allow for Developer cable installation | Connecting Transmission Owner | 10/1/2011 |
(e) | Developer Cable stub installed into West 49th Substation tunnel | Developer | 10/21/2011 |
(f) | Developer Cable splicing and terminations and acceptance test complete | Developer | 12/14/2012 |
(g) | Developer Cable installed, tested and ready for Synchronization | Developer | 12/14/2012 |
(h) | Completion of System Upgrade Facilities | Developer | 12/15/2012 |
(i) | In-Service Date | Connecting Transmission Owner | 12/15/2012* |
(j) | Initial Synchronization of the Merchant Transmission Facility | Developer | 12/16/2012** |
(k) | Commission testing and Trial Operation complete | Developer | 5/30/2013 |
(l) | Commercial Operation Date (“COD”) | Developer | 5/31/2013 |
* Prior to the In-Service Date, Developer shall comply with NYISO procedures and request and obtain written approval for synchronization from Connecting Transmission Owner. If the facility is ready for synchronization, Connecting Transmission Owner shall grant such approval within ten (10) days of receiving the request.
** Prior to synchronization, Developer shall comply with all applicable NYISO procedures and shall request and obtain written approval for synchronization from Connecting Transmission Owner in accordance with all applicable NYISO, PJM, Public Service Electric and Gas Company (“PSE&G”), and Connecting Transmission Owner procedures. If the unit is ready for synchronization, Connecting Transmission Owner shall grant such approval within ten (10) days of receiving the request.
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
APPENDIX C
Interconnection Details
1. Description of Facilities including Point of Interconnection
(a) Overview of the Merchant Transmission Facility
The Merchant Transmission Facility is a 660MW back-to-back HVDC (AC input-DC conversion-AC output) transmission project that will connect the PSE&G Bergen Substation (“PSE&G Substation”) located in Ridgefield, New Jersey, with the West 49th Street Substation in New York City.
The Merchant Transmission Facility includes 2100 feet of 230kV alternating current (“AC”), solid dielectric cable connection from the PSE&G Substation to a back-to-back converter station facility, to be constructed in Ridgefield, New Jersey by the Developer (the “Converter Station”). The Converter Station, which includes 230kV and 345kV Switchyards, will convert AC power to DC and back to AC. A 345kV AC underground and underwater cable system will be constructed and installed from the Converter Station to the West 49th Street Substation in New York City. A simplified schematic illustrating the major components of the Merchant Transmission Facility, and DAF are included in Appendix A, Figure A-1. The Merchant Transmission Facility and DAF will have an operating range between 60MW and 660MW, subject to system conditions as described in Sections 9.5.1 and 9.5.2 of this agreement.
The high-voltage AC power cables will interconnect PJM and New York City along a route that is entirely underground, installed either in existing roadways, an existing railway tunnel, or buried beneath the Hudson River. The Developer shall design, procure, construct, install, own and/or control the Merchant Transmission Facility described herein, at its sole expense. The Merchant Transmission Facility is from the connection point to the PSE&G Substation in New Jersey to the point of the splice manhole at West 52nd Street in New York City.
The Merchant Transmission Facility will have only unidirectional flow from PJM to the New York Control Area.
The Point of Interconnection (“POI”) is defined as the point identified in Figure A-1 at the West 49th Street Substation between existing circuit breakers 7 and 8 as shown in Figure A-1.
(b) Detailed Description of the Merchant Transmission Facility
The major components for the Merchant Transmission Facility shall include but not be limited to:
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
An underground cable system installed from the Merchant Transmission Facility 230kV Switchyard to the PSE&G Substation with the following components:
A 7.3 mile 345kV, three phase AC underground and underwater cable system installed from the Merchant Transmission Facility 345kV Switchyard to the West 49th Street Substation with the following components:
2. Developer Operating Requirements
(a) Developer shall comply with all provisions of NYISO tariffs and procedures, as amended from time to time, which apply to any aspect of the Merchant Transmission Facility’s operations and its participation in NYISO-administered markets. Tariff revisions and/or operating protocols with NYISO, PJM, the Connecting Transmission Owner, and Developer may need to be developed to incorporate the Merchant Transmission Facility into NYISO-administered markets and to coordinate the operational control of the facility.
(b) Developer shall comply with Connecting Transmission Owner operating instructions and requirements, which requirements shall include the dedicated data circuits to be maintained by Developer in accordance with Article 8.1 of this Agreement. Operating instructions will be communicated by telephone, or such other means of communication as the Parties may agree upon.
(c) Station Power - The Merchant Transmission Facilities will be served by two fully capable and independently supplied station service feeds provided by PSE&G. At no time will it be necessary for the Connecting Transmission Owner to provide station service via the 345kV AC cable to the Converter Station.
3. System Protection and Other Control Requirements
Developer shall provide, install and test relay protection systems at the Merchant Transmission Facility to interface with those systems installed by Connecting Transmission Owner at the West 49th Street Substation.
4. Merchant Transmission Facility Design and Construction
In accordance with Article 5.10 and Article 24.4, the Developer shall provide to the Connecting Transmission Owner and NYISO all detailed design drawings, requirements, specifications, calculations, equipment drawings, “as-built” drawings, information and documents for the Merchant Transmission Facility and DAF, including the following:
a) Final design and performance verification studies as described in Section 5 below;
b) A one-line diagram;
c) Site plan and elevation drawings;
d) Relay functional diagram(s), AC and DC schematic wiring diagrams and device settings for all facilities associated with the station’s 345kV converter transformer and reactive filter bus; and
e) Converter transformer impedances (determined by factory tests) for the 345kV converter transformers.
The minimum design and performance verification studies are summarized as follows:
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
APPENDIX D
Security Arrangements
Infrastructure security of New York State Transmission System equipment and operations and control hardware and software is essential to ensure day-to-day New York State Transmission System reliability and operational security. The Commission will expect the NYISO, all Transmission Owners, all Developers and all other Market Participants to comply with the recommendations offered by the President’s Critical Infrastructure Protection Board and, eventually, best practice recommendations from the electric reliability authority. All public utilities will be expected to meet basic standards for system infrastructure and operational security, including physical, operational, and cyber-security practices.
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
APPENDIX E
Commercial Operation Date
Re: Hudson Transmission Partners, LLC Merchant Transmission Facility
On [Date] [Developer] has completed Trial Operation. This letter confirms that [Developer] commenced Commercial Operation of the Merchant Transmission Facility, effective as of [Date plus one day].
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
APPENDIX F
Addresses for Delivery of Notices and Billings
(i) Before commercial operation of the Merchant Transmission Facility:
New York Independent System Operator, Inc.
Attn: Vice President, System and Resource Planning
10 Krey Boulevard
Rensselaer, NY 12144
Phone: (518) 356-6000
Fax: (518) 356-6118
(ii) After commercial operation of the Merchant Transmission Facility:
New York Independent System Operator, Inc.
Attn: Vice President, Operations
3890 Carman Road
Schenectady, NY 12303
Phone: (518) 356-6000
Fax: (518) 356-6118
(b) Connecting Transmission Owner:
Consolidated Edison Company of New York, Inc.
4 Irving Place
New York, NY 10003
Attn: Vice President
System and Transmission Operations
Phone: (212) 460-1210
Fax: (212) 353-8831
Copy to:
Consolidated Edison Company of New York, Inc.
4 Irving Place
New York, NY 10003
Attn: General Counsel
Phone: (212) 460-2432
Fax: (212) 674-7329
(c) Developer:
Hudson Transmission Partners, LLC
Attn: Edward M. Stern
501 King’s Highway East
Suite 300
Fairfield, CT 06825
Phone: (203) 416-5590
Fax: (203) 416-5599
(a) Connecting Transmission Owner:
Consolidated Edison Company of New York, Inc.
4 Irving Place
New York, NY 10003
Attn: Vice President
System and Transmission Operations
Phone: (212) 460-1210
Fax: (212) 353-8831
(b) Developer:
Hudson Transmission Partners, LLC
Attn: Edward M. Stern
501 King’s Highway East
Suite 300
Fairfield, CT 06825
Phone: (203) 416-5590
Fax: (203) 416-5599
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
MERCHANT TRANSMISSION FACILITY AND DEVELOPER ATTACHMENT FACILITIES PERFORMANCE SPECIFICATIONS
The Merchant Transmission Facility and DAF shall be designed for continuous delivery to the POI as described under the following system conditions:
Developer shall design the Merchant Transmission Facility to operate within the voltage guidelines as specified in Article 9.5.2.
The nominal frequency of the New York State Transmission System is 60 Hz. The frequency may deviate by ± 0.05Hz from the nominal value during normal steady-state conditions. During extreme system disturbances, the system frequency may deviate from the nominal value by ± 0.07Hz. For very extreme disturbances such as system separation, frequency deviations may be ± 1.5Hz.
Connecting Transmission Owner typically operates the 345kV AC bus at a higher voltage than 1.0pu. Under infrequent operating conditions the system voltage may be reduced to less than 1.0pu and the system reactive requirements may be such that the Merchant Transmission Facility may reduce import levels during such conditions.
Detailed control system capabilities and features will be developed and agreed upon by the Developer, Connecting Transmission Owner, NYISO and PJM at the conclusion of the detailed equipment design of the Merchant Transmission Facility.
The primary control components, including their power supply and communications involved in the control of real power, reactive power, AC current, AC voltage, DC voltage, and DC current will be redundant with an active and standby system. The active and standby control components will be continuously monitored for proper operation and will transfer automatically from active to standby when faults are detected in the active system. The active and standby components will be continuously updated to minimize disturbances during and after transfers between the active and standby systems.
Transfer of DC or AC power supplies for the control system will not cause a disturbance to the operation of the Merchant Transmission Facility. Disturbances to or the loss of control of telecommunications channels will not cause unstable operation of the Merchant Transmission Facility.
General control features will include the following:
The converter station will be equipped with a supervisory control and data acquisition (“SCADA”) hardware I/O to interconnect with the Connecting Transmission Owner SCADA remote terminal unit (“RTU”) and dispatch system. Detailed SCADA I/O and RTU specifications will be mutually developed and implemented at a later date.
The Merchant Transmission Facility shall provide data to the Connecting Transmission Owner SCADA system for the purpose of monitoring key parameters such as 345kV voltage, bus frequency, real and reactive power flow into the AC system, line current, real-time indication of loading, and reactive bank status. Requirements for the communications between the Merchant Transmission Facility operators, NYISO, PJM, PSE&G, and Connecting Transmission Owner will be mutually developed and implemented at a later date, as necessary.
A local and remote operator control and communications conceptual diagram will be developed and included in the Merchant Transmission Facility design reports.
The Merchant Transmission Facility shall be designed and operated in accordance with Article 9.5 of this Agreement. In addition, the Merchant Transmission Facility shall maintain stable power transfer within a tolerance which is the lesser deviation of 3.0% or 6MW when the AC voltages and frequency vary.
The reactive compensation control system shall allow the AC bus voltage at the West 49th Street 345kV Substation 345kV bus to be regulated to within 0.02p.u relative to the voltage regulation set point when in AC bus voltage regulation mode, at any power transfer within the Merchant Transmission Facility system normal capacity, and subject to the constraints of the total installed reactive supply and reactive absorption capability. Reactive absorption capacity comprises 1 shunt reactor. The voltage set point shall be selectable between 0.95pu and 1.05pu.
Continuous operation of the Merchant Transmission Facility system shall not be disrupted by the following minor disturbances.
Disruption of continuous operation shall be defined as an inverter commutation failure, or as any deviation from the pre-disturbance power transfer greater than 50% of the pre-disturbance value for a duration in excess of 0.02 seconds. The above shall apply for the normal range of short-circuit capacity.
Operation of the Merchant Transmission Facility may be temporarily suspended for disturbances more severe than defined in Minor AC Voltage Disturbances above. Unless the voltage disturbance at either terminal of the Merchant Transmission Facility exceeds the extreme disturbance criteria listed in Criteria for Permanent Blocking and Tripping below, the Merchant Transmission Facility shall commence recovery within one cycle of the recovery of the PJM and New York State Transmission System voltage to a value greater than 0.8pu in all phases.
The Merchant Transmission Facility system shall be permitted, but not required, to trip for the following extreme system conditions:

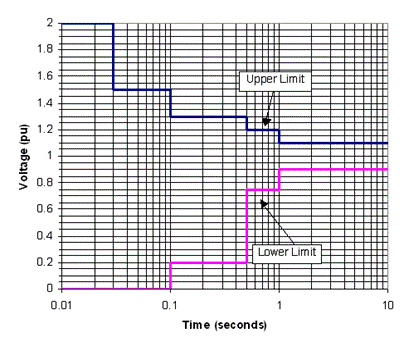

Figure G-1 Voltage thresholds for permanent blocking and converter station tripping

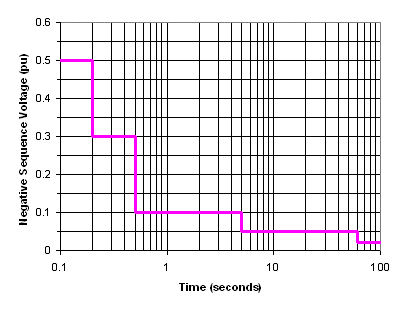

Figure G-2 Voltage imbalance (negative sequence component) threshold for permanent blocking and converter station tripping.
Figure G-3 Fundamental frequency deviation threshold for permanent blocking and converter station tripping
The response of the power controls to manual or automatic modifications in power order shall be prompt and stable. Any oscillatory performance of the power transfer shall be well damped with an overshoot no more than 10% of the requested change. Reactive power balance shall be maintained during routine power ramping operations. If discrete changes in active power are necessary while ramping between power levels the discrete changes will not exceed 25MW.
During contingency conditions power transfers may need to be reduced substantially and rapidly. The action of reducing the power transfer in response to an externally provided trigger is called power runback. The design of the Merchant Transmission Facility shall allow for pre‑programmed power runback levels. Runback execution shall not require a reversal of power direction.
When transition to a specified or predetermined runback level is requested, power shall be reduced to the programmed runback level at a programmable rate no less than 500 ms. The available runback rates shall allow runback to be completed as fast as 500 ms from the receipt of the runback signal by the Merchant Transmission Facility system. (The runback levels are maximum power limits; if the Merchant Transmission Facility is dispatched to less than the runback level at the time of runback command, no power change is necessary.) If a runback level of less than 60MW is specified, the Merchant Transmission Facility will be allowed to trip upon receipt of the runback signal.
To the extent runback or special protection systems are required; Developer shall be responsible for obtaining the appropriate approvals and is responsible for all systems costs including maintenance. Any runback or special protection systems shall conform to applicable Connecting Transmission Owner, NYISO, and NPCC standards, as applicable.
Following any disturbance that causes the Merchant Transmission Facility to deviate from the initial equilibrium AC and DC conditions, the Merchant Transmission Facility shall be controlled toward an acceptable equilibrium as rapidly as possible. The post-disturbance equilibrium conditions shall be identical to the pre-disturbance conditions if there is no change in the AC system state. If there are changes to the AC system state, such as opening of a line, then the post-disturbance Merchant Transmission Facility equilibrium condition may or may not be identical to the pre-disturbance conditions. Recovery performance, as used within this Technical Specification, refers to the action of resuming the pre-disturbance equilibrium conditions or successfully readjusting Merchant Transmission Facility operation to accommodate changes in the AC system caused by the disturbance. The actual values and set points for the performance characteristics described in this section will be determined as part of Merchant Transmission Facility final design.
Recovery time is defined as the elapsed time from the instant of disturbance initiation until the Merchant Transmission Facility is within 10% of the lesser of the dispatched power order or the achievable power transfer as limited by the AC voltage magnitude, and the reactive power interchange with the AC system at the West 49th Street 345kV Substation 345kV bus is within ±100MVAR of the expected post-disturbance value. If the initiating disturbance is a fault causing any phase voltage at either the PSE&G Bergen 230kV AC bus or the West 49th Street 345kV Substation 345kV AC bus to decrease below 80% of the pre-disturbance value, then recovery time shall be measured from the time of fault clearing.
5.6.3 Commutation Failure Recovery
The Merchant Transmission Facility shall recover from commutation failures, other than those caused by faults reducing inverter AC bus voltage to less than 80% of the pre-disturbance value, within 250 ms without subsequent commutation failures or sustained oscillations.
The Merchant Transmission Facility system operation, if disrupted by an AC system fault, shall recover from such faults in 350 ms without subsequent commutation failures or sustained oscillations.
5.6.5 Irrecoverable Faults
The Merchant Transmission Facility shall not be required to recover from the following:
Developer shall take immediate action to correct any situation causing the Merchant Transmission Facility system to fail to meet the disturbance recovery performance requirements.
Developer shall ensure that the Merchant Transmission Facility’s control performance is stable for all foreseeable AC system conditions, including any single or double contingencies on either the PJM or NYISO systems. Developer is responsible for determining the range of short-circuit capacities at the terminals, for any single or double contingency outages including failure of special protective systems. Developer shall ensure that harmonic instabilities, including core saturation instability, will not occur.
Stable control performance shall be defined as adequately damped performance, free of persistent oscillations in real or reactive power into the West 49th Street 345kV Substation 345kV AC bus. In addition, stable control performance shall require that the Merchant Transmission Facility system shall not suffer repetitive commutation failures.
If system conditions are found to create system control or harmonic instability in the Merchant Transmission Facility control system, including those reducing the short-circuit capacity below the calculated minimum post-contingency short-circuit capacity at the West 49th Street 345kV Substation 345kV AC bus, or the PSE&G Bergen 230kV AC bus, then adequate protective functions shall be included in the Merchant Transmission Facility system design to detect the instability and promptly trip the Merchant Transmission Facility system or take other effective corrective action.
(a) A detailed Dynamic Performance Study (“DPS”) shall be performed to verify that the response to disturbances does not cause instability in the Merchant Transmission Facility, does not cause conditions that will damage the equipment and does behave according to the Merchant Transmission Facility design.
The DPS report shall provide descriptions of the performance to the cases listed below where applicable. The case descriptions shall include the simulation setup and plots of relevant AC and DC quantities. System data needed for the simulations described below shall be obtained from Connecting Transmission Owner.
1. DPS Case
2. Simulation Setup
Certain design verification studies, including, but not limited to the following, require use of cycle-by-cycle simulation using a transient network analyzer, special purpose simulator or a digital computer program equivalent:
Reactive power support shall be provided as specified in Article 9.5 concurrently with meeting all harmonic performance requirements.
Energization/de-energization of the Merchant Transmission Facility system terminal equipment, including AC cables, and routine switching of supplemental reactive compensation equipment (capacitors and reactors) must not cause transients and sustained changes in the voltage that may be considered power quality violations.
The limitation to voltage change on switching specified above shall not apply to station energization. During station energization, voltage change will be limited to 3.5% or 0.035pu. At no time will the fundamental-frequency voltage be raised above 1.05pu of 345kV, or lowered below 0.95pu at the West 49th Street 345kV Substation 345kV bus by any reactive bank or cable switching, including banks or cables switched during energization.
In order to reduce the impact of reactive bank and AC cable switching on sensitive loads, the severity of voltage transients due to switching shall be minimized. Equipment switching at the converter station or the 345kV AC cable interconnecting this terminal with West 49th Street 345kV Substation, including switching of capacitor banks, harmonic filters, AC cables, and shunt reactors, shall be performed using point-on-wave synchronous switching. Switching of the Merchant Transmission Facility at the West 49th Street 345kV Substation shall be performed using pre-insertion resistors. The closing time tolerance for synchronous switching shall be 1 ms. However, the closing time tolerance may be as high as 1.5 ms for operation during ambient temperature conditions of less than -10 C .
Switching of a reactive compensation bank, if required, at either converter terminal shall not interfere with the control and continuity of power transfer on the Merchant Transmission Facility system or disrupt normal control of power transfer or voltage regulation at the converter terminals.
Binary switching, which is the approximately simultaneous switching of more than one reactive compensation bank or cable, shall not be used to achieve voltage change on switching requirements.
To maintain real and reactive power levels within the range set forth in Article 9.5.1, an automatic reactive power control system including discrete reactive bank switching shall be provided with the following two control modes:
1. AC bus voltage regulation. In this mode, an incrementally switched or continuously controlled source of reactive power is adjusted to maintain the AC bus voltage at the West 49th Street 345kV Substation 345kV bus within the range set forth in Article 9.5.1. The set points this control mode will be adjustable, and shall be set according to directives from the responsible Connecting Transmission Owner system dispatcher. The design of the reactive compensation system shall allow the AC bus voltage at the West 49th Street 345kV Substation 345kV bus to be regulated to within 0.02pu relative to the voltage regulation set point at any power transfer within the Merchant Transmission Facility system normal capacity, subject to the constraints of the total installed reactive supply and reactive absorption capability.
2. Reactive power exchange regulation. In this mode, the incrementally switched or continuously controlled source of reactive power is adjusted to maintain the reactive power exchange with the AC system at the West 49th Street 345kV Substation 345kV bus within the range set forth in Article 9.5.1. This control mode shall be effective only if the West 49th Street 345kV Substation 345kV AC bus voltage is within the prescribed range of 0.95pu to 1.05pu. If the converter station is operating in reactive power exchange regulation mode, and the AC voltage at the West 49th Street 345kV Substation 345kV bus either falls below a low-voltage threshold, or increases above a high-voltage threshold, the control mode shall automatically switch to the AC bus voltage regulation mode. Reactive power exchange limits shall be adjustable based on real time system conditions.
The reactive power controls shall ensure at all times that the harmonic filters, required to meet the performance specified in accordance with IEEE Standard 519, are energized. The harmonic filter requirement shall take precedence over the automatic voltage and reactive power exchange control modes, unless the minimum equipment to meet harmonic requirements cause the voltage at the POI to exceed 1.05pu of 345kV. For the expected range of normal conditions, sufficient reactive absorption shall be installed to avoid this situation.
Any equipment de-energized for any reason except for protective tripping or removal from service for maintenance shall be available for re-energization within five minutes.
The following performance indices are to be met by the Merchant Transmission Facility during normal operation. All performance indices reflect the incremental contribution of the Merchant Transmission Facility. Normal operation is defined as follows:
The AC harmonic filters shall be designed in accordance with the performance criteria below, as measured at the POI for the frequency range from 60 to 3kHz.
The performance criteria for normal operation shall be met over the entire normal power transfer range in rectifier and inverter operation.
The performance criteria shall be met considering combined detuning effects on tuned filters caused by frequency and temperature variations.
The voltage distortion caused by the Merchant Transmission Facility at the Connecting Transmission Owner 345kV bus of the West 49th Street Substation shall be:
Telephone interference shall be limited by the telephone influence factor (“TIF”) as defined in Section 13.2 of the “Electric Power Research Institute High-Voltage Direct Current Handbook.” Power quality of the associated filtering systems shall be such that the incremental contribution of TIF associated with the Merchant Transmission Facility at the Points of Interconnection shall be based on a design goal not to not exceed 40.
Developer shall determine the Merchant Transmission Facility operating conditions which produce worst case harmonic generation.
Imbalances leading to non-characteristic harmonics shall be considered as follows:
Developer shall provide a procedure to measure the harmonic voltages and currents at the interconnection with the West 49th Street 345kV Substation 345kV bus as part of the commissioning test program.
Developer may implement independent monitoring of the performance indices at its own discretion.
The Merchant Transmission Facility will include AC high frequency filters. The following four general frequency ranges shall be considered in the design of the filters:
PLC systems exist on the Connecting Transmission Owner System. In addition to potential interference due to noise injected by the converters in the PLC channel frequency range from 30kHz to 400kHz, PLC receiver input overload due to energy in the 4kHz to 10kHz region shall be avoided. The proposed equipment comprising the Merchant Transmission Facility system shall be designed to avoid interference with PLC systems due to any injected electrical noise or harmonics, even if this interference is outside of the PLC channel frequency range. Interference in the frequency range of 30kHz to 200kHz should be especially avoided.
Harmonic and electrical noise conducted or radiated from the Merchant Transmission Facility system shall not interfere with any PLC system, including interference to PLC operation via input stage overload due to energy outside of the carrier frequency range. The contribution to voltage across the drain coils of PLC coupling capacitors shall be less than 5% of their design maximum.
Developer shall predict maximum PLC interference voltage on the West 49th Street 345kV Substation 345kV bus.
The temporary overvoltages (“TOV”) potentially caused by the Merchant Transmission Facility system shall be defined to include, but not be limited to, all voltage components resulting from the following causes:
1. Fundamental-frequency voltages resulting from capacitive compensation in excess of the system requirements, or excess uncompensated AC cable charging capacitance;
2. Harmonic voltages caused by saturation of any transformer or reactor within the Merchant Transmission Facility system, including both symmetric saturation caused by excess applied voltage, and asymmetric saturation resulting from flux offset during disturbances or from direct current injected by any power electronic device or converter included in the Merchant Transmission Facility,
3. Harmonic voltages caused by characteristic and non-characteristic harmonics injected into the AC system by any component of the Merchant Transmission Facility, particularly during unbalanced faults on the interconnecting AC systems, and
4. Overvoltages caused by control failure or other mis-operation of the Merchant Transmission Facility.
5. Overvoltages caused by Very High Frequency (“VHF”) surges resulting from switching West 49th Street 345kV Substation GIS equipment.
The magnitude and duration of temporary overvoltages shall be quantified by the temporary overvoltage envelope. The temporary voltage envelope for a given bus is defined as the plot of voltage versus time, for which the voltage value at any instant of time is the maximum instantaneous pu value of any phase-to-ground or phase-to-phase voltage magnitude (absolute value) during the preceding 16.6666 milliseconds. The crest voltage base for per-unitization of phase-to-ground voltages is times the nominal line-to-line rms voltage, and the base for phase-to-phase voltages is
times the nominal line-to-line rms AC bus voltage.
Temporary overvoltage duration limitations in this specification are cumulative for a related sequence of events. A related sequence of events is defined to be all events occurring as a consequence of an initiating AC or DC system contingency, including failure of primary TOV control equipment. Repeated faults caused by unsuccessful reclosing into a faulted line or other AC system component, however, shall be considered as individual fault events.
9.4 Temporary Overvoltage Limits
The Merchant Transmission Facility is not expected to cause unacceptable fundamental-frequency overvoltages on the interconnected 345kV transmission system.
Overvoltage duration shall be defined as the total cumulative period of time that the TOV envelope is at or above the given magnitude as a result of any single event or related sequence of events. This requirement shall be met for events and conditions including, but not limited to the following:
1. AC faults and fault recovery, including faults in the PJM transmission system, faults involving the Merchant Transmission Facility system itself, as well as faults in the NYISO AC transmission system;
2. Tripping radial AC circuits that tie the Merchant Transmission Facility to the PJM or NYISO transmission systems. This includes interruptions that only last for the dead time prior to automatic line reclosing, as well as lockouts for which the Merchant Transmission Facility can be shut down;
3. Events for which the Merchant Transmission Facility is tripped; and
4. Transformer energization.
The strategy for temporary overvoltage limitation must not limit post-disturbance AC reactive compensation capabilities to less than specified in Appendix G, Section 9.1. If reactive equipment tripping is used for TOV control, the equipment shall be available for re-energization in accordance with Appendix G, Section 6.7.3. If AC faults, on the Connecting Transmission Owner or PJM system reduce the AC voltage at either the POI or the 230kV PJM interconnection to a magnitude less than 50% of nominal positive sequence voltage for a duration longer than 100 ms this requirement shall not apply.
Any reactive power equipment tripping shall be performed using switchgear rated to perform the switching at the maximum voltage present prior to de-energization.
The HVDC converter may be used to control temporary overvoltages. If operation of the converter during and after disturbances is critical to meeting the temporary overvoltage specification, the Developer shall provide the following information:
1. Study results showing the temporary overvoltage performance considering direct current discontinuities which may occur, including those caused by distortion and mis-synchronization of valve firing following bolted AC faults at either converter.
2. Explanation and demonstration of temporary overvoltage performance for all cases where converters are to be blocked, including tripping of the PSE&G 230kV line in New Jersey, from which the AC connection to the converter station is made, converter faults, and DC cable faults; with due consideration of all telecommunication delays, signal processing times, relay operating times, and breaker operating times.
Failure of a single temporary overvoltage control equipment, including the Converter Station, shall not cause the overvoltage criteria to be exceeded.
Operation shall not be permitted without the Connecting Transmission Owner AC system protected from temporary overvoltages by a redundant overvoltage control scheme. This shall be interpreted as allowing power transfer with either or both the primary or backup temporary overvoltage control equipment unavailable, only up to the transfer for which the required reactive compensation cannot cause fundamental frequency overvoltage in excess of 1.05pu at the West 49th Street 345 kV Substation 345kV bus.
Overvoltage protective devices at the converter station and at the POI shall be coordinated with the overvoltage protective devices (surge arresters) installed such that overvoltages, caused by excess reactive power flow from the Merchant Transmission Facility system into the Connecting Transmission Owner AC power system, and switching transient overvoltages, caused by switching of reactive banks or switching of the Merchant Transmission Facility system itself shall not cause duty in excess of the capability of any existing surge arresters. Details of the existing surge arresters in the West 49th Street Substation will be obtained from Connecting Transmission Owner.
Insulation levels of the Merchant Transmission Facility shall include minimum margins above surge arrester protection levels as follows:
Developer shall provide to NYISO , PJM, and Connecting Transmission Owner the results of the insulation coordination study for review as specified in Appendix C, section 6(f). The study shall assure that the equipment as described in Appendix C, section 1(b)(4), the DAF and the West 49th Street Substation are properly insulated and that the insulation systems are properly coordinated. The study shall include the insulation coordination philosophy, the limiting cases, surge arrester currents for coordination purposes, equipment insulation levels, surge arrester locations, and the resulting protection margins.
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
NYISO Agreements --> LGIA Among NYISO, Con Edison, and HTP
APPENDIX H
Project Principles
(c) Pursuant to Section 9 of Attachment X of the NYISO OATT, Connecting Transmission Owner and Developer agreed that Connecting Transmission Owner would provide engineering and procurement services prior to the execution of this Agreement. The terms of that agreement are set forth in the Master Services Agreement Transaction Form 2 (“TF2”) dated October 27, 2010. As of the Effective Date of this Agreement, Connecting Transmission Owner had completed all of the Con Edison Services specified in TF2 except the service specified in Section 2.2 involving the preparation of technical specifications and bid documents for the solicitation an evaluation of vendor proposals for long lead items associated with the interconnection.
(d) TF2 is terminated as of the Effective Date of this Agreement. After the Effective Date, Connecting Transmission Owner will continue and complete the service specified in Section 2.2 of TF2 in accordance with the terms of this Agreement, notwithstanding Appendix H, Section 2. In accordance with TF2 Section 6, Developer provided a deposit of $100,000 as an advance payment for Connecting Transmission Owner’s services under TF2. Connecting Transmission Owner drew on that amount as it incurred costs under TF2 prior to the effective date of this Agreement. Connecting Transmission Owner will treat the remainder of that deposit as a component of SUF security available as of the Effective Date, and will invoice Developer for such work as Connecting Transmission Owner completes the service specified by Section 2.2 of TF2 under Article 12 of this Agreement.
2. Security
The Connecting Transmission Owner will not be required to commence any work under this Agreement until one of the following occurs: (1) the New York Power Authority (“NYPA”) grants its approval for all work to proceed for the project, or (2) the Developer provides substitute Security in the form of (i) cash or (ii) a letter of credit in a form and from a credit-worthy issuer reasonably acceptable to the Connecting Transmission Owner.
3. Construction
(a) System Upgrade Facilities
1. Connecting Transmission Owner will acquire all permits necessary for the construction of SUFs and will construct the SUFs within Connecting Transmission Owner’s property boundaries consistent with Connecting Transmission Owner’s Engineering and Construction Standards.
2. The Connecting Transmission Owner will provide assistance to Developer during the installation and commissioning the three new GIS cable termination compartments for Developer’s provided and installed cable terminations, as well as three new single pole disconnect switches for Developer’s cable testing.
3. Connecting Transmission Owner shall provide and install the relay protection equipment and corresponding equipment associated with the SUFs. The requirements in Article 9.6.4.6 of this Agreement, that Developer and Connecting Transmission Owner perform tests of the System Protection Facilities by certain dates and at certain intervals, will be satisfied by the performance of such tests in a manner and at intervals consistent with Connecting Transmission Owner’s standard practice for performing such tests, and in accordance with NERC, RFC and NPCC compliance requirements.
4. Protective relaying system commissioning and testing for that equipment associated with the DAF will be jointly performed by the Developer for that equipment associated with the DAF and by Connecting Transmission Owner’s Protective System Testing group (“PST”) for the protective relay systems associated with the SUFs. PST will also perform the functional testing of the SUFs substation automation system and acceptance testing with respect to affected primary equipment, including, but not limited to, the following: circuit breakers, disconnect switches, instrument transformers, surge arrestors, and light and power transformers. All disconnection or connection in any live or existing relay cabinets and corresponding equipment will be performed by Connecting Transmission Owner’s Electric Construction Bureau (“ECB”). Any testing at remote-end Connecting Transmission Owner substations also required will be performed by Connecting Transmission Owner personnel.
(b) Developer Attachment Facilities
1. Developer shall design, provide, procure, construct, install and commission the DAF as defined in Appendix A, including all cable, GIS terminations, cable supporting structures and raceways up to the Point of Interconnection.
2. Developer will acquire all permits and easements necessary for the construction of the DAF on Connecting Transmission Owner’s property and will construct the DAF within the Connecting Transmission Owner’s property boundaries consistent with Connecting Transmission Owner’s Standard Terms for Construction Projects, Environmental, Health and Safety requirements, and Engineering specifications and requirements. Developer and Connecting Transmission Owner will enter into an easement or similar authorization acceptable to Connecting Transmission Owner and New York Public Service Commission for the location of Developer’s DAF in the West 49th Street Substation.
3. Developer shall coordinate with Connecting Transmission Owner to ensure proper interface of the DAF with the Connecting Transmission Owner designed and installed termination stand, its accessories and GIS equipment associated with Developer’s DAF.
4. The Developer’s cable supplier will furnish the pothead and connectors required to attach to the GIS buswork. Connecting Transmission Owner and Developer will design and coordinate the assembly of these components.
5. Developer will construct the DAF up to the point when they are ready for connection to Connecting Transmission Owner constructed and tested SUFs. Promptly after Developer has completed that construction, Connecting Transmission Owner will (i) make the final connection of the DAF and SUFs to its existing facilities and (ii) complete any agreed-upon remaining construction work required for the SUFs.
6. Once the Developers detailed equipment design is completed and has identified the required AC and DC control power to the DAF interface panel needs, the Connecting Transmission Owner will evaluate the need to expand the existing ancillary systems (AC and DC power panels ground grid, paging system, and load boards, etc.). The Connecting Transmission Owner shall provide AC and DC control power to the interface cabinets for the DAFs listed in Appendix A if needed.
7. Developer shall coordinate the work and the equipment testing of the DAF with the Connecting Transmission Owner to support the Milestone Dates.
8. Developer shall coordinate the procurement, installation, and testing of corresponding relay protection equipment and corresponding equipment at the sending end of the Merchant Transmission Facility.
9. The DAF may be required to be constructed in several segments. Developer and Connecting Transmission Owner shall coordinate their respective work so as to allow for these work segments. If the work on the DAF progresses ahead of schedule or is delayed, Connecting Transmission Owner will endeavor to reschedule necessary outages in accordance with the NYISO Procedures, taking into consideration system outages and conditions on the system, in an attempt to complete the project expeditiously.
(c) Commissioning and Trial Operation - The commissioning test program prescribed for the Merchant Transmission Facility and the DAF will progress over an approximate seven month schedule in the following stages:
1. Prior to the In-Service Date, Developer will perform extensive de-energized equipment testing that will progress from individual components including circuit breakers, transformers, valve assemblies, instrumentation devices, etc., and subsystem tests including high voltage cables; relay and communication devices; control systems, etc. into system tests such as relay, communication, controls, cooling systems, etc. This will include relay and communication tests interfacing with both Connecting Transmission Owner and PSE&G. Estimated duration for this effort is two months;
2. On the Initial Synchronization Date, no load and low power level testing will be performed to further verify subsystem performance;
3. Under partial and full load tests, system characteristics will be verified and measured, including heat runs; simulated fault testing; and commutation failures. Duration for this effort is approximately 2 ½ months;
4. Developer will perform a hipot acceptance test on the 345kV cable to include the Merchant Transmission Facility and DAF;
5. The final stage is a seven day, continuous operation with no forced outage period within the seven days period.
(d) Project Management and General Responsibilities
1. Connecting Transmission Owner and Developer will create a joint steering committee, consisting of representatives of affected departments, to oversee all aspects of the scoping, engineering, design, construction and commissioning of the SUFs and DAF. The Project Steering Committee will include the Connecting Transmission Owner’s Project Manager and Project Engineer and such other members as Developer and Connecting Transmission Owner will appoint. The Project Steering Committee will conduct conference calls every two weeks (or more frequently, as needed) and convene meetings as needed or on a mutually agreed basis. The Project Steering Committee will develop a project management plan that will outline members’ responsibilities, communication protocol, submittal of project status reports, etc.
2. Connecting Transmission Owner and Developer will work together to develop specific facility outage sequencing and cutover procedures. Work requiring an equipment outage will be performed in accordance with the NYISO’s and Connecting Transmission Owner’s system operations and outage scheduling practices and procedures. Outage scheduling and construction activities are contingent upon NYISO outage scheduling requirements, system conditions of Connecting Transmission Owner’s bulk power system and applicable regulatory requirements.
3. Developer shall arrange with Connecting Transmission Owner for the provision of on-site power needed for the construction of the DAF within Connecting Transmission Owner facilities. Developer will specify the voltage and load of the electric load needed and will provide all down-stream wiring and equipment consistent with electrical codes and safety practices.
4. Developer shall arrange with Connecting Transmission Owner for the use of existing, or supply of temporary water and sanitary facilities that may be needed during construction on the DAF within Connecting Transmission Owner facilities.
5. Developer shall provide Connecting Transmission Owner details of the construction and cable pulling methods and tooling so the Connecting Transmission Owner can determine if there are adverse impacts to the operations of the substation.
6. Developer will be responsible for site access control of its vehicles and personnel during working hours at designated access points for the Connecting Transmission Owner facilities in coordination with designated Connecting Transmission Owner personnel. Developer will be responsible for security of its stored material and temporary offices at all times. Although Connecting Transmission Owner will be responsible for overall substation security at all times, Connecting Transmission Owner is not responsible for Developer’s materials and tools.
7. In accordance with Article 24 of this Agreement, Developer and Connecting Transmission Owner shall submit to each other and the NYISO a monthly status report on the construction and installation of the SUFs and DAF for which each Party is responsible per this Attachment H. Such monthly reports shall be provided on the 20th of every month (or next calendar day if the 20th falls on Holiday or weekend) after the Effective Date of this Agreement.
Attachments to Appendix H:

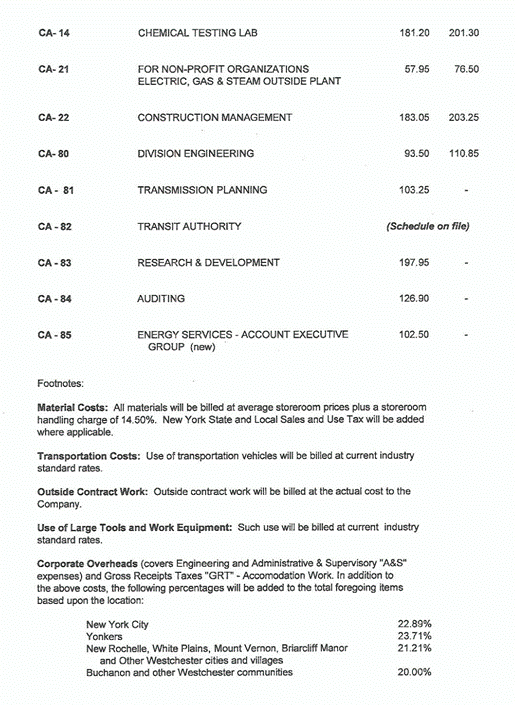

H-1 Connecting Transmission Owner Rates for Accommodation Services
H-1 Con Edison Rates for Accommodation Services
Effective Date: 4/20/2011 - Docket #: ER11-3479-000 - Page 1
