NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge













FERC rendition of the electronically filed tariff records in Docket No.  ER20--000

Filing Data:

CID: C000038

Filing Title: Engineering Fees Reimbursement Agreement between NYSEG and Greenidge Generation Company Filing Identifier: 1538

Type of Filing Code:  10

Associated Filing Identifier: [if applicable]
Tariff Title: NYISO Agreements
Tariff ID: 58

Payment Confirmation: N
Suspension Motion:



Tariff Record Data:

Record Content Description: Agreement No. 2492

Tariff Record Title: Engineering Fees Reimbursement Agreement - NYSEG & Greenidge Record Version Number: 0.0.0

Option Code: A

Tariff Record ID: 257

Tariff Record Collation Value:8086300

Tariff Record Parent Identifier: 2

Proposed Date: 2019-10-18

Priority Order:500

Record Change Type:  New
Record Content Type:  2

Associated Filing Identifier:  [Source - if applicable]

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492





CUI//CEII - REDACTED VERSION CUI//CEII - REDACTED VERSION
Service Agreement No. ___

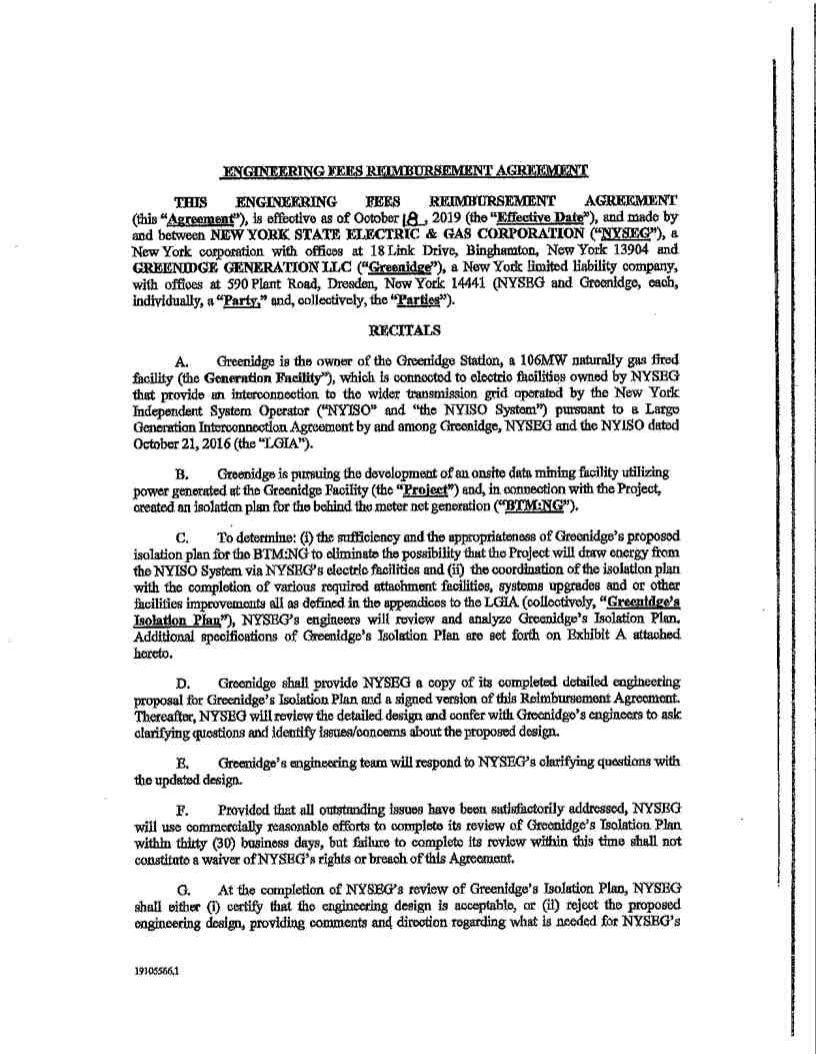

ENGINEERING FEES

REIMBURSEMENT AGREEMENT
By and Between

NEW YORK ELECTRIC & GAS CORPORATION
AND

GREENIDGE GENERATION LLC

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492







H. Greenidge will reimburse NYSEG for the costs and expenses NYSEG incurs during NYSEG engineers’ review and analysis of Greenidge’s Isolation Plan.

I. The Parties acknowledge and agree that NYSEG’s review and certification of Greenidge’s Isolation Plan shall not be construed as confirming, endorsing, or providing a warranty as to the design, fitness, safety, durability or reliability of the Large Generating Facility, or Greenidge’s Isolation Plan.  Greenidge shall make such changes to Greenidge’s Isolation Plan as may reasonably be required by the NYISO, in accordance with Good Utility Practice, to ensure  it  is  compatible  with  the  technical  specifications,  operational  control,  and  safety requirements of NYSEG and the NYISO.

J. Each of the Parties, having done all things necessary to constitute this Agreement
a valid and binding agreement by and between them, and in all respects, having duly authorized
the creation, execution, and delivery of this Agreement, agrees to the terms and conditions of this
Agreement.

DEFINITIONS

1. Appropriate  Fees  means  all  reasonable  engineering  costs  and  expenses incurred  by  NYSEG  to  review  Greenidges  Isolation  Plan  and  invoiced  to  Greenidge  in compliance with this Agreement.

2.Authorized Signatory means the individual designated by NYSEG and the

individual designated by Greenidge to sign this Agreement on behalf of NYSEG and Greenidge,

respectively.

3.Force Majeure Event means any event outside the commercially reasonable

control of the Parties that prevents a Party from timely fulfilling its obligations pursuant to this

Agreement.

4. Repayment Period means the sixty (60)-calendar day period immediately following Greenidge’s receipt of a written invoice sent to Greenidge by NYSEG via by first class, United States mail seeking payment of accrued Appropriate Fees.

ARTICLE I.

REIMBURSEMENT OF ENGINEERING FEES

Section 1.01   The Recitals and Definitions, by reference, are part of this Agreement.

Section 1.02   NYSEG will provide proper documentation, including, but not limited to, receipts and descriptions of services rendered, with each invoice for Appropriate Fees.

Section 1.03   Greenidge acknowledges and accepts its obligation to reimburse NYSEG for any and all Appropriate Fees.





2

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492







Section 1.04   Greenidge’s obligation to reimburse NYSEG for Appropriate Fees is not and will not be contingent or dependent on approval of or success of the Project.

Section1.05    Greenidge  will  reimburse  NYSEG  for  Appropriate  Fees  within  the Repayment Period.

Section 1.06   If Greenidge fails to reimburse NYSEG for the Appropriate Fees within
the Repayment Period, Greenidge is responsible for any collection fees incurred by NYSEG.

Section 1.07   Prior to referring any past due Appropriate Fees for collection, NYSEG
must give Greenidge thirty (30)-days’   prior written notice, which notice must clearly state the
amount of past due Appropriate Fees.  If the past due Appropriate Fees remain outstanding after
the expiration of such thirty (30)-day period, NYSEG may refer the amounts for collection.





ARTICLE II.

TERM

This Agreement is effective as of the Effective Date and will remain in effect, unless terminated earlier by written consent of the Parties, until NYSEG completes its review of Greenidge’s Isolation Plan and no Appropriate Fees are outstanding.





ARTICLE III.

FORCE MAJEURE EVENT

Section 3.01   Neither Party will be in breach of this Agreement or liable for any delay in or failure of its performance under this Agreement to the extent such delay or failure is due to a Force Majeure Event as long as:

(a) The Party claiming Force Majeure provides the other Party written notice

as soon as practicable after the claiming Party becomes aware of the Force Majeure Event; and

(b) The Party claiming Force Majeure proceeds with commercially reasonable

efforts to overcome the Force Majeure Event, and, within a reasonable time after giving notice of
the  Force  Majeure  Event,  which  may  not  exceed  ten (10)-calendar  days’,  provides  the
non-claiming Party written notice of those efforts and the estimated time for performance.

Section3.02    Any breach or other non-performance will be excused only for the duration of the Force Majeure Event plus seven (7) calendar days’.

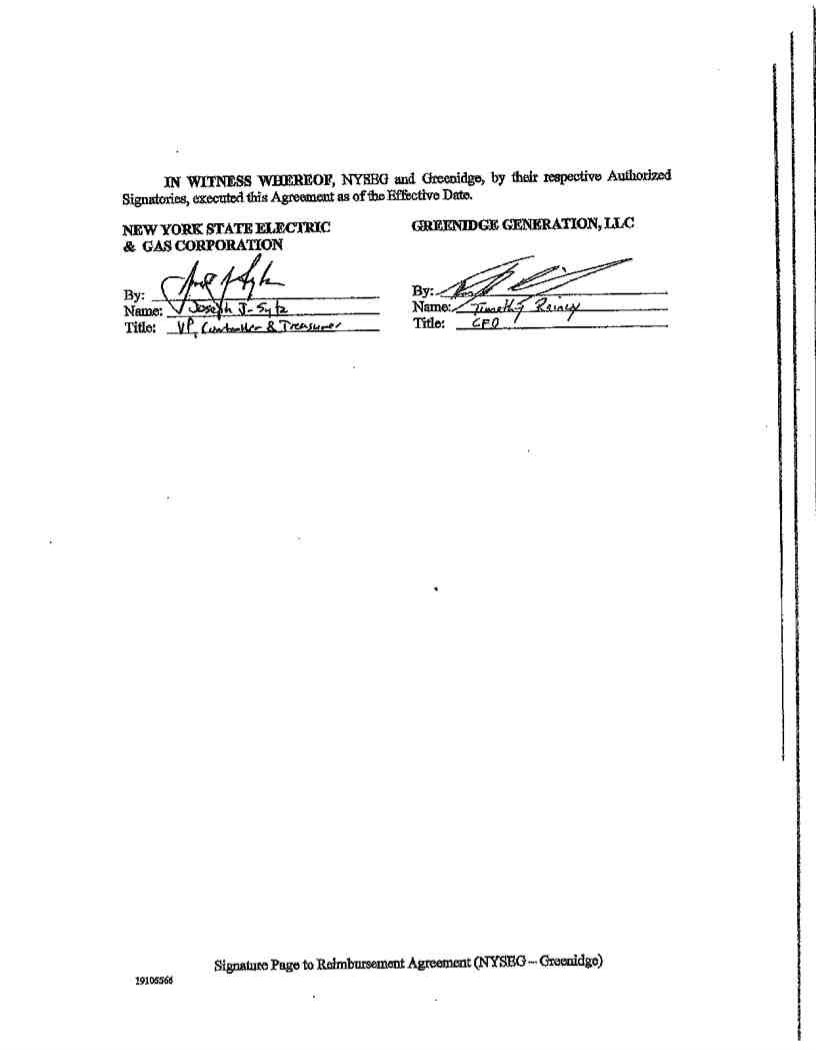

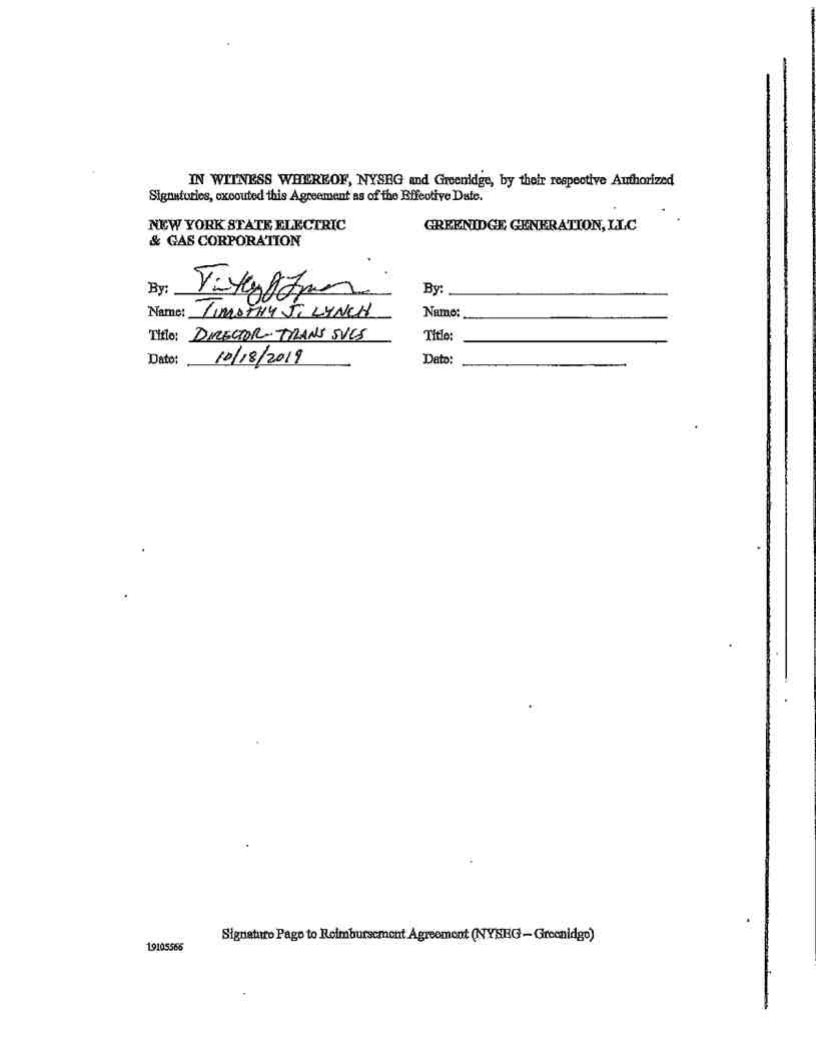

[There is no further text on this page.  The signature page follows.]











3

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492







EXHIBIT A

TO

REIMBURSEMENT AGREEMENT
Between

New York State Electric and Gas
And

Greenidge Generation LLC

















































































5

19105566.1

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492

"Exhibit A of this Engineering Fees
Agreement Contains Critical Energy
Infrastructure Information - Do Not
Distribute to Unauthorized Individuals"



Greenidge Generation: “Behind The Meter” Onsite Data Center





BACKGROUND

The Greenidge Generation LLC (“Greenidge”) plant located in Dresden, New York is a single

unit,107MW natural  gas  generator.  Greenidge Generation(“Greenidge”) has proposed to

for

the purpose of supplying additional, new onsite data center loads under the NYISO Behind the Meter Program.



The New York Independent System Operator (NYISO) has requested written confirmation from
NYSEG concerning Greenidge’s electrical system.  NYISO would like NYSEG to approve of
the Greenidge isolation plan, where the plant would never operate the Behind the Meter Load
with power from the grid. This summary document is provided to NYSEG to explain the
protection and control applications in this modification that impact the NYSEG system. A Plant
One Line drawing depicting the Relay and Metering setup is provided along with this summary.



THE CONCEPTUAL PLAN

The existing isolated-phase bus (“ISO phase bus”) will be modified to allow a tap connection to supply the new switchgear station bus

















































6

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

Service Agreement No. 2492



"Exhibit A of this Engineering Fees
Agreement Contains Critical Energy
Infrastructure Information - Do Not
Distribute to Unauthorized Individuals"





















































The following

logic depicts how the onsite load data center is prevented from drawing power from the NYSEG
grid.



































7

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge



Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge

"Exhibit A of this Engineering Fees
Agreement Contains Critical Energy
Infrastructure Information - Do Not

Distribute to Unauthorized Individuals"


Service Agreement No. 2492

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge













































It should be noted that while the Greenidge “Behind The Meter”   (“BTM”) project and the
NYSEG  Relaying  and  Metering  project  are  intended  to  be  constructed  within  the  same
timeframe, the two (2) projects are considered as separate except for the afore mentioned aspects.



In terms of the Behind-The-Meter project, two new meters will be installed. One will be installed on the high side of the existing station service transformer and the other will be installed on the switchgear feeder bus. From the NYSEG Interconnection project, a new meter was installed on the high side of the GSU. This metering scheme falls into the Option 2 category found in the NYISO Revenue Metering Requirements manual where the meter installed on the high side of the GSU is the net facility revenue meter and the meter installed on the station service and the new feeder bus will meter the gross load.

The meters that will be installed in the Behind-The-Meter project will be matched to the meter
that will be installed in the interconnection project, a TransData Mark V. These meters, along
with all CTs and VTs, were found in the New York State Public Service Commission (NYS
PSC) approved metering equipment manual. All equipment used for metering in this project will
fall  under  the  revenue  grade  category  as  determined  by  the  NYISO  Revenue  Metering
Requirements manual as well the NYS PSC approved metering equipment manual.



The metering scheme can be found in the

figures below.













8

Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1


NYISO Agreements --> Service Agreements --> Engineering Fees Reimbursement Agreement - NYSEG & Greenidge



"Exhibit A of this Engineering FeesService Agreement No. 2492

Agreement Contains Critical Energy

Infrastructure Information - Do Not

Distribute to Unauthorized Individuals"



































The highlighted sections in Figure 2 are the new meters installed for the interconnection project and the Behind-The-Meter project. The meter highlighted on the left of Figure 2 is the meter installed on the new gross load, the meter highlighted at the top is the meter installed on the high side of the station service transformer, and the meter highlighted on the right is the new meter installed on the high side of the GSU, confirming that the Behind-The-Meter project falls within Option 2 of the NYISO Revenue Metering Requirements.





















































9



Effective Date: 10/18/2019 - Docket #: ER20-376-000 - Page 1
