NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
STANDARD LARGE GENERATOR
INTERCONNECTION AGREEMENT
AMONG THE
NEW YORK INDEPENDENT SYSTEM OPERATOR, INC.,
NEW YORK STATE ELECTRIC & GAS CORPORATION
AND
HOWARD WIND, LLC
Dated as of February 11, 2011
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
TABLE OF CONTENTS
Page No.
ARTICLE 1. DEFINITIONS....................................................1
ARTICLE 2. EFFECTIVE DATE, TERM AND TERMINATION...................12
2.1Effective Date. ..................................................12
2.2Term of Agreement. .............................................12
2.3Termination. ...................................................12
2.4Termination Costs. ..............................................12
2.5Disconnection. ..................................................13
2.6Survival. .......................................................13
ARTICLE 3. REGULATORY FILINGS.........................................14
3.1Filing. .........................................................14
ARTICLE 4. SCOPE OF INTERCONNECTION SERVICE........................14
4.1Provision of Service. .............................................14
4.2No Transmission Delivery Service. .................................14
4.3No Other Services. ..............................................15
ARTICLE 5. INTERCONNECTION FACILITIES ENGINEERING, PROCUREMENT,
AND CONSTRUCTION......................................................15
5.1Options. .......................................................15
5.2General Conditions Applicable to Option to Build. ....................17
5.3Liquidated Damages. ............................................18
5.4Power System Stabilizers. ........................................19
5.5Equipment Procurement. .........................................19
5.6Construction Commencement. ....................................20
5.7Work Progress. ..................................................21
5.8Information Exchange. ...........................................21
5.9Limited Operation. ..............................................21
5.10Developer’s Attachment Facilities (“DAF”). .........................21
5.11Connecting Transmission Owner’s Attachment Facilities Construction....22
5.12Access Rights. ..................................................23
5.13Lands of Other Property Owners. ..................................23
5.14Permits. .......................................................23
5.15Early Construction of Base Case Facilities. ..........................23
5.16Suspension. ....................................................24
5.17Taxes...........................................................24
5.18Tax Status; Non-Jurisdictional Entities...............................30
5.19Modification.....................................................30
ARTICLE 6. TESTING AND INSPECTION.....................................31
6.1Pre-Commercial Operation Date Testing and Modifications. ...........31
6.2Post-Commercial Operation Date Testing and Modifications. ...........32
6.3Right to Observe Testing. .........................................32
6.4Right to Inspect. ................................................32
ARTICLE 7. METERING.....................................................32
7.1General. .......................................................32
7.2Check Meters. ..................................................33
7.3Standards. .....................................................33
7.4Testing of Metering Equipment. ...................................33
7.5Metering Data. .................................................34
ARTICLE 8. COMMUNICATIONS............................................34
8.1Developer Obligations. ...........................................34
8.2Remote Terminal Unit. ...........................................34
8.3No Annexation. .................................................35
ARTICLE 9. OPERATIONS...................................................35
9.1General. .......................................................35
9.2NYISO and Connecting Transmission Owner Obligations. .............35
9.3Developer Obligations. ...........................................35
9.4Start-Up and Synchronization. ....................................35
9.5Real and Reactive Power Control...................................36
9.6Outages and Interruptions.........................................37
9.7Switching and Tagging Rules. .....................................41
9.8Use of Attachment Facilities by Third Parties.........................41
9.9Disturbance Analysis Data Exchange. ..............................42
ARTICLE 10. MAINTENANCE................................................42
10.1Connecting Transmission Owner Obligations. .......................42
10.2Developer Obligations. ...........................................42
10.3Coordination. ...................................................42
10.4Secondary Systems. ..............................................42
10.5Operating and Maintenance Expenses. .............................43
ARTICLE 11. PERFORMANCE OBLIGATION.................................43
11.1Developer Attachment Facilities. ...................................43
11.2Connecting Transmission Owner’s Attachment Facilities. ..............43
11.3System Upgrade Facilities and System Deliverability Upgrades. .........43
11.4Special Provisions for Affected Systems. ............................43
11.5Provision of Security. ............................................44
11.6Developer Compensation for Emergency Services.....................44
11.7Line Outage Costs. ..............................................44
ARTICLE 12. INVOICE......................................................45
12.1General. .......................................................45
12.2Final Invoice....................................................45
12.3Payment. ......................................................45
12.4Disputes. .......................................................45
ARTICLE 13. EMERGENCIES................................................46
13.1Obligations. ....................................................46
13.2Notice. .........................................................46
13.3Immediate Action. ...............................................46
13.4NYISO and Connecting Transmission Owner Authority................46
13.5Developer Authority. ............................................47
13.6Limited Liability. ...............................................48
ARTICLE 14. REGULATORY REQUIREMENTS AND GOVERNING LAW........48
14.1Regulatory Requirements. ........................................48
14.2Governing Law...................................................48
ARTICLE 15. NOTICES......................................................48
15.1General. .......................................................48
15.2Billings and Payments. ...........................................49
15.3Alternative Forms of Notice. ......................................49
15.4Operations and Maintenance Notice. ...............................49
ARTICLE 16. FORCE MAJEURE.............................................49
16.1Force Majeure...................................................49
ARTICLE 17. DEFAULT.....................................................50
17.1Default..........................................................50
ARTICLE 18. INDEMNITY, CONSEQUENTIAL DAMAGES AND INSURANCE....50
18.1Indemnity. ......................................................50
18.2No Consequential Damages. .......................................52
18.3Insurance. .....................................................52
ARTICLE 19. ASSIGNMENT.................................................54
19.1Assignment. ....................................................54
ARTICLE 20. SEVERABILITY................................................55
20.1Severability. ....................................................55
ARTICLE 21. COMPARABILITY.............................................55
21.1Comparability. .................................................55
ARTICLE 22. CONFIDENTIALITY............................................55
22.1Confidentiality. .................................................55
ARTICLE 23. ENVIRONMENTAL RELEASES..................................59
23.1Developer and Connecting Transmission Owner Notice. ...............59
ARTICLE 24. INFORMATION REQUIREMENT................................59
24.1Information Acquisition. .........................................59
24.2Information Submission by Connecting Transmission Owner. ..........59
24.3Updated Information Submission by Developer. ......................59
24.4Information Supplementation......................................60
ARTICLE 25. INFORMATION ACCESS AND AUDIT RIGHTS....................61
25.1Information Access. .............................................61
25.2Reporting of Non-Force Majeure Events. ...........................61
25.3Audit Rights. ...................................................61
25.4Audit Rights Periods..............................................61
25.5Audit Results. ..................................................62
ARTICLE 26. SUBCONTRACTORS...........................................62
26.1General. ........................................................62
26.2Responsibility of Principal. .......................................62
26.3No Limitation by Insurance. ......................................62
ARTICLE 27. DISPUTES.....................................................63
27.1Submission. ....................................................63
27.2External Arbitration Procedures. ..................................63
27.3Arbitration Decisions. ............................................63
27.4Costs. .........................................................63
27.5Termination. ...................................................64
ARTICLE 28. REPRESENTATIONS, WARRANTIES AND COVENANTS...........64
28.1General. .......................................................64
ARTICLE 29. MISCELLANEOUS.............................................65
29.1Binding Effect. ..................................................65
29.2Conflicts. ......................................................65
29.3Rules of Interpretation. ..........................................65
29.4Compliance. ....................................................65
29.5Joint and Several Obligations. .....................................66
29.6Entire Agreement. ...............................................66
29.7No Third Party Beneficiaries. ......................................66
29.8Waiver. ........................................................66
29.9Headings. ......................................................66
29.10 Multiple Counterparts. ...........................................66
29.11Amendment. ...................................................67
29.12 Modification by the Parties. .......................................67
29.13Reservation of Rights. ............................................67
29.14No Partnership. .................................................67
29.15Other Transmission Rights. .......................................67
Appendices.............................................................69
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
STANDARD LARGE GENERATOR INTERCONNECTION AGREEMENT
THIS STANDARD LARGE GENERATOR INTERCONNECTION AGREEMENT (“Agreement”) is made and entered into this 11th day of February 2011, by and among Howard Wind, LLC, a limited liability corporation organized and existing under the laws of the State of New York (“Developer” or “Howard Wind”) with a Large Generating Facility), the New York Independent System Operator, Inc., a not-for-profit corporation organized and existing under the laws of the State of New York (“NYISO”), and the New York State Electric & Gas Corporation, a corporation organized and existing under the laws of the State of New York (“Connecting Transmission Owner”). Developer, the NYISO, or Connecting Transmission Owner each may be referred to as a “Party” or collectively referred to as the “Parties.”
RECITALS
WHEREAS, NYISO operates the Transmission System and Connecting Transmission Owner owns certain facilities included in the Transmission System; and
WHEREAS, Developer intends to own, lease and/or control and operate the Generating Facility identified as a Large Generating Facility in Appendix C to this Agreement; and,
WHEREAS, Developer, NYISO, and Connecting Transmission Owner have agreed to enter into this Agreement for the purpose of interconnecting the Large Generating Facility with the New York State Transmission System;
NOW, THEREFORE, in consideration of and subject to the mutual covenants contained herein, it is agreed:
Whenever used in this Agreement with initial capitalization, the following terms shall have the meanings specified in this Article 1. Terms used in this Agreement with initial capitalization that are not defined in this Article 1 shall have the meanings specified in Section 30.1.0 or Attachment S of the NYISO OATT.
Affected System shall mean an electric system other than the transmission system owned, controlled or operated by the Connecting Transmission Owner that may be affected by the proposed interconnection.
Affected System Operator shall mean the entity that operates an Affected System.
Affected Transmission Owner shall mean the New York public utility or authority (or its designated agent) other than the Connecting Transmission Owner that (i) owns facilities used for the transmission of Energy in interstate commerce and provides Transmission Service under the Tariff, and (ii) owns, leases or otherwise possesses an interest in a portion of the New York State Transmission System where System Deliverability Upgrades or System Upgrade Facilities are installed pursuant to Attachment X and Attachment S of the Tariff.
Affiliate shall mean, with respect to a person or entity, any individual, corporation, partnership, firm, joint venture, association, joint-stock company, trust or unincorporated organization, directly or indirectly controlling, controlled by, or under common control with, such person or entity. The term “control” shall mean the possession, directly or indirectly, of the power to direct the management or policies of a person or an entity. A voting interest of ten percent or more shall create a rebuttable presumption of control.
Ancillary Services shall mean those services that are necessary to support the transmission of Capacity and Energy from resources to Loads while maintaining reliable operation of the New York State Transmission System in accordance with Good Utility Practice.
Applicable Laws and Regulations shall mean all duly promulgated applicable federal, state and local laws, regulations, rules, ordinances, codes, decrees, judgments, directives, or judicial or administrative orders, permits and other duly authorized actions of any Governmental Authority, including but not limited to Environmental Law.
Applicable Reliability Councils shall mean the NERC, the NPCC and the NYSRC.
Applicable Reliability Standards shall mean the requirements and guidelines of the Applicable Reliability Councils, and the Transmission District to which the Developer’s Large Generating Facility is directly interconnected, as those requirements and guidelines are amended and modified and in effect from time to time; provided that no Party shall waive its right to challenge the applicability or validity of any requirement or guideline as applied to it in the context of this Agreement.
Attachment Facilities shall mean the Connecting Transmission Owner’s Attachment Facilities and the Developer’s Attachment Facilities. Collectively, Attachment Facilities include all facilities and equipment between the Large Generating Facility and the Point of Interconnection, including any modification, additions or upgrades that are necessary to physically and electrically interconnect the Large Generating Facility to the New York State Transmission System. Attachment Facilities are sole use facilities and shall not include Stand Alone System Upgrade Facilities or System Upgrade Facilities or System Deliverability Upgrades.
Base Case shall mean the base case power flow, short circuit, and stability data bases used for the Interconnection Studies by NYISO, Connecting Transmission Owner or Developer; described in Section 30.2.3 of the Large Facility Interconnection Procedures.
Breach shall mean the failure of a Party to perform or observe any material term or condition of this Agreement.
Breaching Party shall mean a Party that is in Breach of this Agreement.
Business Day shall mean Monday through Friday, excluding federal holidays.
Byway shall mean all transmission facilities comprising the New York State Transmission System that are neither Highways nor Other Interfaces. All transmission facilities in Zone J and Zone K are Byways.
Calendar Day shall mean any day including Saturday, Sunday or a federal holiday.
Capacity Region shall mean one of three subsets of the Installed Capacity statewide markets comprised of Rest of State (Zones A through I), Long Island (Zone K), and New York City (Zone J).
Capacity Resource Interconnection Service (“CRIS”) shall mean the service provided by NYISO to interconnect the Developer’s Large Generating Facility to the New York State Transmission System in accordance with the NYISO Deliverability Interconnection Standard, to enable the New York State Transmission System to deliver electric capacity from the Large Generating Facility, pursuant to the terms of the NYISO OATT.
Class Year Deliverability Study shall mean an assessment, conducted by the NYISO staff in cooperation with Market Participants, to determine the System Deliverability Upgrades required for each generation and merchant transmission project included in the Class Year Interconnection Facilities Study to interconnect to the New York State Transmission System in compliance with the NYISO Deliverability Interconnection Standard.
Clustering shall mean the process whereby a group of Interconnection Requests is studied together, instead of serially, for the purpose of conducting the Interconnection System Reliability Impact Study.
Commercial Operation shall mean the status of a Large Generating Facility that has commenced generating electricity for sale, excluding electricity generated during Trial Operation.
Commercial Operation Date of a unit shall mean the date on which the Large Generating Facility commences Commercial Operation as agreed to by the Parties pursuant to Appendix E to this Agreement.
Confidential Information shall mean any information that is defined as confidential by Article 22 of this Agreement.
Connecting Transmission Owner shall mean the New York public utility or authority (or its designated agent) that (i) owns facilities used for the transmission of Energy in interstate commerce and provides Transmission Service under the Tariff, (ii) owns, leases or otherwise possesses an interest in the portion of the New York State Transmission System at the Point of Interconnection, and (iii) is a Party to the Standard Large Interconnection Agreement.
Connecting Transmission Owner’s Attachment Facilities shall mean all facilities and equipment owned, controlled or operated by the Connecting Transmission Owner from the Point of Change of Ownership to the Point of Interconnection as identified in Appendix A to the Standard Large Generator Interconnection Agreement, including any modifications, additions or upgrades to such facilities and equipment. Connecting Transmission Owner’s Attachment Facilities are sole use facilities and shall not include Stand Alone System Upgrade Facilities or System Upgrade Facilities.
Control Area shall mean an electric power system or combination of electric power systems to which a common automatic generation control scheme is applied in order to: (1) match, at all times, the power output of the Generators within the electric power system(s) and capacity and energy purchased from entities outside the electric power system(s), with the Load within the electric power system(s); (2) maintain scheduled interchange with other Control Areas, within the limits of Good Utility Practice; (3) maintain the frequency of the electric power system(s) within reasonable limits in accordance with Good Utility Practice; and (4) provide sufficient generating capacity to maintain Operating Reserves in accordance with Good Utility Practice. A Control Area must be certified by the NPCC.
Default shall mean the failure of a Party in Breach of this Agreement to cure such Breach in accordance with Article 17 of this Agreement.
Deliverability Interconnection Standard shall mean the standard that must be met by any Large Generating Facility proposing to interconnect to the New York State Transmission System and become a qualified Installed Capacity Supplier. To meet the NYISO Deliverability Interconnection Standard, the Developer of the proposed Large Generating Facility must, in accordance with the rules in Attachment S to the NYISO OATT, fund or commit to fund the System Deliverability Upgrades identified for its project in the Class Year Deliverability Study.
Developer shall mean an Eligible Customer developing a Large Generating Facility, proposing to connect to the New York State Transmission System, in compliance with the NYISO Minimum Interconnection Standard.
Developer’s Attachment Facilities shall mean all facilities and equipment, as identified in Appendix A of this Agreement, that are located between the Large Generating Facility and the Point of Change of Ownership, including any modification, addition, or upgrades to such facilities and equipment necessary to physically and electrically interconnect the Large Generating Facility to the New York State Transmission System. Developer’s Attachment Facilities are sole use facilities.
Dispute Resolution shall mean the procedure described in Article 27 of this Agreement for resolution of a dispute between the Parties.
Effective Date shall mean the date on which this Agreement becomes effective upon execution by the Parties, subject to acceptance by the Commission, or if filed unexecuted, upon the date specified by the Commission.
Emergency State shall mean the condition or state that the New York State Power System is in when an abnormal condition occurs that requires automatic or immediate manual action to prevent or limit loss of the New York State Transmission System or Generators that could adversely affect the reliability of the New York State Power System.
Energy Resource Interconnection Service (“ERIS”) shall mean the service provided by NYISO to interconnect the Developer’s Large Generating Facility to the New York State Transmission System in accordance with the NYISO Minimum Interconnection Standard to enable the New York State Transmission System to receive Energy and Ancillary Services from the Large Generating Facility, pursuant to the terms of the NYISO OATT.
Engineering & Procurement (E&P) Agreement shall mean an agreement that authorizes Connecting Transmission Owner to begin engineering and procurement of long lead-time items necessary for the establishment of the interconnection in order to advance the implementation of the Interconnection Request.
Environmental Law shall mean Applicable Laws or Regulations relating to pollution or protection of the environment or natural resources.
Federal Power Act shall mean the Federal Power Act, as amended, 16 U.S.C. §§ 791a et seq. (“FPA”).
FERC shall mean the Federal Energy Regulatory Commission (“Commission”) or its successor.
Force Majeure shall mean any act of God, labor disturbance, act of the public enemy, war, insurrection, riot, fire, storm or flood, explosion, breakage or accident to machinery or equipment, any order, regulation or restriction imposed by governmental, military or lawfully established civilian authorities, or any other cause beyond a Party’s control. A Force Majeure event does not include acts of negligence or intentional wrongdoing by the Party claiming Force Majeure.
Generating Facility shall mean Developer’s device for the production of electricity identified in the Interconnection Request, but shall not include the Developer’s Attachment Facilities.
Generating Facility Capacity shall mean the net seasonal capacity of the Generating Facility and the aggregate net seasonal capacity of the Generating Facility where it includes multiple energy production devices.
Good Utility Practice shall mean any of the practices, methods and acts engaged in or approved by a significant portion of the electric industry during the relevant time period, or any of the practices, methods and acts which, in the exercise of reasonable judgment in light of the facts known at the time the decision was made, could have been expected to accomplish the desired result at a reasonable cost consistent with good business practices, reliability, safety and expedition. Good Utility Practice is not intended to be limited to the optimum practice, method, or act to the exclusion of all others, but rather to delineate acceptable practices, methods, or acts generally accepted in the region.
Governmental Authority shall mean any federal, state, local or other governmental regulatory or administrative agency, court, commission, department, board, or other governmental subdivision, legislature, rulemaking board, tribunal, or other governmental authority having jurisdiction over any of the Parties, their respective facilities, or the respective services they provide, and exercising or entitled to exercise any administrative, executive, police, or taxing authority or power; provided, however, that such term does not include Developer, NYISO, Affected Transmission Owner, Connecting Transmission Owner, or any Affiliate thereof.
Hazardous Substances shall mean any chemicals, materials or substances defined as or included in the definition of “hazardous substances,” “hazardous wastes,” “hazardous materials,” “hazardous constituents,” “restricted hazardous materials,” “extremely hazardous substances,” “toxic substances,” “radioactive substances,” “contaminants,” “pollutants,” “toxic pollutants” or words of similar meaning and regulatory effect under any applicable Environmental Law, or any other chemical, material or substance, exposure to which is prohibited, limited or regulated by any applicable Environmental Law.
Highway shall mean 115 kV and higher transmission facilities that comprise the following NYCA interfaces: Dysinger East, West Central, Volney East, Moses South, Central East/Total East, UPNY, SENY and UPNY ConEd, and their immediately connected, in series, Bulk Power System facilities in New York State. Each interface shall be evaluated to determine additional “in series” facilities, defined as any transmission facility higher than 115 kV that (a) is located in an upstream or downstream zone adjacent to the interface and (b) has a power transfer distribution factor (DFAX) equal to or greater than five percent when the aggregate of generation in zones or systems adjacent to the upstream zone or zones which define the interface is shifted to the aggregate of generation in zones or systems adjacent to the downstream zone or zones which define the interface. In determining “in series” facilities for Dysinger East and West Central interfaces, the 115 kV and 230 kV tie lines between NYCA and PJM located in LBMP Zones A and B shall not participate in the transfer. Highway transmission facilities are listed in ISO Procedures.
Initial Synchronization Date shall mean the date upon which the Large Generating Facility is initially synchronized and upon which Trial Operation begins.
In-Service Date shall mean the date upon which the Developer reasonably expects it will be ready to begin use of the Connecting Transmission Owner’s Attachment Facilities to obtain back feed power.
Interconnection Facilities Study shall mean a study conducted by NYISO or a third party consultant for the Developer to determine a list of facilities (including Connecting Transmission Owner’s Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades as identified in the Interconnection System Reliability Impact Study), the cost of those facilities, and the time required to interconnect the Large Generating Facility with the New York State Transmission System. The scope of the study is defined in Section 30.8 of the Standard Large Facility Interconnection Procedures.
Interconnection Facilities Study Agreement shall mean the form of agreement contained in Appendix 4 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection Facilities Study.
Interconnection Feasibility Study shall mean a preliminary evaluation of the system impact and cost of interconnecting the Large Generating Facility to the New York State Transmission System, the scope of which is described in Section 30.6 of the Standard Large Facility Interconnection Procedures.
Interconnection Feasibility Study Agreement shall mean the form of agreement contained in Appendix 2 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection Feasibility Study.
Interconnection Request shall mean a Developer’s request, in the form of Appendix 1 to the Standard Large Facility Interconnection Procedures, in accordance with the Tariff, to interconnect a new Large Generating Facility to the New York State Transmission System, or to increase the capacity of, or make a material modification to the operating characteristics of, an existing Large Generating Facility that is interconnected with the New York State Transmission System.
Interconnection Study shall mean any of the following studies: the Interconnection Feasibility Study, the Interconnection System Reliability Impact Study, and the Interconnection Facilities Study described in the Standard Large Facility Interconnection Procedures.
Interconnection System Reliability Impact Study (“SRIS”) shall mean an engineering study, conducted in accordance with Section 30.7 of the Large Facility Interconnection Procedures, that evaluates the impact of the proposed Large Generating Facility on the safety and reliability of the New York State Transmission System and, if applicable, an Affected System, to determine what Attachment Facilities and System Upgrade Facilities are needed for the proposed Large Generation Facility of the Developer to connect reliably to the New York State Transmission System in a manner that meets the NYISO Minimum Interconnection Standard.
Interconnection System Reliability Impact Study Agreement shall mean the form of agreement contained in Appendix 3 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection System Reliability Impact Study.
IRS shall mean the Internal Revenue Service.
Large Generating Facility shall mean a Generating Facility having a Generating Facility Capacity of more than 20 MW.
Loss shall mean any and all losses relating to injury to or death of any person or damage to property, demand, suits, recoveries, costs and expenses, court costs, attorney fees, and all other obligations by or to third parties, arising out of or resulting from the Indemnified Party’s performance or non-performance of its obligations under this Agreement on behalf of the Indemnifying Party, except in cases of gross negligence or intentional wrongdoing by the Indemnified Party.
Material Modification shall mean those modifications that have a material impact on the cost or timing of any Interconnection Request with a later queue priority date.
Metering Equipment shall mean all metering equipment installed or to be installed at the Large Generating Facility pursuant to this Agreement at the metering points, including but not limited to instrument transformers, MWh-meters, data acquisition equipment, transducers, remote terminal unit, communications equipment, phone lines, and fiber optics.
Minimum Interconnection Standard shall mean the reliability standard that must be met by any Large Generating Facility proposing to connect to the New York State Transmission System. The Standard is designed to ensure reliable access by the proposed project to the New York State Transmission System. The Standard does not impose any deliverability test or deliverability requirement on the proposed interconnection.
NERC shall mean the North American Electric Reliability Council or its successor organization.
New York State Transmission System shall mean the entire New York State electric transmission system, which includes (i) the Transmission Facilities under ISO Operational Control; (ii) the Transmission Facilities Requiring ISO Notification; and (iii) all remaining transmission facilities within the New York Control Area.
Notice of Dispute shall mean a written notice of a dispute or claim that arises out of or in connection with this Agreement or its performance.
NPCC shall mean the Northeast Power Coordinating Council or its successor organization.
NYSRC shall mean the New York State Reliability Council or its successor organization.
Optional Interconnection Study shall mean a sensitivity analysis based on assumptions specified by the Developer in the Optional Interconnection Study Agreement.
Optional Interconnection Study Agreement shall mean the form of agreement contained in Appendix 5 of the Standard Large Facility Interconnection Procedures for conducting the Optional Interconnection Study.
Other Interfaces shall mean interfaces into New York capacity regions, Zone J and Zone K, and external ties into the New York Control Area.
Party or Parties shall mean NYISO, Connecting Transmission Owner, or Developer or any combination of the above.
Point of Change of Ownership shall mean the point, as set forth in Appendix A to this Agreement, where the Developer’s Attachment Facilities connect to the Connecting Transmission Owner’s Attachment Facilities.
Point of Interconnection shall mean the point, as set forth in Appendix A to this Agreement, where the Attachment Facilities connect to the New York State Transmission System.
Queue Position shall mean the order of a valid Interconnection Request, relative to all other pending valid Interconnection Requests, that is established based upon the date and time of receipt of the valid Interconnection Request by NYISO.
Reasonable Efforts shall mean, with respect to an action required to be attempted or taken by a Party under this Agreement, efforts that are timely and consistent with Good Utility Practice and are otherwise substantially equivalent to those a Party would use to protect its own interests.
Scoping Meeting shall mean the meeting between representatives of the Developer, NYISO and Connecting Transmission Owner conducted for the purpose of discussing alternative interconnection options, to exchange information including any transmission data and earlier study evaluations that would be reasonably expected to impact such interconnection options, to analyze such information, and to determine the potential feasible Points of Interconnection.
Services Tariff shall mean the NYISO Market Administration and Control Area Tariff, as filed with the Commission, and as amended or supplemented from time to time, or any successor tariff thereto.
Site Control shall mean documentation reasonably demonstrating: (1) ownership of, a leasehold interest in, or a right to develop a site for the purpose of constructing the Large Generating Facility; (2) an option to purchase or acquire a leasehold site for such purpose; or (3) an exclusivity or other business relationship between Developer and the entity having the right to sell, lease or grant Developer the right to possess or occupy a site for such purpose.
Stand Alone System Upgrade Facilities shall mean System Upgrade Facilities that a Developer may construct without affecting day-to-day operations of the New York State Transmission System during their construction. NYISO, the Connecting Transmission Owner and the Developer must agree as to what constitutes Stand Alone System Upgrade Facilities and identify them in Appendix A to this Agreement.
Standard Large Facility Interconnection Procedures (“LFIP”) shall mean the interconnection procedures applicable to an Interconnection Request pertaining to a Large Generating Facility that are included in Attachment X of the NYISO OATT.
Standard Large Generator Interconnection Agreement (“LGIA”) shall mean this Agreement, the form of interconnection agreement applicable to an Interconnection Request pertaining to a Large Generating Facility, that is included in Attachment X of the NYISO OATT.
System Deliverability Upgrades shall mean the least costly configuration of commercially available components of electrical equipment that can be used, consistent with Good Utility Practice and Applicable Reliability Requirements, to make the modifications or additions to Byways and Highways and Other Interfaces on the existing New York State Transmission System that are required for the proposed project to connect reliably to the system in a manner that meets the NYISO Deliverability Interconnection Standard at the requested level of Capacity Resource Interconnection Service.
System Protection Facilities shall mean the equipment, including necessary protection signal communications equipment, required to (1) protect the New York State Transmission System from faults or other electrical disturbances occurring at the Large Generating Facility and (2) protect the Large Generating Facility from faults or other electrical system disturbances occurring on the New York State Transmission System or on other delivery systems or other generating systems to which the New York State Transmission System is directly connected.
System Upgrade Facilities shall mean the least costly configuration of commercially available components of electrical equipment that can be used, consistent with Good Utility Practice and Applicable Reliability Requirements, to make the modifications to the existing transmission system that are required to maintain system reliability due to: (i) changes in the system, including such changes as load growth and changes in load pattern, to be addressed in the form of generic generation or transmission projects; and (ii) proposed interconnections. In the case of proposed interconnection projects, System Upgrade Facilities are the modifications or additions to the existing New York State Transmission System that are required for the proposed project to connect reliably to the system in a manner that meets the NYISO Minimum Interconnection Standard.
Tariff shall mean the NYISO Open Access Transmission Tariff (“OATT”), as filed with the Commission, and as amended or supplemented from time to time, or any successor tariff.
Trial Operation shall mean the period during which Developer is engaged in on-site test operations and commissioning of the Large Generating Facility prior to Commercial Operation.
If Developer terminates this Agreement, it shall be responsible for all costs incurred in association with Developer’s interconnection, including any cancellation costs relating to orders or contracts for Attachment Facilities and equipment, and other expenses including any System Upgrade Facilities and System Deliverability Upgrades for which the Connecting Transmission Owner has incurred expenses and has not been reimbursed by the Developer.
If Connecting Transmission Owner subsequently fails to complete Connecting Transmission Owner’s Attachment Facilities by the In-Service Date, to the extent necessary to provide back feed power; or fails to complete System Upgrade Facilities or System Deliverability Upgrades by the Initial Synchronization Date to the extent necessary to allow for Trial Operation at full power output, unless other arrangements are made by the Developer and Connecting Transmission Owner for such Trial Operation; or fails to complete the System Upgrade Facilities and System Deliverability Upgrades by the Commercial Operation Date, as such dates are reflected in Appendix B hereto; Connecting Transmission Owner shall pay Developer liquidated damages in accordance with Article 5.3, Liquidated Damages, provided, however, the dates designated by Developer shall be extended day for day for each day that NYISO refuses to grant clearances to install equipment.
However, in no event shall the total liquidated damages exceed 20 percent of the actual cost of the Connecting Transmission Owner Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades for which the Connecting Transmission Owner has assumed responsibility to design, procure, and construct. The foregoing payments will be made by the Connecting Transmission Owner to the Developer as just compensation for the damages caused to the Developer, which actual damages are uncertain and impossible to determine at this time, and as reasonable liquidated damages, but not as a penalty or a method to secure performance of this Agreement. Liquidated damages, when the Developer and Connecting Transmission Owner agree to them, are the exclusive remedy for the Connecting Transmission Owner’s failure to meet its schedule.
Further, Connecting Transmission Owner shall not pay liquidated damages to Developer if: (1) Developer is not ready to commence use of the Connecting Transmission Owner’s Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades to take the delivery of power for the Developer’s Large Generating Facility’s Trial Operation or to export power from the Developer’s Large Generating Facility on the specified dates, unless the Developer would have been able to commence use of the Connecting Transmission Owner’s Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades to take the delivery of power for Developer’s Large Generating Facility’s Trial Operation or to export power from the Developer’s Large Generating Facility, but for Connecting Transmission Owner’s delay; (2) the Connecting Transmission Owner’s failure to meet the specified dates is the result of the action or inaction of the Developer or any other Developer who has entered into a Standard Large Generator Interconnection Agreement with the Connecting Transmission Owner and NYISO, or action or inaction by any other Party, or any other cause beyond Connecting Transmission Owner’s reasonable control or reasonable ability to cure; (3) the Developer has assumed responsibility for the design, procurement and construction of the Connecting Transmission Owner’s Attachment Facilities and Stand Alone System Upgrade Facilities; or (4) the Connecting Transmission Owner and Developer have otherwise agreed.
In no event shall NYISO have any liability whatever to Developer for liquidated damages associated with the engineering, procurement or construction of Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades.
Connecting Transmission Owner shall invoice Developer for such costs pursuant to Article 12 and shall use due diligence to minimize its costs. In the event Developer suspends work by Connecting Transmission Owner required under this Agreement pursuant to this Article 5.16, and has not requested Connecting Transmission Owner to recommence the work required under this Agreement on or before the expiration of three (3) years following commencement of such suspension, this Agreement shall be deemed terminated. The three-year period shall begin on the date the suspension is requested, or the date of the written notice to Connecting Transmission Owner and NYISO, if no effective date is specified.
At Connecting Transmission Owner’s request, Developer shall provide Connecting Transmission Owner with a report from an independent engineer confirming its representation in clause (iii), above. Connecting Transmission Owner represents and covenants that the cost of the Connecting Transmission Owner’s Attachment Facilities paid for by Developer will have no net effect on the base upon which rates are determined.
Connecting Transmission Owner shall not include a gross-up for the cost consequences of any current tax liability in the amounts it charges Developer under this Agreement unless (i) Connecting Transmission Owner has determined, in good faith, that the payments or property transfers made by Developer to Connecting Transmission Owner should be reported as income subject to taxation or (ii) any Governmental Authority directs Connecting Transmission Owner to report payments or property as income subject to taxation; provided, however, that Connecting Transmission Owner may require Developer to provide security, in a form reasonably acceptable to Connecting Transmission Owner (such as a parental guarantee or a letter of credit), in an amount equal to the cost consequences of any current tax liability under this Article 5.17. Developer shall reimburse Connecting Transmission Owner for such costs on a fully grossed-up basis, in accordance with Article 5.17.4, within thirty (30) Calendar Days of receiving written notification from Connecting Transmission Owner of the amount due, including detail about how the amount was calculated.
This indemnification obligation shall terminate at the earlier of (1) the expiration of the ten-year testing period and the applicable statute of limitation, as it may be extended by the Connecting Transmission Owner upon request of the IRS, to keep these years open for audit or adjustment, or (2) the occurrence of a subsequent taxable event and the payment of any related indemnification obligations as contemplated by this Article 5.17.
For this purpose, (i) Current Taxes shall be computed based on Connecting Transmission Owner’s composite federal and state tax rates at the time the payments or property transfers are received and Connecting Transmission Owner will be treated as being subject to tax at the highest marginal rates in effect at that time (the “Current Tax Rate”), and (ii) the Present Value Depreciation Amount shall be computed by discounting Connecting Transmission Owner’s anticipated tax depreciation deductions as a result of such payments or property transfers by Connecting Transmission Owner’s current weighted average cost of capital. Thus, the formula for calculating Developer’s liability to Connecting Transmission Owner pursuant to this Article 5.17.4 can be expressed as follows: (Current Tax Rate x (Gross Income Amount - Present Value of Tax Depreciation))/(1 - Current Tax Rate).
Developer’s estimated tax liability in the event taxes are imposed shall be stated in Appendix A, Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades.
Connecting Transmission Owner shall keep Developer fully informed of the status of such request for a private letter ruling and shall execute either a privacy act waiver or a limited power of attorney, in a form acceptable to the IRS, that authorizes Developer to participate in all discussions with the IRS regarding such request for a private letter ruling. Connecting Transmission Owner shall allow Developer to attend all meetings with IRS officials about the request and shall permit Developer to prepare the initial drafts of any follow-up letters in connection with the request.
Developer shall pay to Connecting Transmission Owner on a periodic basis, as invoiced by Connecting Transmission Owner, Connecting Transmission Owner’s documented reasonable costs of prosecuting such appeal, protest, abatement or other contest. At any time during the contest, Connecting Transmission Owner may agree to a settlement either with Developer’s consent or after obtaining written advice from nationally-recognized tax counsel, selected by Connecting Transmission Owner, but reasonably acceptable to Developer, that the proposed settlement represents a reasonable settlement given the hazards of litigation. Developer’s obligation shall be based on the amount of the settlement agreed to by Developer, or if a higher amount, so much of the settlement that is supported by the written advice from nationally-recognized tax counsel selected under the terms of the preceding sentence. The settlement amount shall be calculated on a fully grossed-up basis to cover any related cost consequences of the current tax liability. Any settlement without Developer’s consent or such written advice will relieve Developer from any obligation to indemnify Connecting Transmission Owner for the tax at issue in the contest.
(i) Any payment made by Developer under this Article 5.17 for taxes that is attributable to the amount determined to be non-taxable, together with interest thereon,
(ii) Interest on any amounts paid by Developer to Connecting Transmission Owner for such taxes which Connecting Transmission Owner did not submit to the taxing authority, calculated in accordance with the methodology set forth in FERC’s regulations at 18 C.F.R. §35.19a(a)(2)(iii) from the date payment was made by Developer to the date Connecting Transmission Owner refunds such payment to Developer, and
(iii) With respect to any such taxes paid by Connecting Transmission Owner, any refund or credit Connecting Transmission Owner receives or to which it may be entitled from any Governmental Authority, interest (or that portion thereof attributable to the payment described in clause (i), above) owed to the Connecting Transmission Owner for such overpayment of taxes (including any reduction in interest otherwise payable by Connecting Transmission Owner to any Governmental Authority resulting from an offset or credit); provided, however, that Connecting Transmission Owner will remit such amount promptly to Developer only after and to the extent that Connecting Transmission Owner has received a tax refund, credit or offset from any Governmental Authority for any applicable overpayment of income tax related to the Connecting Transmission Owner’s Attachment Facilities.
The intent of this provision is to leave both the Developer and Connecting Transmission Owner, to the extent practicable, in the event that no taxes are due with respect to any payment for Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades hereunder, in the same position they would have been in had no such tax payments been made.
In the case of Large Generating Facility modifications that do not require Developer to submit an Interconnection Request, the NYISO shall provide, within sixty (60) Calendar Days (or such other time as the Parties may agree), an estimate of any additional modifications to the New York State Transmission System, Connecting Transmission Owner’s Attachment Facilities or System Upgrade Facilities or System Deliverability Upgrades necessitated by such Developer modification and a good faith estimate of the costs thereof. The Developer shall be responsible for the cost of any such additional modifications, including the cost of studying the impact of the Developer modification.
Each Party will promptly advise the appropriate other Party if it detects or otherwise learns of any metering, telemetry or communications equipment errors or malfunctions that require the attention and/or correction by that other Party. The Party owning such equipment shall correct such error or malfunction as soon as reasonably feasible.
The Developer shall design and maintain the plant auxiliary systems to operate safely throughout the entire real and reactive power design range.
The Connecting Transmission Owner shall not unreasonably restrict or condition the reactive power production or absorption of the Large Generating Facility in accordance with Good Utility Practice.
In addition:
NYISO and Connecting Transmission Owner shall use Reasonable Efforts to minimize the effect of such actions or inactions on the Large Generating Facility or the Developer Attachment Facilities. NYISO or Connecting Transmission Owner may, on the basis of technical considerations, require the Large Generating Facility to mitigate an Emergency State by taking actions necessary and limited in scope to remedy the Emergency State, including, but not limited to, directing Developer to shut-down, start-up, increase or decrease the real or reactive power output of the Large Generating Facility; implementing a reduction or disconnection pursuant to Article 13.4.2; directing the Developer to assist with blackstart (if available) or restoration efforts; or altering the outage schedules of the Large Generating Facility and the Developer Attachment Facilities. Developer shall comply with all of the NYISO and Connecting Transmission Owner’s operating instructions concerning Large Generating Facility real power and reactive power output within the manufacturer’s design limitations of the Large Generating Facility’s equipment that is in service and physically available for operation at the time, in compliance with Applicable Laws and Regulations.
A Party may change the notice information in this Agreement by giving five (5) Business Days written notice prior to the effective date of the change.
Except as stated below, the Indemnifying Party shall have the right to assume the defense thereof with counsel designated by such Indemnifying Party and reasonably satisfactory to the Indemnified Party. If the defendants in any such action include one or more Indemnified Parties and the Indemnifying Party and if the Indemnified Party reasonably concludes that there may be legal defenses available to it and/or other Indemnified Parties which are different from or additional to those available to the Indemnifying Party, the Indemnified Party shall have the right to select separate counsel to assert such legal defenses and to otherwise participate in the defense of such action on its own behalf. In such instances, the Indemnifying Party shall only be required to pay the fees and expenses of one additional attorney to represent an Indemnified Party or Indemnified Parties having such differing or additional legal defenses.
The Indemnified Party shall be entitled, at its expense, to participate in any such action, suit or proceeding, the defense of which has been assumed by the Indemnifying Party. Notwithstanding the foregoing, the Indemnifying Party (i) shall not be entitled to assume and control the defense of any such action, suit or proceedings if and to the extent that, in the opinion of the Indemnified Party and its counsel, such action, suit or proceeding involves the potential imposition of criminal liability on the Indemnified Party, or there exists a conflict or adversity of interest between the Indemnified Party and the Indemnifying Party, in such event the Indemnifying Party shall pay the reasonable expenses of the Indemnified Party, and (ii) shall not settle or consent to the entry of any judgment in any action, suit or proceeding without the consent of the Indemnified Party, which shall not be unreasonably withheld, conditioned or delayed.
If requested by a Party receiving information, the Party supplying the information shall provide in writing, the basis for asserting that the information referred to in this Article warrants confidential treatment, and the requesting Party may disclose such writing to the appropriate Governmental Authority. Each Party shall be responsible for the costs associated with affording confidential treatment to its information.
If the Developer’s data is different from what was originally provided to Connecting Transmission Owner and NYISO pursuant to an Interconnection Study Agreement among Connecting Transmission Owner, NYISO and Developer and this difference may be reasonably expected to affect the other Parties’ facilities or the New York State Transmission System, but does not require the submission of a new Interconnection Request, then NYISO will conduct appropriate studies to determine the impact on the New York State Transmission System based on the actual data submitted pursuant to this Article 24.3. Such studies will provide an estimate of any additional modifications to the New York State Transmission System, Connecting Transmission Owner’s Attachment Facilities, or System Upgrade Facilities or System Deliverability Upgrades based on the actual data and a good faith estimate of the costs thereof. The Developer shall not begin Trial Operation until such studies are completed. The Developer shall be responsible for the cost of any modifications required by the actual data, including the cost of any required studies.
Unless otherwise agreed, the test conditions shall include: (1) Large Generating Facility at synchronous speed; (2) automatic voltage regulator on and in voltage control mode; and (3) a five percent change in Large Generating Facility terminal voltage initiated by a change in the voltage regulators reference voltage. Developer shall provide validated test recordings showing the responses of Large Generating Facility terminal and field voltages. In the event that direct recordings of these voltages is impractical, recordings of other voltages or currents that mirror the response of the Large Generating Facility’s terminal or field voltage are acceptable if information necessary to translate these alternate quantities to actual Large Generating Facility terminal or field voltages is provided. Large Generating Facility testing shall be conducted and results provided to the Connecting Transmission Owner and NYISO for each individual generating unit in a station.
Subsequent to the Commercial Operation Date, the Developer shall provide Connecting Transmission Owner and NYISO any information changes due to equipment replacement, repair, or adjustment. Connecting Transmission Owner shall provide the Developer and NYISO any information changes due to equipment replacement, repair or adjustment in the directly connected substation or any adjacent Connecting Transmission Owner substation that may affect the Developer Attachment Facilities equipment ratings, protection or operating requirements. The Developer and Connecting Transmission Owner shall provide such information no later than thirty (30) Calendar Days after the date of the equipment replacement, repair or adjustment.

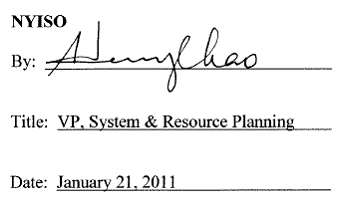

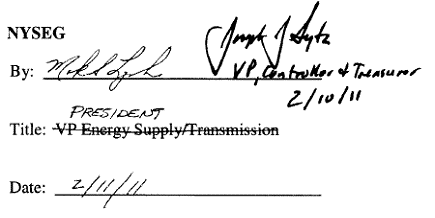

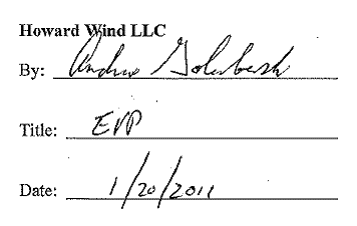

IN WITNESS WHEREOF, the Parties have executed this LGIA in duplicate originals, each of which shall constitute and be an original effective Agreement between the Parties.
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
Appendix A
Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades
Appendix C
Interconnection Details
Appendix D
Security Arrangements Details
Appendix E
Commercial Operation Date
Appendix F
Addresses for Delivery of Notices and Billings
Appendix G
Interconnection Requirements For a Wind Generating Plant
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
Attachment Facilities and System Upgrade Facilities and System Deliverability Upgrades
I.ATTACHMENT FACILITIES
A.Developer’s Attachment Facilities (“DAF”)
Developer’s Attachment Facilities include all of the facilities on the Developer side of Point of Change of Ownership. The Developer’s Attachment Facilities will contain a 115 kV-34.5 kV transformer, 115 kV circuit breaker, two 115 kV disconnect switches, two 34.5 kV circuit breakers, two 34.5 kV collector circuits, and the 115 kV and 34.5 kV buswork and structures necessary to interconnect the new collector substation, known as the Howard Wind Farm substation, to the substation at the Point of Interconnection. This includes the following major electrical and physical equipment:
B.Connecting Transmission Owner’s Attachment Facilities
The Connecting Transmission Owner’s Attachment Facilities include all facilities between the Point of Change of Ownership and the Point of Interconnection. The Connecting Transmission Owner’s Attachment Facilities will contain the revenue metering units, one (1) 115 kV disconnect switch and the necessary 115 kV bus work and structures to connect the new Point of Interconnection substation, known as the Spencer Hill Substation, with the Developer’s Attachment Facilities. This includes the following major electrical and physical equipment:
The Connecting Transmission Owner’s Attachment Facilities shall be designed, procured, and constructed by the Developer. The Connecting Transmission Owner shall perform design reviews, construction supervision, and testing of the Connecting Transmission Owner’s Attachment Facilities.
A.Stand Alone System Upgrade Facilities at the Point of Interconnection
A new 3-breaker-ring, 115 kV substation at the Point of Interconnection, known as the Spencer Hill Substation, will be constructed adjacent to the collecting station and will be connected to the NYSEG 953 line.
The Stand Alone System Upgrade Facilities shall be designed, procured, and constructed by the Developer. The Connecting Transmission Owner shall perform design reviews, construction supervision, and testing of the Stand Alone System Upgrade Facilities.
B.Other System Upgrade Facilities
The Connecting Transmission Owner will engineer the Point of Interconnection Line 953 Tap Work which includes reconfiguring the 115 kV transmission line for connecting the new Spencer Hill Substation.
The Connecting Transmission Owner will replace the existing 953 line relaying and install second set of current transformers on Breaker 95362. These system upgrades include the installation of two groups of line relays with addition of a new panel and the installation of current transformers.
a.Developer to perform the following work at the Bennett Substation:
b.Connecting Transmission Owner will perform the following work at the Bennett Substation:
3.Protection SUF at Bath Substation
a.Developer will perform the following work at the Bath Substation:
b.Connecting Transmission Owner to perform the following work at the Bath Substation:
C. Cost Estimates
Installation Cost | |
$258,930.72 | |
System Upgrade Facilities at Point of Interconnection | $5,299,894.00 |
115 kV Transmission Work at the Point of Interconnection | $200,000.00 |
Protection SUF at Bennett Substation | $517,482.00 |
Protection SUF at Bath Substation | $295,395.00 |
Total | $6,312,771.72 |
III. SYSTEM DELIVERABILITY UPGRADES
Pursuant to Section 10.5 of this Agreement, Developer shall pay the reasonable expenses (including overheads) for the operation, maintenance, repair and replacement of Connecting Transmission Owner’s Attachment Facilities.
The Developer shall pay such O&M Expenses under the procedure described below:
A.Annual Actual O&M Payment
The Developer shall pay for all reasonable and verifiable O&M Expenses incurred by Connecting Transmission Owner, which expenses shall be billed by Connecting Transmission Owner annually as accumulated during the year for which they were incurred.
B.O&M Expenses
O&M Expenses shall include (but are not limited to):
C.O&M Payment
Developer shall pay all O&M Expenses associated with the operation, maintenance, repair and replacement of the Connecting Transmission Owner’s Attachment Facilities.
Any incremental property tax payment resulting from the addition of the Connecting Transmission Owner's Attachment Facilities will be the responsibility of the Developer and paid annually. A property tax assessment before and after construction of the Connecting Transmission Owner’s Attachment Facilities will be determined and submitted to the Developer for review.
Developer shall pay the actual incremental property tax liability incurred by the Connecting Transmission Owner resulting from the property assessment of Connecting Transmission Owner’s Attachment Facilities dedicated to the project.
All payments due to be made by the Developer shall be made within thirty (30) days after receiving an invoice from the Connecting Transmission Owner, which invoice shall be issued after the end of each calendar year for the most recent calendar year.

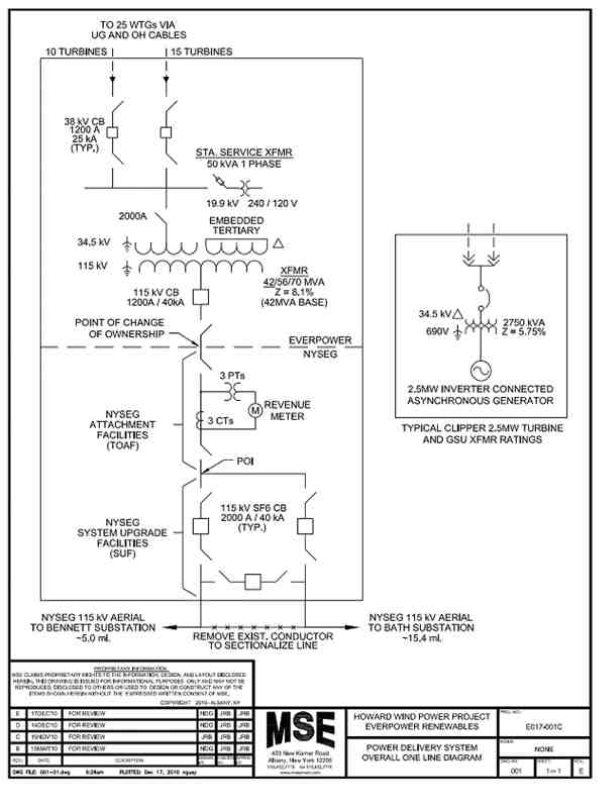

Figure A-1
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
I.Selected Option pursuant to Article 5.1
The selected option under Article 5.1 of this Interconnection Agreement is the “Option to Build” except for Connecting Transmission Owner’s engineering, procurement and construction obligations which shall be performed in accordance with the “Standard Option.” The Parties have agreed to the division of responsibility and scope as described in Sections I.B and II.A of Appendix A.
II. MilestoneS
DATE | RESPONSIBLE PARTY | |
POI Substation |
|
|
Conceptual Package and Equipment Specifications to Connecting Transmission Owner | March 8, 2011 | Developer submitted |
Connecting Transmission Owner Approval of Major Equipment Specifications/Conceptual Package | April 2, 2011 | Connecting Transmission Owner |
Begin Substation Construction | April 1, 2011 | Developer |
Substation In-Ground Package to Connecting Transmission Owner | April 9, 2011 | Developer |
Substation Site/Grading Work | April 26, 2011 | Developer |
Substation Above-Ground Package to Connecting Transmission Owner | April 16, 2011 | Connecting Transmission Owner |
SP&C Package 1 to Connecting Transmission Owner | April 16, 2011 | Developer |
Issue SP&C Package 1 for Construction | May 6, 2011 | Connecting Transmission Owner |
SP&C Package 2 to Connecting Transmission Owner | May 10, 2011 | Developer |
Issue SP&C Package 2 for Construction | May 30, 2011 | Connecting Transmission Owner |
SP&C Package 3 to Connecting Transmission Owner | June 1, 2011 | Developer |
Major Substation Equipment Installation | May 24,2011 | Developer |
Control House Installation | June 15, 2011 | Developer |
Substation Construction Complete | August 30, 2011 | Developer |
Complete Facility Testing/Commissioning | September 28, 2011 | Connecting Transmission Owner |
115kV POI Line Tap |
|
|
Engineer POI Line 953 Tap Work | May 03, 2011 | Connecting Transmission Owner |
115kV tie in poles/equipment/materials | May 31, 2011 | Connecting Transmission Owner |
Deliver and dress new 115kV structures | August 09, 2011 | Connecting Transmission Owner |
Set 2 new 115kV pole structures | September 20, 2011 | Connecting Transmission Owner |
Cut and dead end OH cables onto new poles | October 20, 2011 | Connecting Transmission Owner |
Install OH circuits from new poles to substation | October 20, 2011 | Connecting Transmission Owner |
Bath Substation |
|
|
Developer Obtain Connecting Transmission Owner design data package | April 19, 2011 | Connecting Transmission Owner |
Purchase materials/equipment | June 11, 2011 | Developer/ Connecting Transmission Owner |
In-Ground Package Complete | May 14, 2011 | Developer |
Above Ground Package Complete | June 18, 2011 | Developer |
SP&C Package #1 Complete | May 21, 2011 | Developer |
SP&C Package #2 Complete | June 25, 2011 | Developer |
SP&C Package #3 Complete | July 7, 2011 | Developer |
Construction Complete | September 17, 2011 | Developer/ Connecting Transmission Owner |
Testing and Commissioning | October 1, 2011 | Connecting Transmission Owner |
Bennett Substation |
|
|
Developer Obtain Connecting Transmission Owner design data package | April 19, 2011 | Connecting Transmission Owner |
Purchase materials/equipment | June 11, 2011 | Developer/ Connecting Transmission Owner |
In-Ground Package Complete | May 14, 2011 | Developer |
Above Ground Package Complete | June 18, 2011 | Developer |
SP&C Package #1 Complete | May 21, 2011 | Developer |
SP&C Package #2 Complete | June 25, 2011 | Developer |
SP&C Package #3 Complete | July 7, 2011 | Developer |
Construction Complete | September 17, 2011 | Developer/ Connecting Transmission Owner |
Testing and Commissioning | October 1, 2011 | Connecting Transmission Owner |
|
|
|
In-Service Date | October 18, 2011 | Developer/ Connecting Transmission Owner |
Initial Synchronization Date | October 25, 2011 | Developer/ Connecting Transmission Owner |
Commercial Operation Date | October 25, 2011 | Developer/ Connecting Transmission Owner |
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
Appendix C
Interconnection Details
Description of Large Generating Facility including Point of Interconnection
The Large Generating Facility is a 62.5 MW wind power plant that will consist of 25, 2.5 MW Clipper N90 double-fed asynchronous generators. Each of the 25 units have the capability to operate (at each generator terminal) in the range of 0.95 leading and 0.95 lagging. This gives the entire generating facility an operating range from +20.5 MVAR to –20.5 MVAR (sum of unit capabilities). The Large Generating Facility will connect to NYSEG’s Bath – Bennett 115 kV line #953 approximately 5 miles from Bennett Substation. The Point of Interconnection is identified on Figure A-1 in Appendix A. The Point of Change of Ownership shall be the three terminals of the three (3) Current Transformer/Voltage Transformer (“CT/VT”) metering units that will be located physically between the Generator Disconnect Switch (B1-05) located in the Howard Wind Farm Substation and the NYSEG disconnect switch (B1-06) located in the Spencer Hill Substation as identified in Figure A-1 in Appendix A. The substation will contain a 115 kV-34.5 kV 42/56/70 MVA 8.1% Z @ 42 MVA transformer to serve two 34.5 kV collector circuits. One of the collector circuits will connect to 15 wind turbines; the other will connect to 10 wind turbines. Each turbine will be connected to the 34.5 kV system through a 34.5 kV (delta) - 690 v (grounded wye) 2750 kVA 5.75% Z transformer.
Developer Operating Requirements
The Developer must comply with the Connecting Transmission Owner’s operating instructions and requirements including but not limited to Connecting Transmission Owner’s Operation Coordination Agreement, as it may change from time to time. The Developer must comply with all applicable NYISO tariffs and procedures, as amended from time to time.
The post-transition period LVRT standard, as set forth in Appendix G, is applicable to the Developer’s Large Generating Facility.
For purposes of compliance with Appendix G, the Connecting Transmission Owner has determined that the Developer shall maintain the Large Generating Facility in service during a three-phase fault for nine (9) cycles.
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
Appendix D
Security Arrangements Details
Infrastructure security of New York State Transmission System equipment and operations and control hardware and software is essential to ensure day-to-day New York State Transmission System reliability and operational security. The Commission will expect the NYISO, all Connecting Transmission Owners, all Developers and all other Market Participants to comply with the recommendations offered by the President’s Critical Infrastructure Protection Board and, eventually, best practice recommendations from the electric reliability authority. All public utilities will be expected to meet basic standards for system infrastructure and operational security, including physical, operational, and cyber-security practices.
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
Appendix E
Commercial Operation Date
[Date]
New York Independent System Operator, Inc.
Attn: Vice President, Operations
3890 Carman Road
Schenectady, NY 12303
New York State Electric & Gas Corporation
Attn: Manager - Programs/Projects
Electric Transmission Services
18 Link Drive
Binghamton, NY 13902-5224
Re:_____________ Large Generating Facility
Dear __________________:
On [Date] [Developer] has completed Trial Operation of Unit No. ___. This letter confirms that [Developer] commenced Commercial Operation of Unit No. ___ at the Large Generating Facility, effective as of [Date plus one day].
Thank you.
[Signature]
[Developer Representative]
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
Appendix F
Addresses for Delivery of Notices and Billings
Before commercial operation of the Large Generating Facility:
New York Independent System Operator, Inc.
Attn: Henry Chao
Vice President, System and Resource Planning
10 Krey Boulevard
Rensselaer, NY 12144
Phone: (518) 356-6000
Fax: (518) 356-6118
After commercial operation of the Large Generating Facility
New York Independent System Operator, Inc.
Attn: Vice President, Operations
3890 Carman Road
Schenectady, NY 12303
Phone: (518) 356-6000
Fax: (518) 356-6118
Connecting Transmission Owner:
New York State Electric & Gas Corporation
Attn: Manager - Programs/Projects
Electric Transmission Services
18 Link Drive
Binghamton, NY 13902-5224
Phone: (607) 762-7606
Fax: (607) 762-8666
Howard Wind LLC
c/o EverPower Wind Holdings Inc.
Attn: Andrew Golembeski
44 East 30th Street, 10th Floor
New York, NY 10016
Phone: (212) 647-8111
Connecting Transmission Owner:
New York State Electric & Gas Corporation
Attn: Manager - Programs/Projects
Electric Transmission Services
18 Link Drive
Binghamton, NY 13902-5224
Phone: (607) 762-7606
Fax: (607) 762-8666
Howard Wind LLC
c/o EverPower Wind Holdings Inc.
Attn: Andrew Golembeski
44 East 30th Street, 10th Floor
New York, NY 10016
Phone (212) 647-8111
Alternative Forms of Delivery of Notices (telephone, facsimile or email):
Before commercial operation of the Large Generating Facility:
New York Independent System Operator, Inc.
Attn: Henry Chao
Vice President, System and Resource Planning
10 Krey Boulevard
Rensselaer, NY 12144
Phone: (518) 356-6000
Fax: (518) 356-6118
After commercial operation of the Large Generating Facility
New York Independent System Operator, Inc.
Attn: Vice President, Operations
3890 Carman Road
Schenectady, NY 12303
Phone: (518) 356-6000
Fax: (518) 356-6118
Connecting Transmission Owner:
New York State Electric & Gas Corporation
Attn: Manager - Programs/Projects
Electric Transmission Services
18 Link Drive
Binghamton, NY 13902-5224
Phone: (607) 762-7606
Fax: (607) 762-8666
Howard Wind LLC
c/o EverPower Wind Holdings Inc.
Attn: Andrew Golembeski
44 East 30th Street, 10th Floor
New York, NY 10016
Phone: (212) 647-8111
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
NYISO Agreements --> LGIA among NYISO, NYSEG, and Howard Wind
Appendix G
Interconnection Requirements for a Wind Generating Plant
Appendix G sets forth requirements and provisions specific to a wind generating plant. All other requirements of this LGIA continue to apply to wind generating plant interconnections.
A.Technical Standards Applicable to a Wind Generating Plant
i. Low Voltage Ride-Through (LVRT) Capability
A wind generating plant shall be able to remain online during voltage disturbances up to the time periods and associated voltage levels set forth in the standard below. The LVRT standard provides for a transition period standard and a post-transition period standard.
Transition Period LVRT Standard
The transition period standard applies to wind generating plants subject to FERC Order 661 that have either: (i) interconnection agreements signed and filed with the Commission, filed with the Commission in unexecuted form, finally executed as conforming agreements, or filed with the Commission as non-conforming agreements between January 1, 2006 and December 31, 2006, with a scheduled in-service date no later than December 31, 2007, or (ii) wind
generating turbines subject to a wind turbine procurement contract executed prior to December 31, 2005, for delivery through 2007.
1.Wind generating plants are required to remain in-service during three-phase faults with normal clearing (which is a time period of approximately 4 – 9 cycles) and single line to ground faults with delayed clearing, and subsequent post-fault voltage recovery to prefault voltage unless clearing the fault effectively disconnects the generator from the system. The clearing time requirement for a three-phase fault will be specific to the wind generating plant substation location, as determined by and documented by the Connecting Transmission Owner for the Transmission District to which the wind generating plant will be interconnected. The maximum clearing time the wind generating plant shall be required to withstand for a three-phase fault shall be 9 cycles at a voltage as low as 0.15 p.u., as measured at the high side of the wind generating plant step-up transformer (i.e. the transformer that steps the voltage up to the transmission interconnection voltage or “GSU”), after which, if the fault remains following the location-specific normal clearing time for three-phase faults, the wind generating plant may disconnect from the transmission system.
2.This requirement does not apply to faults that would occur between the wind generator terminals and the high side of the GSU or to faults that would result in a voltage lower than 0.15 per unit on the high side of the GSU serving the facility.
3.Wind generating plants may be tripped after the fault period if this action is intended as part of a special protection system.
4.Wind generating plants may meet the LVRT requirements of this standard by the performance of the generators or by installing additional equipment (e.g., Static VAr Compensator, etc.) within the wind generating plant or by a combination of generator performance and additional equipment.
5.Existing individual generator units that are, or have been, interconnected to the network at the same location at the effective date of the Appendix G LVRT
Standard are exempt from meeting the Appendix G LVRT Standard for the remaining life of the existing generation equipment. Existing individual generator units that are replaced are required to meet the Appendix G LVRT Standard.
Post-transition Period LVRT Standard
All wind generating plants subject to FERC Order No. 661 and not covered by the transition period described above must meet the following requirements:
1.Wind generating plants are required to remain in-service during three-phase faults with normal clearing (which is a time period of approximately 4 – 9 cycles) and single line to ground faults with delayed clearing, and subsequent post-fault voltage recovery to prefault voltage unless clearing the fault effectively disconnects the generator from the system. The clearing time requirement for a three-phase fault will be specific to the wind generating plant substation location, as determined by and documented by the Connecting Transmission Owner for the Transmission District to which the wind generating plant will be interconnected. The maximum clearing time the wind generating plant shall be required to withstand for a three-phase fault shall be 9 cycles after which, if the fault remains following the location-specific normal clearing time for three-phase faults, the wind generating plant may disconnect from the transmission system. A wind generating plant shall remain interconnected during such a fault on the transmission system for a voltage level as low as zero volts, as measured at the high voltage side of the wind GSU.
2.This requirement does not apply to faults that would occur between the wind generator terminals and the high side of the GSU.
3.Wind generating plants may be tripped after the fault period if this action is intended as part of a special protection system.
4.Wind generating plants may meet the LVRT requirements of this standard by the performance of the generators or by installing additional equipment (e.g., Static VAr Compensator) within the wind generating plant or by a combination of generator performance and additional equipment.
5.Existing individual generator units that are, or have been, interconnected to the network at the same location at the effective date of the Appendix G LVRT Standard are exempt from meeting the Appendix G LVRT Standard for the remaining life of the existing generation equipment. Existing individual generator units that are replaced are required to meet the Appendix G LVRT Standard.
ii. Power Factor Design Criteria (Reactive Power)
A wind generating plant shall maintain a power factor within the range of 0.95 leading to 0.95 lagging, measured at the Point of Interconnection as defined in this LGIA, if the ISO’s System Reliability Impact Study shows that such a requirement is necessary to ensure safety or reliability.
The power factor range standards can be met using, for example without limitation, power electronics designed to supply this level of reactive capability (taking into account any limitations due to voltage level, real power output, etc.) or fixed and switched capacitors if agreed to by the Connecting Transmission Owner for the Transmission District to which the wind generating plant will be interconnected, or a combination of the two. The Developer shall not disable power factor equipment while the wind plant is in operation. Wind plants shall also be able to provide sufficient dynamic voltage support in lieu of the power system stabilizer and automatic voltage regulation at the generator excitation system if the System Reliability Impact Study shows this to be required for system safety or reliability.
iii. Supervisory Control and Data Acquisition (SCADA) Capability
The wind plant shall provide SCADA capability to transmit data and receive instructions from the ISO and/or the Connecting Transmission Owner for the Transmission District to which the wind generating plant will be interconnected, as applicable, to protect system reliability. The Connecting Transmission Owner for the Transmission District to which the wind generating plant will be interconnected and the wind plant Developer shall determine what SCADA information is essential for the proposed wind plant, taking into account the size of the plant and its characteristics, location, and importance in maintaining generation resource adequacy and transmission system reliability in its area.
Effective Date: 2/11/2011 - Docket #: ER11-2953-000 - Page 1
