NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
amended and restated
INTERCONNECTION AGREEMENT
BY AND AMONG
NEW YORK INDEPENDENT SYSTEM OPERATOR, INC.
AND
NIAGARA MOHAWK POWER CORPORATION d/b/a NATIONAL GRID
AND
ATLANTIC WIND, LLC
(FAIRFIELD PROJECT)
Dated as of December 13, 2010
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
TABLE OF CONTENTS
Page
ARTICLE 1 DEFINITIONS
ARTICLE 2 EFFECTIVE DATE, TERM AND TERMINATION
2.1Effective Date
2.2Term of Agreement
2.3Termination.
2.4Termination Costs
2.5Disconnection
2.6Survival
ARTICLE 3 REGULATORY FILINGS
3.1Filing
ARTICLE 4 SCOPE OF INTERCONNECTION SERVICE
4.1Provision of Service
4.2No Transmission Delivery Service
4.3No Other Services
ARTICLE 5 INTERCONNECTION FACILITIES ENGINEERING, PROCUREMENT, AND CONSTRUCTION
5.1Options
5.2General Conditions Applicable to Option to Build
5.3Liquidated Damages
5.4Power System Stabilizers
5.5Equipment Procurement
5.6Construction Commencement
5.7Work Progress
5.8Information Exchange
5.9Limited Operation
5.10Developer’s Attachment Facilities (“DAF”)
5.11Transmission Owner’s Attachment Facilities Construction
5.12Access Rights
5.13Lands of Other Property Owners
5.14Permits
5.15Early Construction of Base Case Facilities
5.16Suspension
5.17Taxes.
5.18Tax Status; Non-Jurisdictional Entities.
5.19Modification.
ARTICLE 6 TESTING AND INSPECTION
6.1Pre-Commercial Operation Date Testing and Modifications
6.2Post-Commercial Operation Date Testing and Modifications
6.3Right to Observe Testing
6.4Right to Inspect
ARTICLE 7 METERING
7.1General
7.2Check Meters
7.3Standards
7.4Testing of Metering Equipment
7.5Metering Data
ARTICLE 8 COMMUNICATIONS
8.1Developer Obligations
8.2Remote Terminal Unit
8.3No Annexation
ARTICLE 9 OPERATIONS
9.1General
9.2NYISO and Transmission Owner Obligations
9.3Developer Obligations
9.4Start-Up and Synchronization
9.5Reactive Power.
9.6Outages and Interruptions.
9.7Switching and Tagging Rules
9.8Use of Attachment Facilities by Third Parties.
9.9Disturbance Analysis Data Exchange
ARTICLE 10 MAINTENANCE
10.1Transmission Owner Obligations
10.2Developer Obligations
10.3Coordination
10.4Secondary Systems
10.5Operating and Maintenance Expenses
ARTICLE 11 PERFORMANCE OBLIGATION
11.1Developer Attachment Facilities
11.2Transmission Owner’s Attachment Facilities
11.3System Upgrade Facilities
11.4Special Provisions for Affected Systems
11.5Provision of Security
11.6Developer Compensation for Emergency Services
11.7Line Outage Costs
ARTICLE 12 INVOICE
12.1General
12.2Final Invoice
12.3Payment
12.4Disputes
ARTICLE 13 EMERGENCIES
13.1Obligations
13.2Notice
13.3Immediate Action
13.4NYISO and Transmission Owner Authority.
13.5Developer Authority
13.6Limited Liability
ARTICLE 14 REGULATORY REQUIREMENTS AND GOVERNING LAW
14.1Regulatory Requirements
14.2Governing Law.
ARTICLE 15 NOTICES
15.1General
15.2Billings and Payments
15.3Alternative Forms of Notice
15.4Operations and Maintenance Notice
ARTICLE 16 FORCE MAJEURE
16.1Force Majeure.
ARTICLE 17 DEFAULT
17.1Default.
ARTICLE 18 INDEMNITY, CONSEQUENTIAL DAMAGES AND INSURANCE
18.1Indemnity
18.2No Consequential Damages
18.3Insurance
ARTICLE 19 ASSIGNMENT
19.1Assignment
ARTICLE 20 SEVERABILITY
20.1Severability
ARTICLE 21 COMPARABILITY
21.1Comparability
ARTICLE 22 CONFIDENTIALITY
22.1Confidentiality
ARTICLE 23 ENVIRONMENTAL RELEASES
23.1Developer and Transmission Owner Notice
ARTICLE 24 INFORMATION REQUIREMENT
24.1Information Acquisition
24.2Information Submission by Transmission Owner
24.3Updated Information Submission by Developer
24.4Information Supplementation
ARTICLE 25 INFORMATION ACCESS AND AUDIT RIGHTS
25.1Information Access
25.2Reporting of Non-Force Majeure Events
25.3Audit Rights
25.4Audit Rights Periods.
25.5Audit Results
ARTICLE 26 SUBCONTRACTORS
26.1General
26.2Responsibility of Principal
26.3No Limitation by Insurance
ARTICLE 27 DISPUTES
27.1Submission
27.2External Arbitration Procedures
27.3Arbitration Decisions
27.4Costs
27.5Termination
ARTICLE 28 REPRESENTATIONS, WARRANTIES AND COVENANTS
28.1General
ARTICLE 29 MISCELLANEOUS
29.1Binding Effect
29.2Conflicts
29.3Rules of Interpretation
29.4Compliance
29.5Joint and Several Obligations
29.6Entire Agreement
29.7No Third Party Beneficiaries
29.8Waiver
29.9Headings
29.10Multiple Counterparts
29.11Amendment
29.12Modification by the Parties
29.13Reservation of Rights
29.14No Partnership
29.15Other Transmission Rights
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
AMENDED AND RESTATED STANDARD LARGE GENERATOR
INTERCONNECTION AGREEMENT
THIS AMENDED AND RESTATED STANDARD LARGE GENERATOR INTERCONNECTION AGREEMENT (“Agreement”) is made and entered into this 13th day of December 2010, by and among Atlantic Wind, LLC, a limited liability company organized and existing under the laws of the State of Oregon (“Developer” with a Large Generating Facility), the New York Independent System Operator, Inc., a not-for-profit corporation organized and existing under the laws of the State of New York (“NYISO”), and Niagara Mohawk Power Corporation d/b/a National Grid, a corporation organized and existing under the laws of the State of New York (“Transmission Owner”). Developer, the NYISO, or Transmission Owner each may be referred to as a “Party” or collectively referred to as the “Parties.”
RECITALS
WHEREAS, NYISO operates the Transmission System and Transmission Owner owns certain facilities included in the Transmission System; and
WHEREAS, Developer intends to own, lease and/or control and operate the Generating Facility identified as a Large Generating Facility in Appendix C to this Agreement; and
WHEREAS, Developer, NYISO, and Transmission Owner have agreed to enter into this Agreement for the purpose of interconnecting the Large Generating Facility with the New York State Transmission System.
NOW, THEREFORE, in consideration of and subject to the mutual covenants contained herein, it is agreed:
Whenever used in this Agreement with initial capitalization, the following terms shall have the meanings specified in this Article 1. Terms used in this Agreement with initial capitalization that are not defined in this Article 1 shall have the meanings specified in Section 1.0 or Attachment S of the NYISO OATT.
Affected System shall mean an electric system other than the transmission system owned, controlled or operated by the NYISO or the Transmission Owner that may be affected by the proposed interconnection.
Affected System Operator shall mean the entity that operates an Affected System.
Affiliate shall mean, with respect to a person or entity, any individual, corporation, partnership, firm, joint venture, association, joint-stock company, trust or unincorporated organization, directly or indirectly controlling, controlled by, or under common control with, such person or entity. The term “control” shall mean the possession, directly or indirectly, of the power to direct the management or policies of a person or an entity. A voting interest of ten percent or more shall create a rebuttable presumption of control.
Ancillary Services shall mean those services that are necessary to support the transmission of Capacity and Energy from resources to Loads while maintaining reliable operation of the New York State Transmission System in accordance with Good Utility Practice.
Applicable Laws and Regulations shall mean all duly promulgated applicable federal, state and local laws, regulations, rules, ordinances, codes, decrees, judgments, directives, or judicial or administrative orders, permits and other duly authorized actions of any Governmental Authority, including but not limited to Environmental Law.
Applicable Reliability Councils shall mean the NERC, the NPCC and the NYSRC.
Applicable Reliability Standards shall mean the requirements and guidelines of the Applicable Reliability Councils, and the Transmission District to which the Developer’s Large Generating Facility is directly interconnected, as those requirements and guidelines are amended and modified and in effect from time to time; provided that no Party shall waive its right to challenge the applicability or validity of any requirement or guideline as applied to it in the context of this Agreement.
Attachment Facilities shall mean the Transmission Owner’s Attachment Facilities and the Developer’s Attachment Facilities. Collectively, Attachment Facilities include all facilities and equipment between the Large Generating Facility and the Point of Interconnection, including any modification, additions or upgrades that are necessary to physically and electrically interconnect the Large Generating Facility to the New York State Transmission System. Attachment Facilities are sole use facilities and shall not include Stand Alone System Upgrade Facilities or System Upgrade Facilities.
Base Case shall mean the base case power flow, short circuit, and stability data bases used for the Interconnection Studies by NYISO, Transmission Owner or Developer; described in Section 2.3 of the Large Facility Interconnection Procedures.
Breach shall mean the failure of a Party to perform or observe any material term or condition of this Agreement.
Breaching Party shall mean a Party that is in Breach of this Agreement.
Business Day shall mean Monday through Friday, excluding federal holidays.
Calendar Day shall mean any day including Saturday, Sunday or a federal holiday.
Clustering shall mean the process whereby a group of Interconnection Requests is studied together, instead of serially, for the purpose of conducting the Interconnection System Reliability Impact Study.
Commercial Operation shall mean the status of a Large Generating Facility that has commenced generating electricity for sale, excluding electricity generated during Trial Operation.
Commercial Operation Date of a unit shall mean the date on which the Large Generating Facility commences Commercial Operation as agreed to by the Parties pursuant to Appendix E to this Agreement.
Confidential Information shall mean any information that is defined as confidential by Article 22 of this Agreement.
Control Area shall mean an electric power system or combination of electric power systems to which a common automatic generation control scheme is applied in order to: (1) match, at all times, the power output of the Generators within the electric power system(s) and capacity and energy purchased from entities outside the electric power system(s), with the Load within the electric power system(s); (2) maintain scheduled interchange with other Control Areas, within the limits of Good Utility Practice; (3) maintain the frequency of the electric power system(s) within reasonable limits in accordance with Good Utility Practice; and (4) provide sufficient generating capacity to maintain Operating Reserves in accordance with Good Utility Practice. A Control Area must be certified by the NPCC.
Default shall mean the failure of a Party in Breach of this Agreement to cure such Breach in accordance with Article 17 of this Agreement.
Developer shall mean an Eligible Customer developing a Large Generating Facility, proposing to connect to the New York State Transmission System, in compliance with the NYISO Minimum Interconnection Standard.
Developer’s Attachment Facilities shall mean all facilities and equipment, as identified in Appendix A of this Agreement, that are located between the Large Generating Facility and the Point of Change of Ownership, including any modification, addition, or upgrades to such facilities and equipment necessary to physically and electrically interconnect the Large Generating Facility to the New York State Transmission System. Developer’s Attachment Facilities are sole use facilities.
Dispute Resolution shall mean the procedure described in Article 27 of this Agreement for resolution of a dispute between the Parties.
Effective Date shall mean the date on which this Agreement becomes effective upon execution by the Parties, subject to acceptance by the Commission, or if filed unexecuted, upon the date specified by the Commission.
Emergency State shall mean the condition or state that the New York State Power System is in when an abnormal condition occurs that requires automatic or immediate manual action to prevent or limit loss of the New York State Transmission System or Generators that could adversely affect the reliability of the New York State Power System.
Engineering & Procurement (E&P) Agreement shall mean an agreement that authorizes Transmission Owner to begin engineering and procurement of long lead-time items necessary for the establishment of the interconnection in order to advance the implementation of the Interconnection Request.
Environmental Law shall mean Applicable Laws or Regulations relating to pollution or protection of the environment or natural resources.
Federal Power Act shall mean the Federal Power Act, as amended, 16 U.S.C. §§ 791a et seq. (“FPA”).
FERC shall mean the Federal Energy Regulatory Commission (“Commission”) or its successor.
Force Majeure shall mean any act of God, labor disturbance, act of the public enemy, war, insurrection, riot, fire, storm or flood, explosion, breakage or accident to machinery or equipment, any order, regulation or restriction imposed by governmental, military or lawfully established civilian authorities, or any other cause beyond a Party’s control. A Force Majeure event does not include acts of negligence or intentional wrongdoing by the Party claiming Force Majeure.
Generating Facility shall mean Developer’s device for the production of electricity identified in the Interconnection Request, but shall not include the Developer’s Attachment Facilities.
Generating Facility Capacity shall mean the net seasonal capacity of the Generating Facility and the aggregate net seasonal capacity of the Generating Facility where it includes multiple energy production devices.
Good Utility Practice shall mean any of the practices, methods and acts engaged in or approved by a significant portion of the electric industry during the relevant time period, or any of the practices, methods and acts which, in the exercise of reasonable judgment in light of the facts known at the time the decision was made, could have been expected to accomplish the desired result at a reasonable cost consistent with good business practices, reliability, safety and expedition. Good Utility Practice is not intended to be limited to the optimum practice, method, or act to the exclusion of all others, but rather to delineate acceptable practices, methods, or acts generally accepted in the region.
Governmental Authority shall mean any federal, state, local or other governmental regulatory or administrative agency, court, commission, department, board, or other governmental subdivision, legislature, rulemaking board, tribunal, or other governmental authority having jurisdiction over any of the Parties, their respective facilities, or the respective services they provide, and exercising or entitled to exercise any administrative, executive, police, or taxing authority or power; provided, however, that such term does not include Developer, NYISO Transmission Owner, or any Affiliate thereof.
Hazardous Substances shall mean any chemicals, materials or substances defined as or included in the definition of “hazardous substances,” “hazardous wastes,” “hazardous materials,” “hazardous constituents,” “restricted hazardous materials,” “extremely hazardous substances,” “toxic substances,” “radioactive substances,” “contaminants,” “pollutants,” “toxic pollutants” or words of similar meaning and regulatory effect under any applicable Environmental Law, or any other chemical, material or substance, exposure to which is prohibited, limited or regulated by any applicable Environmental Law.
Initial Synchronization Date shall mean the date upon which the Large Generating Facility is initially synchronized and upon which Trial Operation begins.
In-Service Date shall mean the date upon which the Developer reasonably expects it will be ready to begin use of the Transmission Owner’s Attachment Facilities to obtain back feed power.
Interconnection Facilities Study shall mean a study conducted by NYISO or a third party consultant for the Developer to determine a list of facilities (including Transmission Owner’s Attachment Facilities and System Upgrade Facilities as identified in the Interconnection System Reliability Impact Study), the cost of those facilities, and the time required to interconnect the Large Generating Facility with the New York State Transmission System. The scope of the study is defined in Section 8 of the Standard Large Facility Interconnection Procedures.
Interconnection Facilities Study Agreement shall mean the form of agreement contained in Appendix 4 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection Facilities Study.
Interconnection Feasibility Study shall mean a preliminary evaluation of the system impact and cost of interconnecting the Large Generating Facility to the New York State Transmission System, the scope of which is described in Section 6 of the Standard Large Facility Interconnection Procedures.
Interconnection Feasibility Study Agreement shall mean the form of agreement contained in Appendix 2 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection Feasibility Study.
Interconnection Request shall mean a Developer’s request, in the form of Appendix 1 to the Standard Large Facility Interconnection Procedures, in accordance with the Tariff, to interconnect a new Large Generating Facility to the New York State Transmission System, or to increase the capacity of, or make a material modification to the operating characteristics of, an existing Large Generating Facility that is interconnected with the New York State Transmission System.
Interconnection Study shall mean any of the following studies: the Interconnection Feasibility Study, the Interconnection System Reliability Impact Study, and the Interconnection Facilities Study described in the Standard Large Facility Interconnection Procedures.
Interconnection System Reliability Impact Study (“SRIS”) shall mean an engineering study, conducted in accordance with Section 7 of the Large Facility Interconnection Procedures, that evaluates the impact of the proposed Large Generating Facility on the safety and reliability of the New York State Transmission System and, if applicable, an Affected System, to determine what Attachment Facilities and System Upgrade Facilities are needed for the proposed Large Generation Facility of the Developer to connect reliably to the New York State Transmission System in a manner that meets the NYISO Minimum Interconnection Standard.
Interconnection System Reliability Impact Study Agreement shall mean the form of agreement contained in Appendix 3 of the Standard Large Facility Interconnection Procedures for conducting the Interconnection System Reliability Impact Study.
IRS shall mean the Internal Revenue Service.
Large Generating Facility shall mean a Generating Facility having a Generating Facility Capacity of more than 20 MW.
Loss shall mean any and all losses relating to injury to or death of any person or damage to property, demand, suits, recoveries, costs and expenses, court costs, attorney fees, and all other obligations by or to third parties, arising out of or resulting from the Indemnified Party’s performance or non-performance of its obligations under this Agreement on behalf of the indemnifying Party, except in cases of gross negligence or intentional wrongdoing by the Indemnified Party.
Material Modification shall mean those modifications that have a material impact on the cost or timing of any Interconnection Request with a later queue priority date.
Metering Equipment shall mean all metering equipment installed or to be installed at the Large Generating Facility pursuant to this Agreement at the metering points, including but not limited to instrument transformers, MWh-meters, data acquisition equipment, transducers, remote terminal unit, communications equipment, phone lines, and fiber optics.
Minimum Interconnection Standard shall mean the reliability standard that must be met by any Large Generating Facility proposing to connect to the New York State Transmission System. The Standard is designed to ensure reliable access by the proposed project to the New York State Transmission System. The Standard does not impose any deliverability test or deliverability requirement on the proposed interconnection.
NERC shall mean the North American Electric Reliability Council or its successor organization.
Network Access Interconnection Service shall mean the service provided by NYISO to interconnect the Developer’s Large Generating Facility to the New York State Transmission System in accordance with the NYISO Minimum Interconnection Standard, to enable the New York State Transmission System to receive electric energy and capacity from the Large Generating Facility at the Point of Interconnection, pursuant to the terms of this Agreement and the NYISO OATT.
New York State Transmission System shall mean the entire New York State electric transmission system, which includes (i) the Transmission Facilities under ISO Operational Control; (ii) the Transmission Facilities Requiring ISO Notification; and (iii) all remaining transmission facilities within the New York Control Area.
Notice of Dispute shall mean a written notice of a dispute or claim that arises out of or in connection with this Agreement or its performance.
NPCC shall mean the Northeast Power Coordinating Council or its successor organization.
NYSRC shall mean the New York State Reliability Council or its successor organization.
Optional Interconnection Study shall mean a sensitivity analysis based on assumptions specified by the Developer in the Optional Interconnection Study Agreement.
Optional Interconnection Study Agreement shall mean the form of agreement contained in Appendix 5 of the Standard Large Facility Interconnection Procedures for conducting the Optional Interconnection Study.
Party or Parties shall mean NYISO, Transmission Owner, or Developer or any combination of the above.
Point of Change of Ownership shall mean the point, as set forth in Appendix A to this Agreement, where the Developer’s Attachment Facilities connect to the Transmission Owner’s Attachment Facilities.
Point of Interconnection shall mean the point, as set forth in Appendix A to this Agreement, where the Attachment Facilities connect to the New York State Transmission System.
Queue Position shall mean the order of a valid Interconnection Request, relative to all other pending valid Interconnection Requests, that is established based upon the date and time of receipt of the valid Interconnection Request by NYISO.
Reasonable Efforts shall mean, with respect to an action required to be attempted or taken by a Party under this Agreement, efforts that are timely and consistent with Good Utility Practice and are otherwise substantially equivalent to those a Party would use to protect its own interests.
Scoping Meeting shall mean the meeting between representatives of the Developer, NYISO and Transmission Owner conducted for the purpose of discussing alternative interconnection options, to exchange information including any transmission data and earlier study evaluations that would be reasonably expected to impact such interconnection options, to analyze such information, and to determine the potential feasible Points of Interconnection.
Services Tariff shall mean the NYISO Market Administration and Control Area Tariff, as filed with the Commission, and as amended or supplemented from time to time, or any successor tariff thereto.
Site Control shall mean documentation reasonably demonstrating: (1) ownership of, a leasehold interest in, or a right to develop a site for the purpose of constructing the Large Generating Facility; (2) an option to purchase or acquire a leasehold site for such purpose; or (3) an exclusivity or other business relationship between Developer and the entity having the right to sell, lease or grant Developer the right to possess or occupy a site for such purpose.
Stand Alone System Upgrade Facilities shall mean System Upgrade Facilities that a Developer may construct without affecting day-to-day operations of the New York State Transmission System during their construction. NYISO, the Transmission Owner and the Developer must agree as to what constitutes Stand Alone System Upgrade Facilities and identify them in Appendix A to this Agreement.
Standard Large Facility Interconnection Procedures (“LFIP”) shall mean the interconnection procedures applicable to an Interconnection Request pertaining to a Large Generating Facility that are included in Attachment X of the NYISO OATT.
Standard Large Generator Interconnection Agreement (“LGIA”) shall mean this Agreement, the form of interconnection agreement applicable to an Interconnection Request pertaining to a Large Generating Facility, that is included in Attachment X of the NYISO OATT.
System Protection Facilities shall mean the equipment, including necessary protection signal communications equipment, required to (1) protect the New York State Transmission System from faults or other electrical disturbances occurring at the Large Generating Facility and (2) protect the Large Generating Facility from faults or other electrical system disturbances occurring on the New York State Transmission System or on other delivery systems or other generating systems to which the New York State Transmission System is directly connected.
System Upgrade Facilities shall mean the least costly configuration of commercially available components of electrical equipment that can be used, consistent with good utility practice and Applicable Reliability Requirements, to make the modifications to the existing transmission system that are required to maintain system reliability due to: (i) changes in the system, including such changes as load growth and changes in load pattern, to be addressed in the form of generic generation or transmission projects; and (ii) proposed interconnections. In the case of proposed interconnection projects, System Upgrade Facilities are the modifications or additions to the existing New York State Transmission System that are required for the proposed project to connect reliably to the system in a manner that meets the NYISO Minimum Interconnection Standard.
Tariff shall mean the NYISO Open Access Transmission Tariff (“OATT”), as filed with the Commission, and as amended or supplemented from time to time, or any successor tariff.
Transmission Owner shall mean the public utility or authority (or its designated agent) that (i) owns facilities used for the transmission of Energy in interstate commerce and provides Transmission Service under the Tariff, (ii) owns, leases or otherwise possesses an interest in the portion of the New York State Transmission System at the Point of Interconnection, and (iii) is a Party to this Agreement.
Transmission Owner’s Attachment Facilities shall mean all facilities and equipment owned, controlled or operated by the Transmission Owner from the Point of Change of Ownership to the Point of Interconnection as identified in Appendix A to this Agreement, including any modifications, additions or upgrades to such facilities and equipment. Transmission Owner’s Attachment Facilities are sole use facilities and shall not include, Stand Alone System Upgrade Facilities or System Upgrade Facilities.
Trial Operation shall mean the period during which Developer is engaged in on-site test operations and commissioning of the Large Generating Facility prior to Commercial Operation.
If a Developer terminates this Agreement, it shall be responsible for all costs incurred in association with that Developer’s interconnection, including any cancellation costs relating to orders or contracts for Attachment Facilities and equipment, and other expenses including any System Upgrade Facilities for which the Transmission Owner has incurred expenses and has not been reimbursed by the Developer.
However, in no event shall the total liquidated damages exceed 20 percent of the actual cost of the Transmission Owner Attachment Facilities and System Upgrade Facilities for which the Transmission Owner has assumed responsibility to design, procure, and construct. The foregoing payments will be made by the Transmission Owner to the Developer as just compensation for the damages caused to the Developer, which actual damages are uncertain and impossible to determine at this time, and as reasonable liquidated damages, but not as a penalty or a method to secure performance of this Agreement. Liquidated damages, when the Developer and Transmission Owner agree to them, are the exclusive remedy for the Transmission Owner’s failure to meet its schedule. Further, Transmission Owner shall not pay liquidated damages to Developer if: (1) Developer is not ready to commence use of the Transmission Owner’s Attachment Facilities or System Upgrade Facilities to take the delivery of power for the Developer’s Large Generating Facility’s Trial Operation or to export power from the Developer’s Large Generating Facility on the specified dates, unless the Developer would have been able to commence use of the Transmission Owner’s Attachment Facilities or System Upgrade Facilities to take the delivery of power for Developer’s Large Generating Facility’s Trial Operation or to export power from the Developer’s Large Generating Facility, but for Transmission Owner’s delay; (2) the Transmission Owner’s failure to meet the specified dates is the result of the action or inaction of the Developer or any other Developer who has entered into a Standard Large Generator Interconnection Agreement with the Transmission Owner and NYISO, or action or inaction by any other Party, or any other cause beyond Transmission Owner’s reasonable control or reasonable ability to cure; (3) the Developer has assumed responsibility for the design, procurement and construction of the Transmission Owner’s Attachment Facilities and Stand Alone System Upgrade Facilities; or (4) the Transmission Owner and Developer have otherwise agreed. In no event shall NYISO have any liability whatever to Developer for liquidated damages associated with the engineering, procurement or construction of Attachment Facilities or System Upgrade Facilities.
The Transmission Owner shall not transfer operational control of the Transmission Owner’s Attachment Facilities and Stand Alone System Upgrade Facilities to the NYISO upon completion of such facilities.
Transmission Owner shall invoice Developer for such costs pursuant to Article 12 and shall use due diligence to minimize its costs. In the event Developer suspends work by Transmission Owner required under this Agreement pursuant to this Article 5.16, and has not requested Transmission Owner to recommence the work required under this Agreement on or before the expiration of three (3) years following commencement of such suspension, this Agreement shall be deemed terminated. The three-year period shall begin on the date the suspension is requested, or the date of the written notice to Transmission Owner and NYISO, if no effective date is specified.
At Transmission Owner’s request, Developer shall provide Transmission Owner with a report from an independent engineer confirming its representation in clause (iii), above. Transmission Owner represents and covenants that the cost of the Transmission Owner’s Attachment Facilities paid for by Developer will have no net effect on the base upon which rates are determined.
Transmission Owner shall not include a gross-up for the cost consequences of any current tax liability in the amounts it charges Developer under this Agreement unless (i) Transmission Owner has determined, in good faith, that the payments or property transfers made by Developer to Transmission Owner should be reported as income subject to taxation or (ii) any Governmental Authority directs Transmission Owner to report payments or property as income subject to taxation; provided, however, that Transmission Owner may require Developer to provide security, in a form reasonably acceptable to Transmission Owner (such as a parental guarantee or a letter of credit), in an amount equal to the cost consequences of any current tax liability under this Article 5.17. Developer shall reimburse Transmission Owner for such costs on a fully grossed-up basis, in accordance with Article 5.17.4, within thirty (30) Calendar Days of receiving written notification from Transmission Owner of the amount due, including detail about how the amount was calculated.
This indemnification obligation shall terminate at the earlier of (1) the expiration of the ten-year testing period and the applicable statute of limitation, as it may be extended by the Transmission Owner upon request of the IRS, to keep these years open for audit or adjustment, or (2) the occurrence of a subsequent taxable event and the payment of any related indemnification obligations as contemplated by this Article 5.17.
For this purpose, (i) Current Taxes shall be computed based on Transmission Owner’s composite federal and state tax rates at the time the payments or property transfers are received and Transmission Owner will be treated as being subject to tax at the highest marginal rates in effect at that time (the “Current Tax Rate”), and (ii) the Present Value Depreciation Amount shall be computed by discounting Transmission Owner’s anticipated tax depreciation deductions as a result of such payments or property transfers by Transmission Owner’s current weighted average cost of capital. Thus, the formula for calculating Developer’s liability to Transmission Owner pursuant to this Article 5.17.4 can be expressed as follows: (Current Tax Rate x (Gross Income Amount - Present Value of Tax Depreciation))/(1 - Current Tax Rate).
Developer’s estimated tax liability in the event taxes are imposed shall be stated in Appendix A, Attachment Facilities and System Upgrade Facilities.
Transmission Owner shall keep Developer fully informed of the status of such request for a private letter ruling and shall execute either a privacy act waiver or a limited power of attorney, in a form acceptable to the IRS, that authorizes Developer to participate in all discussions with the IRS regarding such request for a private letter ruling. Transmission Owner shall allow Developer to attend all meetings with IRS officials about the request and shall permit Developer to prepare the initial drafts of any follow-up letters in connection with the request.
Developer shall pay to Transmission Owner on a periodic basis, as invoiced by Transmission Owner, Transmission Owner’s documented reasonable costs of prosecuting such appeal, protest, abatement or other contest. At any time during the contest, Transmission Owner may agree to a settlement either with Developer’s consent or after obtaining written advice from nationally-recognized tax counsel, selected by Transmission Owner, but reasonably acceptable to Developer, that the proposed settlement represents a reasonable settlement given the hazards of litigation. Developer’s obligation shall be based on the amount of the settlement agreed to by Developer, or if a higher amount, so much of the settlement that is supported by the written advice from nationally-recognized tax counsel selected under the terms of the preceding sentence. The settlement amount shall be calculated on a fully grossed-up basis to cover any related cost consequences of the current tax liability. Any settlement without Developer’s consent or such written advice will relieve Developer from any obligation to indemnify Transmission Owner for the tax at issue in the contest.
Such modifications are expected to interrupt the flow of electricity from the Large Generating Facility. The Party desiring to perform such work shall provide the relevant drawings, plans, and specifications to the other Party and NYISO at least ninety (90) Calendar Days in advance of the commencement of the work or such shorter period upon which the Parties may agree, which agreement shall not unreasonably be withheld, conditioned or delayed.
In the case of Large Generating Facility modifications that do not require Developer to submit an Interconnection Request, Transmission Owner shall provide, within thirty (30) Calendar Days (or such other time as the Parties may agree), an estimate of any additional modifications to the New York State Transmission System, Transmission Owner’s Attachment Facilities or System Upgrade Facilities necessitated by such Developer modification and a good faith estimate of the costs thereof.
Each Party will promptly advise the appropriate other Party if it detects or otherwise learns of any metering, telemetry or communications equipment errors or malfunctions that require the attention and/or correction by that other Party. The Party owning such equipment shall correct such error or malfunction as soon as reasonably feasible.
The Developer shall design and maintain the plant auxiliary systems to operate safely throughout the entire real and reactive power design range.
The Transmission Owner shall not unreasonably restrict or condition the reactive power production or absorption of the Large Generating Facility in accordance with Good Utility Practice.
NYISO and Transmission Owner shall use Reasonable Efforts to minimize the effect of such actions or inactions on the Large Generating Facility or the Developer Attachment Facilities. NYISO or Transmission Owner may, on the basis of technical considerations, require the Large Generating Facility to mitigate an Emergency State by taking actions necessary and limited in scope to remedy the Emergency State, including, but not limited to, directing Developer to shut-down, start-up, increase or decrease the real or reactive power output of the Large Generating Facility; implementing a reduction or disconnection pursuant to Article 13.4.2; directing the Developer to assist with blackstart (if available) or restoration efforts; or altering the outage schedules of the Large Generating Facility and the Developer Attachment Facilities. Developer shall comply with all of the NYISO and Transmission Owner’s operating instructions concerning Large Generating Facility real power and reactive power output within the manufacturer’s design limitations of the Large Generating Facility’s equipment that is in service and physically available for operation at the time, in compliance with Applicable Laws and Regulations.
A Party may change the notice information in this Agreement by giving five (5) Business Days written notice prior to the effective date of the change.
Except as stated below, the Indemnifying Party shall have the right to assume the defense thereof with counsel designated by such Indemnifying Party and reasonably satisfactory to the Indemnified Party. If the defendants in any such action include one or more Indemnified Parties and the Indemnifying Party and if the Indemnified Party reasonably concludes that there may be legal defenses available to it and/or other Indemnified Parties which are different from or additional to those available to the Indemnifying Party, the Indemnified Party shall have the right to select separate counsel to assert such legal defenses and to otherwise participate in the defense of such action on its own behalf. In such instances, the Indemnifying Party shall only be required to pay the fees and expenses of one additional attorney to represent an Indemnified Party or Indemnified Parties having such differing or additional legal defenses.
The Indemnified Party shall be entitled, at its expense, to participate in any such action, suit or proceeding, the defense of which has been assumed by the Indemnifying Party. Notwithstanding the foregoing, the Indemnifying Party (i) shall not be entitled to assume and control the defense of any such action, suit or proceedings if and to the extent that, in the opinion of the Indemnified Party and its counsel, such action, suit or proceeding involves the potential imposition of criminal liability on the Indemnified Party, or there exists a conflict or adversity of interest between the Indemnified Party and the Indemnifying Party, in such event the Indemnifying Party shall pay the reasonable expenses of the Indemnified Party, and (ii) shall not settle or consent to the entry of any judgment in any action, suit or proceeding without the consent of the Indemnified Party, which shall not be unreasonably withheld, conditioned or delayed.
If requested by a Party receiving information, the Party supplying the information shall provide in writing, the basis for asserting that the information referred to in this Article warrants confidential treatment, and the requesting Party may disclose such writing to the appropriate Governmental Authority. Each Party shall be responsible for the costs associated with affording confidential treatment to its information.
If the Developer’s data is materially different from what was originally provided to Transmission Owner and NYISO pursuant to an Interconnection Study Agreement among Transmission Owner, NYISO and Developer, then NYISO will conduct appropriate studies to determine the impact on the New York State Transmission System based on the actual data submitted pursuant to this Article 24.3. The Developer shall not begin Trial Operation until such studies are completed.
Unless otherwise agreed, the test conditions shall include: (1) Large Generating Facility at synchronous speed; (2) automatic voltage regulator on and in voltage control mode; and (3) a five percent change in Large Generating Facility terminal voltage initiated by a change in the voltage regulators reference voltage. Developer shall provide validated test recordings showing the responses of Large Generating Facility terminal and field voltages. In the event that direct recordings of these voltages is impractical, recordings of other voltages or currents that mirror the response of the Large Generating Facility’s terminal or field voltage are acceptable if information necessary to translate these alternate quantities to actual Large Generating Facility terminal or field voltages is provided. Large Generating Facility testing shall be conducted and results provided to the Transmission Owner and NYISO for each individual generating unit in a station.
Subsequent to the Commercial Operation Date, the Developer shall provide Transmission Owner and NYISO any information changes due to equipment replacement, repair, or adjustment. Transmission Owner shall provide the Developer and NYISO any information changes due to equipment replacement, repair or adjustment in the directly connected substation or any adjacent Transmission Owner substation that may affect the Developer Attachment Facilities equipment ratings, protection or operating requirements. The Developer and Transmission Owner shall provide such information no later than thirty (30) Calendar Days after the date of the equipment replacement, repair or adjustment.
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
IN WITNESS WHEREOF, the Parties have executed this Agreement in duplicate originals, each of which shall constitute and be an original effective Agreement between the Parties.
New York Independent System | Niagara Mohawk Power Corporation |
![]() Atlantic Wind, LLC
|
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDICES
Appendix A
Attachment Facilities and System Upgrade Facilities
Appendix B
Milestones
Appendix C
Interconnection Details
Appendix D
Security Arrangements Detail
Appendix E
Commercial Operation Date
Appendix F
Addresses for Delivery of Notices and Billings
Appendix G
Interconnection Requirements For a Wind Generating Plant
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDIX a
Attachment Facilities and System Upgrade Facilities
1. Attachment Facilities
(a) Developer’s Attachment Facilities
Developer will design and construct a 34.5/115 kV collector substation (“Hardscrabble Substation”) and a 115 kV bus, approximately 10 feet in length, from the Developer’s Hardscrabble Substation to the Point of Change of Ownership. Developer shall design and construct the Developer’s Attachment Facilities in accordance with the applicable requirements of Transmission Owner, as set out in National Grid Electric System Bulletin 756, dated May 2007, to the extent not inconsistent with the terms of this Agreement or the NYISO OATT and in accordance with the Transmission Owner’s project specific electrical requirements as documented in the project’s Specification for Electrical Installation dated December 4, 2007 to the extent not inconsistent with the terms of this Agreement or the NYISO OATT.
The Hardscrabble Substation shall include, but is not limited to:
(b) Transmission Owner’s Attachment Facilities
i. Transmission Owner’s Attachment Facilities to be Constructed by Developer:
ii. Developer will procure and install one 115kV, 2000 Amp, three-phase disconnect switch with operating-arm operated auxiliary switch, the associated support structure and the bus that connects the switch to the three breaker interconnection station ( “Fairfield Station”) The Developer will also provide a location within the Fairfield Station for adequate metering sockets to accommodate the Transmission Owners revenue meters. The Developer will procure and install three (3) single phase PT/CT metering units rated for 115kV operation. The Transmission Owner shall perform engineering review and operational testing and/or inspecting of the Transmission Owner’s Attachment Facilities.
iii. Transmission Owner’s Attachment Facilities to be constructed by Transmission Owner:
Transmission Owner will procure and install one (1) revenue meter, to be installed in Fairfield Station.
(a) Stand Alone System Upgrade Facilities
Developer will design and construct the Fairfield Station near the Point of Interconnection to the Valley-Inghams #3 115 kV line system in accordance with the “Interconnection Facilities Study Report for the Interconnection of the Fairfield Wind Farm 115kV 120 MW Project” dated June 6, 2007 including Document #ST.0200.001 “General-Substation Design, TOAF, Fairfield Facility (“Transmission Owner’s Specifications”). Developer will arrange for the installation of any third party communication lines required to support protection and operations data communications.
The Fairfield Station will include a 115 kV switchyard, which Developer will construct, that will be equipped with, but is not limited to, the following:
The Fairfield Station will also include a Control House, which Developer will construct, that will be equipped with, but is not limited to, the following:
(b)System Upgrade Facilities to be Constructed by the Transmission Owner
i. Physical Interconnection of Interconnection Station: On property acquired and permitted by the Developer, the Transmission Owner shall design and construct the 115 kV transmission line loop-in and out to physically interconnect the Fairfield Station at the take-off structure to the Transmission Owner’s existing 115 kV Valley-Inghams #3 line and associated ROW. The new lines will be designated # 12 Line, Valley to Fairfield, and the # 3 Line, Fairfield to Inghams Station.
ii. Valley Station: The Transmission Owner will design and construct System Upgrade Facilities at Valley Station, including line Relay Protection Packages associated with the addition of the Fairfield Station in the existing 115 kV Valley - Inghams #3 line.
All modifications will adhere to NPCC Document A-5: Bulk Power System Protection Criteria. Control and protection additions/ replacements will include:
iii. Inghams Station: The Transmission Owner will design and construct System Upgrade Facilities at Inghams Station, including line Relay Protection Packages associated with the addition of the Interconnection Station in the existing 115 kV Valley - Inghams #3 line.
The following required detail modifications are associated with the #3 Valley-Inghams Line and the changes as a result of the #3 Line being split to accommodate the Fairfield Station. All modifications will adhere to NPCC Document A-5: Bulk Power System Protection Criteria.
3.Controls and Protection: to be provided by Developer as part of the Stand Alone System Upgrade Facilities.
(a) Protection Packages for all three 115 kV transmission lines as follows:
i. Line to Valley. Primary system will be a Permissive Over-Reaching Transfer Trip (“POTT”) communication scheme with multi-function line protection relay and audio-tone communication system, including telephone circuit. Alternate system will be a directional comparison un-blocking (“DCUB”) communication system with multi-function line protection relay and power line carrier system.
ii. Line to Inghams. Primary system will be a POTT communication scheme with a multi-function line protection relay and audio-tone communication system, including telephone circuit. Alternate system will be a directional comparison blocking (DCB) communication scheme with multi-function line protection relay and power line carrier system.
iii. Line to Hardscrabble Substation. Primary system will be a line current differential relay with fiber-optic communications between the stations. Alternate system will be a communications scheme that utilizes POTT with a multi-function line protection relay.
(b) Breaker failure protection (primary and alternate) relays and Direct Transfer Trip (“DTT”) transmit/receive capability to/from Valley & Inghams Station’s remote breakers via carrier and audio-tone, including telephone circuit, DTT receive relays, carrier transmit/receive system, and audio-tone transmit/receive system.
(c) Breaker failure protection (primary and alternate) relays and DTT transmit capability to/from Collection Station’s remote breakers via copper cable installed between the stations.
(d) Cabinets to accommodate the above listed items, as necessary.
(e) Fairfield EMS/RTU with telco provided data circuit to Central Regional Control in Liverpool, NY.
(f) Communications between Hardscrabble RTU and Fairfield RTU via developer owned fiber optic cable.
(h) Annunciator for local status/alarm indication.
Cost Estimates from Class Year Facilities Study for the Transmission Owner’s Attachment Facilities and System Upgrade Facilities.
(a) Transmission Owner’s Attachment Facilities: The estimated cost is $295,750.
(b) System Upgrade Facilities: The estimated cost is $5,695,004.
5.O&M Expenses
In accordance with Article 10.5 of this LGIA, the Developer shall be responsible for all reasonable expenses (“O&M Expenses”) associated with the operation, maintenance, repair and replacement of the Transmission Owner’s Attachment Facilities.
The Developer shall have the option to pay such O&M Expenses either under the procedure described in Option 1 or in Option 2 below.
(a) Option 1: Fixed On-Going Charge Payment:
The Transmission Owner will invoice and Developer shall pay an annual payment to the Transmission Owner equal to the product of the Gross Plant Investment associated with the Transmission Owner’s Attachment Facilities and the Annual Transmission Ongoing Charge Factor, for the term of this Interconnection Agreement.
All payments due to be made by the Developer shall be made within thirty (30) days after receiving an invoice from the Transmission Owner.
The Project’s Gross Transmission Owner’s Attachment Facilities Plant Investment cost shall be established in writing by the TO no later than 90 days following commercial operation.
The Annual On-Going Charge Factor shall be calculated annually each July based on the Company’s most recent FERC Form 1 data and will equal the sum of the Revenue Requirement Components as identified on Attachment 1 divided by the Total Gross Plant of the Transmission Owner. Total Gross Plant shall equal the sum of Item Nos. A(1)(a), (b) and (c) in Attachment 1.
(b) Option 2: Annual Actual O&M Expenses
The Developer shall pay for all actual O&M Expenses incurred by the Transmission Owner, which expenses shall be billed by the Transmission Owner quarterly as accumulated during the quarter for which they were incurred.
All payments due to be made by the Developer shall be made within thirty (30) days after receiving an invoice from the Transmission Owner, which invoice shall be issued after the end of each quarter for the most recent quarter.
(c) Selection by Developer
The Developer shall select an option for paying O&M Expenses by providing written notice to the Transmission Owner within thirty (30) days after the Gross Transmission Owner’s Attachment Facilities Plant Investment cost and the most recent Annual Transmission Ongoing Charge Factor have been provided to the Developer. If the Developer fails to provide timely notice to the Transmission Owner of the option selected, the Developer will be deemed to have selected Option 2: Annual Actual.
Figure 1
ATTACHMENT 1
Capitalized terms used in this calculation will have the following definitions:
Allocation Factors
(i) General Plant Allocation Factor shall equal Electric General Plant divided by the sum of Electric General Plant plus gas general plant as reported in the Annual Report filed with the New York State Public Service Commission.
(ii) Gross Transmission Plant Allocation Factor shall equal the total investment in Transmission Plant in Service divided by the sum of the total Transmission Plant in Service plus the total Distribution Plant in Service, excluding Intangible Plant, General Plant and Common Plant.
(iii) Transmission Wages and Salaries Allocation Factor shall equal the ratio of NMPC Transmission-related direct electric wages and salaries including any direct wages or salaries charged to NMPC by a National Grid Affiliate to NMPC’s total electric direct wages and salaries including any wages charged to NMPC by a National Grid Affiliate excluding any electric administrative and general wages and salaries.
Ratebase and Expense items
(i) Administrative and General Expense shall equal electric expenses as recorded in FERC Account Nos. 920-935.
(ii) Amortization of Investment Tax Credits shall equal electric credits as recorded in FERC Account No. 411.4.
(iii) Distribution Plant in Service shall equal the gross plant balance as recorded in FERC Account Nos. 360 – 374.
(iv) Electric Common Plant shall equal the balance of Common Plant recorded in FERC Account Nos. 389-399 multiplied by the General Plant Allocation Factor.
(v) General Plant shall equal electric gross general plant balance recorded in FERC Account Nos. 389-399.
(vi) Materials and Supplies shall equal electric materials and supplies balance as recorded in FERC Account No. 154.
(vii) Payroll Taxes shall equal those electric payroll tax expenses as recorded in FERC Account Nos. 408.100, 408.110 and 408.130.
(viii) Prepayments shall equal electric prepayment balance as recorded in FERC Account No. 165.
(ix) Real Estate Tax Expenses shall equal electric transmission-related real estate tax expense as recorded in FERC Account No. 408.140 and 408.180.
(x) Transmission Operation and Maintenance Expense shall equal electric expenses as recorded in FERC Account Nos. 560, 562-573.
(xi) Transmission Plant in Service shall equal the gross plant balance as recorded in FERC Account Nos. 350-359.
(xii) Transmission Revenue Credits shall equal the revenue reported in Account 456
(xiii) Transmission Related Bad Debt Expense shall equal Bad Debt Expense as reported in Account 904 related to transmission billing.
(xiv) Wholesale Metering Cost shall equal any costs associated with any Revenue or Remote Terminal Unit (RTU) meters and associated equipment located at an internal or external tie at voltages equal to or greater than 23V. The cost shall be determined by multiplying the number of wholesale meters in FERC Account No. 370.3 by the average cost of the meters plus the average costs of installation.
In the event that the above-referenced FERC accounts are renumbered, renamed, or otherwise modified, the above sections shall be deemed amended to incorporate such renumbered, renamed, modified or additional accounts.
Components
The Component shall be the sum of NMPC’s (A) Return and Associated Income Taxes, (B) Transmission Related Real Estate Tax Expense, (C) Transmission Related Amortization of Investment Tax Credits, (D) Transmission Related Payroll Tax Expense (E) Transmission Operation and Maintenance Expense, (F) Transmission Related Administrative and General Expenses, less (G) Revenue Credits, plus (H) Bad Debt Expense.
A.Return and Associated Income Taxes shall equal the product of the Transmission Investment Base as identified in A(1) below and the Cost of Capital Rate.
1.Transmission Investment Base shall be defined as
Transmission Related General Plant plus Transmission Related Common Plant plus Transmission Related Regulatory Assets plus Transmission Related Prepayments plus Transmission Related Materials and Supplies plus Transmission Related Cash Working Capital.
(a)Transmission Plant in Service shall equal the balance of Total investment in Transmission Plant plus Wholesale Metering Cost.
(b)Transmission Related General Plant shall equal the balance of investment in General Plant multiplied by the Transmission Wages and Salaries Allocation Factor.
(c)Transmission Related Common Plant shall equal Electric Common Plant multiplied by the Gross Transmission Plant Allocation Factor and multiplied by the Transmission Wages and Salaries Allocation Factor.
(d) Transmission Related Regulatory Assets shall equal balances in FERC Account Nos. 182.3 and 254 for state and federal regulatory assets and liabilities related to FAS109, and excess AFUDC multiplied by the Gross Transmission Plant Allocation Factor
(e)Transmission Related Prepayments shall equal the electric balance of Prepayments multiplied by the Gross Transmission Plant Allocation Factor.
(f)Transmission Related Materials and Supplies shall equal the balance of Materials and Supplies assigned to Transmission added to the remainder of Material and Supplies not directly assigned to either Transmission or Distribution multiplied by the Gross Transmission Plant Allocation Factor.
(g)Transmission Related Cash Working Capital shall be a 12.5% allowance (45 days/360 days) of the Transmission Operation and Maintenance Expense (less FERC Account 565: Transmission of Electricity by Others) and Transmission-Related Administrative and General Expense.
2.Cost of Capital Rate
The Cost of Capital Rate shall equal the proposed Weighted Costs of Capital plus Federal Income Taxes and State Income Taxes.
(a)The Weighted Costs of Capital will be calculated for the Transmission Investment Base using NMPC’s actual capital structure and will equal the sum of (i), (ii), and (iii) below:
(i)the long-term debt component, which equals the product of the actual weighted average embedded cost to maturity of NMPC’s long-term debt then outstanding and the actual long-term debt capitalization ratio.
(ii)the preferred stock component, which equals the product of the actual weighted average embedded cost to maturity of NMPC’s preferred stock then outstanding and the actual preferred stock capitalization ratio;
(iii)the return on equity component, shall be the product of the allowed ROE of 11.9% plus a 50 basis point adder (per FERC Order 697 and 697A) and NMPC’s actual common equity capitalization ratio.
(b)Federal Income Tax shall equal
A x Federal Income Tax Rate
(1 - Federal Income Tax Rate)
where A is the sum of the preferred stock component and the return on equity component, each as determined in Sections 2.(a)(ii) and for the ROE set forth in 2.(a)(iii) above
(c)State Income Tax shall equal
(A + Federal Income Tax) x State Income Tax Rate
(1 – State Income Tax Rate)
Where A is the sum of the preferred stock component and the return on equity component as determined in A.2.(a)(ii) and A.2.(a)(iii) above and Federal income Tax is determined in 2.(b) above.
B.Transmission Related Real Estate Tax Expense shall equal the Real Estate Tax Expenses multiplied by the Gross Plant Allocation Factor.
C.Transmission Related Amortization of Investment Tax Credits shall equal the electric Amortization of Investment Tax Credits multiplied by the Gross Transmission Plant Allocation Factor.
D.Transmission Related Payroll Tax Expense shall equal Payroll Taxes multiplied by the Transmission Wages and Salaries Allocation Factor.
E.Transmission Operation and Maintenance Expense shall equal the Transmission Operation and Maintenance Expense as previously defined.
F.Transmission Related Administrative and General Expenses shall equal the sum of the electric Administrative and General Expenses multiplied by the Transmission Wages and Salaries Allocation Factor.
G.Revenue Credits shall equal all Transmission revenue recorded in FERC account 456.
H.Transmission Related Bad Debt Expense shall equal Transmission Related Bad Debt Expense as previously defined.
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDIX B
Milestones
1.Selected Option pursuant to Article 5.1
Under Article 5.1 of this LGIA, Developer and Transmission Owner have selected the Option to Build, except for Transmission Owner’s activities described in Sections 1(b)(ii) and 2(b) of Appendix A which shall be performed in accordance with the Standard Option. Further, the Parties have agreed to the division of responsibilities and scope as detailed in Appendix A, Sections 1 and 2.
(a) Developer and Transmission Owner Milestones
Milestones
2.Security
In accordance with Section 11.5, Developer will provide security to Transmission Owner in an amount equal to the estimate for the work to be performed by the Transmission Owner on the Attachment Facilities including engineering review, field inspection and testing, and start-up costs to be billed to the Developer for the Transmission Owner’s Attachment Facilities construction, and excluding the estimated cost of the work to be performed by the Developer on the Attachment Facilities. This security is estimated at $275,000.
The parties agree that the Developer will provide security to Transmission Owner for the System Upgrade Facilities in the amount of $1,900,000 on or around the date of execution of this Interconnection Agreement. This security is being provided because the ring bus which was classified as an Attachment Facility in the Class Year 2006 Interconnection Facilities Study is now classified as a System Upgrade Facility.
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDIX C
Interconnection Details
1.Description of Large Generating Facility including Point of Interconnection

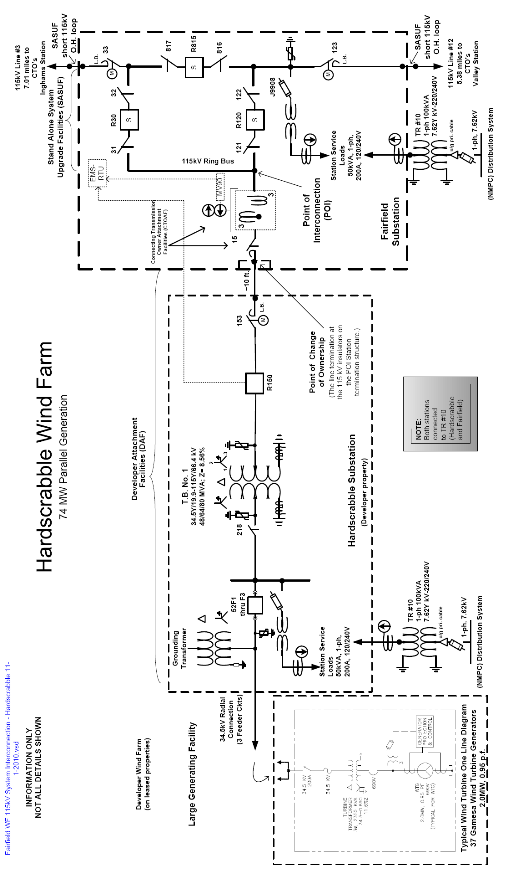

The Large Generating Facility is a 74 MW wind power facility that will employ thirty-seven Gamesa 2 MW wind-turbine induction generators. Each of the thirty-seven units has a reactive power capability corresponding to a power factor range of 0.95 lagging to 0.95 leading (at the generator terminals) giving a gross plant reactive capability of +24 MVAR to -24 MVAR (sum of unit capabilities).
Each generator operates at 0.69 kV and is connected to a generator step-up transformer (GSU) to increase voltage to the 34.5 kV collection system voltage. Each GSU is a three-phase grounded-wye / delta transformer rated 0.690/34.5 kV, 2350 kVA. Each GSU is connected to a collection system that has a total of three (3) 34.5 kV collector circuits. Two collector circuits each have twelve (12) wind turbines connected, while the third collector circuit has thirteen (13) wind turbines connected.
The Large Generating Facility will interconnect to Transmission Owner’s Valley-Inghams #3 115 kV transmission line. The Point of Interconnection will be approximately 5.38 miles from the Valley Station and 7.01 miles from the Inghams Station. The Large Generating Facility will be located in the Towns of Fairfield, Norway and Little Falls in Herkimer County, New York. The Point of Interconnection is identified on Figure 1, in Appendix A.
2.Developer Operating Requirements
(a) Developer must comply with all applicable NYISO tariffs and procedures, as amended from time to time.
(b) Developer must comply with Transmission Owner’s operating instructions and requirements as referenced in Article 9.3 of this Agreement, which requirements shall include the dedicated data circuits, including system protection circuits, to be maintained by Developer in accordance with Article 8.1 of this Agreement.
(c) The Post-transition Period LVRT standard, as set forth in Appendix G, paragraph A.i to this Agreement, is applicable to Developer’s Large Generating Facility. For purposes of compliance with Appendix G, Transmission Owner has determined that Developer shall maintain the Large Generating Facility in service during a three-phase fault for nine cycles.
.
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDIX D
Security Arrangements Details
Infrastructure security of New York State Transmission System equipment and operations and control hardware and software is essential to ensure day-to-day New York State Transmission System reliability and operational security. The Commission will expect the NYISO, all Transmission Owners, all Developers and all other Market Participants to comply with the recommendations offered by the President’s Critical Infrastructure Protection Board and, eventually, best practice recommendations from the electric reliability authority. All public utilities will be expected to meet basic standards for system infrastructure and operational security, including physical, operational, and cyber-security practices.
.
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDIX E
Commercial Operation Date
[Date]
New York Independent System Operator, Inc. Attn: Vice President, Operations | Niagara Mohawk Power Corporation 300 Erie Boulevard W. Syracuse, NY 13202 Attn: Manager, Transmission Commercial Services
Niagara Mohawk Power Corporation 300 Erie Boulevard W. Syracuse, NY 13202 Attn: Manager, Power Control NY
|
Re:_____________ Large Generating Facility
Dear __________________:
On [Date] [Developer] has completed Trial Operation of Unit No. ___. This letter confirms that [Developer] commenced Commercial Operation of Unit No. ___ at the Large Generating Facility, effective as of [Date plus one day].
Thank you.
[Signature]
[Developer Representative]
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDIX F
Addresses for Delivery of Notices and Billings
1.Notices:
(a)NYISO:
(i)Before commercial operation of the Large Generating Facility:
New York Independent System Operator, Inc.
Attn: Vice President, System and Resource Planning
10 Krey Boulevard
Rensselaer, NY 12144
Phone: (518) 356-6000
Fax: (518) 356-6118
(ii)After commercial operation of the Large Generating Facility
New York Independent System Operator, Inc.
Attn: Vice President, Operations
3890 Carman Road
Schenectady, NY 12303
Phone: (518) 356-6000
Fax: (518) 356-6118
(b)Transmission Owner:
Niagara Mohawk Power Corporation d/b/a National Grid
Attn : William Malee
Manager, Transmission Commercial Services
300 Erie Boulevard W.
Syracuse, NY 13202
Phone: (315)428-5048
Fax: (315)428-5114
(c)Developer:
Atlantic Wind LLC
c/o Iberdrola Renewables, Inc
Attn: Asset Manager, Hardscrabble Wind Project
1125 NW Couch Street, Suite 700
Portland, OR 97209
and
Atlantic Wind LLC
c/o Iberdrola Renewables, Inc
Attn: Contract Administrator
1125 NW Couch Street, Suite 700
Portland, OR 97209
Phone: (503)796-7000
Fax: (503)796-6937
2.Billings and Payments:
(a)Transmission Owner:
Niagara Mohawk Power Corporation d/b/a National Grid
Attn: Douglas Fuess, Transmission Account Manager
300 Erie Boulevard W.
Syracuse, NY 13202
(b)Developer:
Atlantic Wind LLC
c/o Iberdrola Renewables, Inc
Attn: Asset Manager, Hardscrabble Wind Project
1125 NW Couch Street, Suite 700
Portland, OR 97209
and
Atlantic Wind LLC
c/o Iberdrola Renewables, Inc
Attn: Contract Administrator
1125 NW Couch Street, Suite 700
Portland, OR 97209
Phone: (503)796-7000
Fax: (503)796-6937
3.Alternative Forms of Delivery of Notices (telephone, facsimile or email):
(a)NYISO:
(i)Before commercial operation of the Large Generating Facility:
New York Independent System Operator, Inc.
Attn: Vice President, System and Resource Planning
10 Krey Boulevard
Rensselaer, NY 12144
Phone: (518) 356-6000
Fax: (518) 356-6118
(ii)After commercial operation of the Large Generating Facility
New York Independent System Operator, Inc.
Attn: Vice President, Operations
3890 Carman Road
Schenectady, NY 12303
Phone: (518) 356-6000
Fax: (518) 356-6118
(b)Transmission Owner:
Niagara Mohawk Power Corporation d/b/a National Grid
Attn: Manager, Transmission Commercial Services
300 Erie Boulevard W.
Syracuse, NY 13202
Phone: (315)428-5048
Fax: (315)428-5114
(c)Developer:
Atlantic Wind LLC
c/o Iberdrola Renewables, Inc
Attn: Asset Manager, Hardscrabble Wind Project
1125 NW Couch Street, Suite 700
Portland, OR 97209
and
Atlantic Wind LLC
c/o Iberdrola Renewables, Inc
Attn: Contract Administrator
1125 NW Couch Street, Suite 700
Portland, OR 97209
Phone: (503)796-7000
Fax: (503)796-6937
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
NYISO Agreements --> LGIA among NYISO, National Grid and Atlantic Wind
APPENDIX G
Interconnection Requirements for A Wind Generating Plant
Appendix G sets forth requirements and provisions specific to a wind generating plant. All other requirements of this Agreement continue to apply to wind generating plant interconnections.
A.Technical Standards Applicable to a Wind Generating Plant
i.Low Voltage Ride-Through (LVRT) Capability
A wind generating plant shall be able to remain online during voltage disturbances up to the time periods and associated voltage levels set forth in the standard below. The LVRT standard provides for a transition period standard and a post-transition period standard.
Transition Period LVRT Standard
The transition period standard applies to wind generating plants subject to FERC Order 661 that have either: (i) interconnection agreements signed and filed with the Commission, filed with the Commission in unexecuted form, finally executed as conforming agreements, or filed with the Commission as non-conforming agreements between January 1, 2006 and December 31, 2006, with a scheduled in-service date no later than December 31, 2007, or (ii) wind generating turbines subject to a wind turbine procurement contract executed prior to December 31, 2005, for delivery through 2007.
1.Wind generating plants are required to remain in-service during three-phase faults with normal clearing (which is a time period of approximately 4 – 9 cycles) and single line to ground faults with delayed clearing, and subsequent post-fault voltage recovery to prefault voltage unless clearing the fault effectively disconnects the generator from the system. The clearing time requirement for a three-phase fault will be specific to the wind generating plant substation location, as determined by and documented by the Transmission Owner for the Transmission District to which the wind generating plant will be interconnected. The maximum clearing time the wind generating plant shall be required to withstand for a three-phase fault shall be 9 cycles at a voltage as low as 0.15 p.u., as measured at the high side of the wind generating plant step-up transformer (i.e. the transformer that steps the voltage up to the transmission interconnection voltage or “GSU”), after which, if the fault remains following the location-specific normal clearing time for three-phase faults, the wind generating plant may disconnect from the transmission system.
2.This requirement does not apply to faults that would occur between the wind generator terminals and the high side of the GSU or to faults that would result in a voltage lower than 0.15 per unit on the high side of the GSU serving the facility.
3.Wind generating plants may be tripped after the fault period if this action is intended as part of a special protection system.
4.Wind generating plants may meet the LVRT requirements of this standard by the performance of the generators or by installing additional equipment (e.g., Static VAr Compensator, etc.) within the wind generating plant or by a combination of generator performance and additional equipment.
5.Existing individual generator units that are, or have been, interconnected to the network at the same location at the effective date of the Appendix G LVRT Standard are exempt from meeting the Appendix G LVRT Standard for the remaining life of the existing generation equipment. Existing individual generator units that are replaced are required to meet the Appendix G LVRT Standard.
Post-transition Period LVRT Standard
All wind generating plants subject to FERC Order No. 661 and not covered by the transition period described above must meet the following requirements:
1.Wind generating plants are required to remain in-service during three-phase faults with normal clearing (which is a time period of approximately 4 – 9 cycles) and single line to ground faults with delayed clearing, and subsequent post-fault voltage recovery to prefault voltage unless clearing the fault effectively disconnects the generator from the system. The clearing time requirement for a three-phase fault will be specific to the wind generating plant substation location, as determined by and documented by the Transmission Owner for the Transmission District to which the wind generating plant will be interconnected. The maximum clearing time the wind generating plant shall be required to withstand for a three-phase fault shall be 9 cycles after which, if the fault remains following the location-specific normal clearing time for three-phase faults, the wind generating plant may disconnect from the transmission system. A wind generating plant shall remain interconnected during such a fault on the transmission system for a voltage level as low as zero volts, as measured at the high voltage side of the wind GSU.
2.This requirement does not apply to faults that would occur between the wind generator terminals and the high side of the GSU.
3.Wind generating plants may be tripped after the fault period if this action is intended as part of a special protection system.
4.Wind generating plants may meet the LVRT requirements of this standard by the performance of the generators or by installing additional equipment (e.g., Static VAr Compensator) within the wind generating plant or by a combination of generator performance and additional equipment.
5.Existing individual generator units that are, or have been, interconnected to the network at the same location at the effective date of the Appendix G LVRT Standard are exempt from meeting the Appendix G LVRT Standard for the remaining life of the existing generation equipment. Existing individual generator units that are replaced are required to meet the Appendix G LVRT Standard.
ii.Power Factor Design Criteria (Reactive Power)
A wind generating plant shall maintain a power factor within the range of 0.95 leading to 0.95 lagging, measured at the Point of Interconnection as defined in this Agreement, if the ISO’s System Reliability Impact Study shows that such a requirement is necessary to ensure safety or reliability.
The power factor range standard can be met using, for example without limitation, power electronics designed to supply this level of reactive capability (taking into account any limitations due to voltage level, real power output, etc.) or fixed and switched capacitors if agreed to by the Transmission Owner for the Transmission District to which the wind generating plant will be interconnected, or a combination of the two. The Developer shall not disable power factor equipment while the wind plant is in operation. Wind plants shall also be able to provide sufficient dynamic voltage support in lieu of the power system stabilizer and automatic voltage regulation at the generator excitation system if the System Reliability Impact Study shows this to be required for system safety or reliability.
iii.Supervisory Control and Data Acquisition (SCADA) Capability
The wind plant shall provide SCADA capability to transmit data and receive instructions from the ISO and/or the Transmission Owner for the Transmission District to which the wind generating plant will be interconnected, as applicable, to protect system reliability. The Transmission Owner for the Transmission District to which the wind generating plant will be interconnected and the wind plant Developer shall determine what SCADA information is essential for the proposed wind plant, taking into account the size of the plant and its characteristics, location, and importance in maintaining generation resource adequacy and transmission system reliability in its area.
Effective Date: 12/13/2010 - Docket #: ER11-2499-000 - Page 1
