10 Krey Boulevard   Rensselaer, NY  12144







June 1, 2015

Hon. Kimberly D. Bose, Secretary

Federal Energy Regulatory Commission 888 First Street, NE

Washington, DC 20426

Re:    New York Independent System Operator, Inc., Informational Report, Docket
No. AD14-6-00_

Dear Secretary Bose:

In accordance with Paragraph 23 and the ordering paragraph of the Commission’s
November 15, 2014 Order on Technical Conference (“November Order”),1 the New York
Independent System Operator, Inc. (“NYISO”) respectfully submits this informational report
(“Report”).  The November Order directed the “NYISO to explore the issues and evaluate the
proposals discussed at the conference, including the MMU’s recommendations, through its
stakeholder process and file an informational report.”2  This Report describes the various
stakeholder meetings convened, and review process conducted, by the NYISO after the February 26, 2014 Technical Conference3 (“Technical Conference”).  The issues discussed in this Report include “whether or not to model Load Zone K as an export-constrained zone for a future ICAP Demand Curve reset proceeding.4  It also discusses whether a proposal can be developed that
could reduce the cost of procuring capacity while meeting the NYISO loss of load (“LOLE”)
objective, as well as other proposals made by the NYISO, the independent Market Monitoring
Unit (“MMU”), and stakeholders at the Technical Conference.

Several related issues were raised by stakeholders at the Technical Conference and in
their written comments.  In addition to modeling Load Zone K5 as an export constrained zone,



1 New York Indep. Sys. Operator, Inc., 149 FERC ¶ 61,164 (2014) (“November Order”).

2 Id. at P 23.

3 See New York Indep. Sys. Operator, Inc., Notice of Technical Conference, Docket No. AD14-6-
000 (Jan. 28, 2014), Supplemental Notice of Technical Conference (Feb. 14, 2014), (collectively, the “Technical Conference Notice”).

4 November Order at P 2, citing certain NYISO pleadings in Docket No. ER13-1380 and the
August 13, 2013 order in that proceeding, New York Indep. Sys. Operator, Inc .,144 FERC ¶ 61,126 at
P 20.

5 Capitalized terms not defined herein have the meaning set forth in the NYISO’s Market

Administration and Control Area Services Tariff (“Services Tariff”) and if not defined therein, then in the Open Access Transmission Tariff (“OATT”).






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 2



stakeholders raised issues regarding the methodology to determine the Locational Minimum Installed Capacity Requirements (“LCRs”); rules to eliminate Localities or achieve price
convergence; enhancements to the triggers for creating and “pre-defining” capacity zones (i.e., Localities), and a capacity Deliverability right for transmission projects that increase the
deliverability of a constrained interface.

I.DOCUMENTS SUBMITTED

In support of this filing, the NYISO respectfully submits the following documents that
were provided to stakeholders in 2014 and to date in 2015 as part of the discussions with them:



1. Capacity Zone (Locality) Elimination, presented by the NYISO, at the October 30,

2014 joint meeting of the Market Issues Working Group and ICAP Working Group (“Attachment I”) (also available at:

<http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_miwg/m
eeting_materials/2014-10-30/Capacity_%20Zone_%20Elimination_Final_103014.pdf
>).



2.Capacity Zone (Locality) Pre-Define & Eliminate, presented by the NYISO, at the

November 17, 2014, ICAP Working Group meeting (“Attachment II”) (also available

at:

<http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_icapwg/
meeting_materials/2014-11-

17/Predefine_Eliminate_Capacity%20Zone_Nov17_Final.pdf>).



3. Treatment of Zone K Export Constraints into the G-J Locality: Market Design

Concept, presented by the NYISO, at the December 18, 2014 joint meeting of the
Market Issues Working Group and ICAP Working Group (“Attachment III”) (also
available at:

<http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_miwg/m
eeting_materials/2014-12-

18/agenda%203%20NCZ%20_%20Export%20Constrained%20Zones.pdf>).



4. Numeric Example posted by the NYISO with stakeholder meeting materials on its

website, on February 19, 2015 (“Attachment VII”) (also available at:

<http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_miwg/m
eeting_materials/2014-12-18/Numerical%20Example%20for%20the%2012-18-
2014%20Presentaion%20regarding%20Treatment%20of%20Zone%20K%20Export %20Constraints2.pdf>).



5. 2013 State of the Market Report Recommendation to Enhance Locational Pricing in

the Capacity Market, presented by Pallas Lee Van Schaick of Potomac Economics at






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 3





the August 20, and November 14, ICAP Working Group Meeting (“Attachment V”) (also available at:

<http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_icapwg/
meeting_materials/2014-11-14/Capacity_2013%20SOM__8172014.pdf>).



6. Compliance with FERC Order on Technical Conference re: Treatment of Zone K

Export Constraints into the G-J Locality, presented by the NYISO, at the February
24, 2015 ICAP Working Group meeting (“Attachment VI”) (also available at:
<http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_icapwg/
meeting_materials/2015-02-

24/agenda%203%20Export%20Constrained%20Zones_ICAPWG%202-24-
15_Final.pdf>).



7. IRM/LCR Process and Dynamics, presented by Mark Younger, Hudson Energy

Economics, at the January 29, 2015 joint meeting of the Market Issues Working Group, ICAP Working Group, and the Price Responsive Load Working Group (“Attachment VII”) (also available at:

<http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_miwg/m
eeting_materials/2015-01-

29/agenda%208%20IRM%20LCR%20Process%20Dynamics.pdf>).



8. LCR Process Review; Setting of the IRM and LCRs: the Basic Process; and LCR

Process Review: Next Steps; presented by the NYISO at the March 5, 2015 meeting
of the LCR Task Force (collectively, “Attachment VIII”) also available at:
˂http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_icapwg_
lcrtf/meeting_materials/2015-03-05/02_LCR%20Alternative%20for%20Kick-
off%20meeting.pdf˃, ˂

http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_icapwg_l
crtf/meeting_materials/2015-03-05/03_Background%20Slides_IRM_LCR.pdf˃; ˂
http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_icapwg_l
crtf/meeting_materials/2015-03-05/04_LCR%20Process%20Next%20Steps.pdf˃.

9. Objective of LCR Methodology Review: Possible Alternatives, presented by the

NYISO at the April 8, 2015 meeting of the LCR Task Force (“Attachment IX”) (also available at:

˂http://www.nyiso.com/public/webdocs/markets_operations/committees/bic_icapwg_
lcrtf/meeting_materials/2015-04-

08/LCR%20Objective_Possible%20Alternatives.pdf>).






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 4





II.BACKGROUND

On April 30, 2013, the NYISO filed revisions to its Services Tariff and its Open Access Transmission Tariff (“OATT”) to establish a new Locality that would encompass Load Zones G, H, I, and J but exclude Load Zone K (“the G-J Locality”).6  In that proceeding, certain parties argued that Load Zone K should have been included in the G-J Locality based on assertions that capacity located in Load Zone K could provide some level of support to Load Zones G, H, and I. Some parties also suggested that to the extent that Load Zone K warranted special consideration, it should be modeled as an “export-constrained” Load Zone.7

The Commission accepted the NYISO’s proposal to establish the G-J Locality (without
including Load Zone K.)8  It also directed the Commission’s staff to convene a technical
conference, in a separate proceeding, “to discuss with interested parties whether or not to model
Load Zone K as an export-constrained zone for a future ICAP Demand Curve reset proceeding.”9

The Technical Conference was established to principally discuss whether and how to

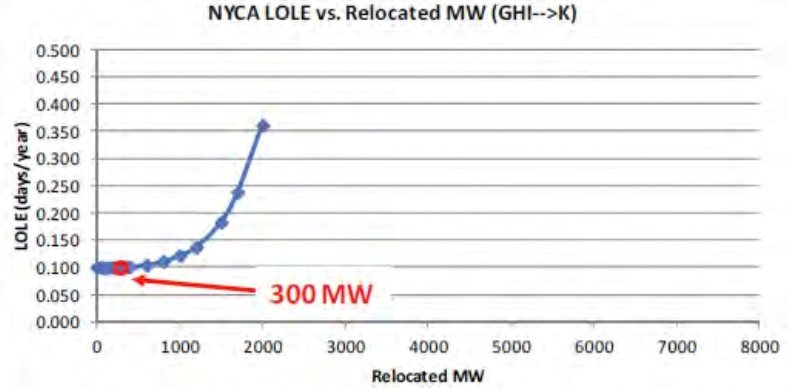

model Load Zone K as an export-constrained zone, including whether and how to determine the
MW limit to be placed on capacity located in Load Zone K that can be relied upon to serve the
needs of Load Zones G through J.10  At the Technical Conference, various other issues were
discussed that were related to, but that extended beyond the issues outlined in the Technical
Conference Notice.  These additional issues are described above.  Multiple parties submitted
post-conference comments that largely reiterated the discussion at the Technical Conference,
many of which had been previously raised in the NYISO’s stakeholder process.  The NYISO’s
post-conference comments suggested that the Commission should permit it to continue exploring
those issues and proposals through its stakeholder process.11  The NYISO explained that a
stakeholder process would:

[A]llow the NYISO to consider the process for setting [Locational Minimum

Installed Capacity Requirements (“LCRs”)] and how it may be adapted to

properly reflect export constrained aspects of Localities as well as the treatment of export constrained aspects of Localities in the auction clearing mechanism.



6 New York Indep. Sys. Operator, Inc., Proposed Tariff Revisions to Establish and Recognize a New Capacity Zone and Request for Action on Pending Compliance Filing, Docket No. ER13-1380-000 (April 30, 2013) (“April 2013 Filing”).

7 See November Order at P 2, describing  the NYISO’s position in, and other parties’ positions on, the April 2013 Filing.  See also New York Indep. Sys. Operator, Inc., 144 FERC ¶ 61,126 (2013) (“August 2013 Order”) at PP 32 - 51.

8 August 2013 Order at PP 52 - 55.

9 Id. at P 56.

10 Technical Conference Notice.

11 Post-Technical Conference Comments of the New York Indep. Sys. Operator, Inc., Docket No. AD14-6-000 (March 26, 2014).






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 5





Further, it would give the NYISO time to continue to consider the potential

development of alternative rules to pre-define and eliminate capacity zones.  It
would not risk displacing other priority projects, including those that are being
undertaken in response to earlier Commission compliance mandates or high
priority recommendations by the [MMU] for the NYISO.  Providing the
stakeholder process time to function would give the NYISO and its stakeholders
experience with G-J Locality pricing before completing the evaluation and
considering a decision on export constraint modeling.  A stakeholder process
would also permit the NYISO to consider changes to modeling rules in tandem
with the triennial process for evaluating and potentially creating New Capacity
Zones.12

The NYISO asked the Commission to delay further action until it had conducted stakeholder discussions and proposed to submit a report by June 1, 2015.13

The November Order accepted the NYISO’s proposal.  It concluded that:

[I]t would be worthwhile for NYISO and its stakeholders to explore whether a

proposal can be developed that could reduce the cost of procuring capacity while
meeting the NYISO LOLE objective.  Therefore, we accept NYISO’s
recommendation to conduct a stakeholder process and to file a report on this
process by June 1, 2015.  While we agree with NYISO that it is premature to
require it to file tariff language by June 1, 2015, we believe that valuable market
rule changes that could reduce costs should not be unduly delayed.  Accordingly,
the Commission orders NYISO to explore the issues and evaluate the proposals
discussed at the conference, including the MMU’s recommendations, through its
stakeholder process and file an informational report with the Commission by June
1, 2015.14

III. THE EXPLORATION OF ISSUES AND EVALUATION OF PROPOSALS

THROUGH THE STAKEHOLDER PROCESS

A summary of the steps that the NYISO has taken to consider, analyze, and address

several of the issues raised during the Technical Conference, with the MMU and stakeholders follows below.  The stakeholder discussions have illustrated that there are disparate stakeholder interests and concerns.  Further consideration through the stakeholder process would allow the NYISO and stakeholders to better assess the benefits and detriments of changes, how those changes might affect other NYISO market initiatives.





12 Id. at 3-4.

13 Id. at 5.

14 Order on Technical Conference at P 23.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 6



Prior to the issuance of the November Order, based on consideration and input from the MMU and its stakeholders, the NYISO had already made it a priority to conduct three discrete
projects in 2014 in order to address issues raised at the Technical Conference.  The NYISO
committed to lead further stakeholder discussions regarding (i) market design concepts regarding whether and how to model export constraints in the ICAP Spot Market Auction, (ii) market
design concepts regarding the elimination Localities, and (iii) market design concepts that would lead to pre-defined capacity zones.15

(i)Eliminating Localities



On October 30, 2014, the NYISO presented to and discussed with stakeholders at a joint meeting of its Market Issues Working Group and its ICAP Working Group, whether there is a need for, and potential issues associated with, the concept of eliminating Localities.  The NYISO presented background information on why locational capacity is valued in some areas.16  It also discussed some of the challenges and concerns that would arise and need to be addressed in
association with designing a rule set to eliminate a Locality.

Stakeholders expressed disparate views on the concept.  End user interests and some

transmission owners recommended that the NYISO consider a change to the current NCZ Study;
i.e., the process, methodology, and parameters used to evaluate the need for a New Capacity
Zone.  Their suggestions included having the NYISO monitor the binding interface that gave rise
to the creation of a Locality in order to identify when it was no longer binding.  They also argued
that because the NCZ Study, which examines Deliverability, would identify the need for an NCZ
if one MW is constrained at an interface, there should be a rule that the Locality should be
eliminated when the constraint at the interface is relieved by one MW or more.  The NYISO
evaluated that proposal and informed stakeholders that it would create the potential for turning
the Locality “on” and “off” thereby creating significant market uncertainty.  That uncertainty
includes issues surrounding projects subject to a buyer-side mitigation Offer Floor, the effect on
sales in the Capability Period Auction and Monthly Auction, and price signals to developers and
investors of proposed, under-development, and existing capacity resources.  Several stakeholders
agreed with the NYISO’s assessment.  There was also discussion of a need to limit the frequency
and add predictability to a design to eliminate Localities, and potential opportunity to ensure an
accurate price signal.

Based on the stakeholder discussions and analysis, and potential opportunity to ensure an
accurate price signal, to advance consideration of eliminating Localities, the NYISO proposed
that a rule should provide that the Locality be eliminated if the binding interface is relieved with
sufficient Deliverability Headroom such that it would not be expected to bind again (at least for
some foreseeable length of time, which would need to be determined) once the Locality was



15 NYISO, 2014 Business Plan Highlights  pp , 8, and 9, available at:

<http://www.nyiso.com/public/webdocs/company/strategic_plan/2014_nyiso_businessplanhighlights_fina
l.pdf>

16 See Attachment I.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 7





eliminated.  The NYISO also suggested that price convergence might be a preferable trigger for eliminating Localities.

In response, some stakeholders indicated a preference for pursuing eliminating Localities
as opposed to defining under what circumstances price separation should cease.  Stakeholders
from the supply sectors indicated more effort should be focused on whether there was even a
need to eliminate Localities and if doing so would jeopardize reliability.  Other stakeholders
rejected that suggestion and argued that because only a Deliverability criterion is used to identify
the need for an NCZ, the same criterion should be applied to identifying when to eliminate
Localities.  Some representatives of capacity suppliers expressed their continued support for the
concept of pre-defining capacity zones.  It was clear from the responses that a large number of
stakeholders that provided input thought that the current Deliverability construct for creating
NCZs possibly should include an additional criterion, and should be re-evaluated as part of the
discussion on rules to eliminate Localities.

(ii) Eliminating Localities and Pre-Defining Capacity Zones



After further analysis and consideration of stakeholder input, at a November 17, 2014

ICAP Working Group meeting the NYISO presented further information and led a discussion of potential market design concepts for pre-defining and eliminating Localities.17  The NYISO
presented some information regarding PJM Interconnection LLC (“PJM”) rules for predefining and eliminating its capacity zones; and discussed possible options for the NYISO.  The NYISO and stakeholders also reviewed and discussed potential bulk system or market triggers for
eliminating Localities, and issues that would arise if they are eliminated, including how they
might be compounded or lessened depending on the frequency of the elimination determinations. Many of the issues previously raised by stakeholders, at the Technical Conference and at the October 30 ICAP Working Group meeting were further discussed.

Load interests indicated that in the near-term, price convergence should not be considered
as the criterion for eliminating a Locality because with the current market structure, it is unlikely
to occur.  They suggested that the existing market structure be retained and that the trigger for
eliminating Localities be an appropriate amount of Highway interface Headroom with a buffer
(to be defined.)  They further suggested that such a criterion for elimination would need to be
balanced with a similar creation rule, and that the rule would also need to consider and balance
reliability and higher costs.

Some suppliers commented that satisfying the Deliverability constraints may not ensure
reliability in a Locality that has load pockets, or where there is significant uncertainty of capacity
remaining in service.  They cautioned that the magnitude of headroom used as the criteria to
eliminate a Locality be sufficiently large to ensure reliability.  Similarly, they suggested that the
NYISO should apply that same parameter when creating new Localities in order to avoid
reliability problems caused by unexpected loss of capacity.  Price convergence was again



17 See Attachment II.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 8





suggested as an alternative, including using price convergence as the criteria to trigger

eliminating Localities.  The NYISO was asked to consider a rule to achieve price convergence by shifting the zero crossing point on the ICAP Demand Curve.  A representative of load interests expressed disagreement with that proposal.

It was apparent to the NYISO that there was no consensus on the concepts surrounding
rules to eliminate and create Localities.  This discussion was also part of the NYISO Budget
Priorities Working Group, where stakeholders expressed disagreement between whether the
project to discuss rules to eliminate capacity zones should be separate or combined with a project
to discuss concepts surrounding pre-defining capacity zones.  As discussed below, the Budget
Priorities Working Group process did keep these two projects separated.  Based on stakeholder
input received through that process, the NYISO prioritized a project for 2015 reviewing concepts
for eliminating Localities.

(iii) Load Zone K Export Constrained Capacity



At the joint meeting of the Market Issues Working Group and the ICAP Working Group
on December 18, 2014 the NYISO led a discussion for a market design concept to model the
excess capacity that cleared in the Load Zone K ICAP Spot Market Auction as part of the supply
stack in the G-J Locality ICAP Spot Market Auction, up to the level of the export constraint.18
The NYISO provided background on the existing ICAP auction pricing hierarchy rules and
mechanics.  The proposed market design concept was based on the concept the NYISO had
introduced at the Technical Conference.  Under the proposed concept, the NYISO would solve
the ICAP Spot Market Auction as it does today, with one change.  That is, the NYISO would (a)
count the MW that clear above the Load Zone K LCR,19 up to the Load Zone K export limit
MW, toward the G-J LCR and (b) count the remaining MW in Load Zone K that clear above the
Load Zone K LCR (i.e. those above the export limit) toward the NYCA Minimum Unforced
Capacity Requirement (“NYCA Minimum Requirement”).  This approach would recognize the
reliability value to the G-J Locality of excess MW of capacity in Load Zone K above the LCR
target, up to the Load Zone K export limit.  It would also lower the total cost of capacity.  This
approach could reduce costs to loads in the G-J Locality without raising costs to loads in Load
Zone K.  Because of its relative simplicity compared to other concepts proposed at the Technical
Conference, the NYISO suggested at this stakeholder meeting that it potentially could be
implemented prior to the next ICAP Demand Curve reset.20







18 See Attachment III.

19 LCR in this context refers to the Locational Minimum Unforced Capacity Requirement.  That amount is derived from the Locational Minimum Installed Capacity Requirement.  For simplicity in this Report, the NYISO is referring to both as the “LCR.”

20 That timing would depend on the timing of when the proposal became an established rule in
relation to when the ICAP Demand Curve reset independent consultant had an opportunity to consider
fully the implications in its report.  It also would depend on whether necessary software revisions could






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 9





Stakeholders expressed little support for this concept.  Some stakeholders representing suppliers raised questions regarding the application of buyer-side capacity market mitigation
rules, and were skeptical that the market design concept could be confined to modifying only the auction rules without modifying the NYISO’s process for setting LCRs.  They also commented that NYISO’s proposal would not provide proper price signals for capacity to locate in Long
Island.  Representatives of load interests were interested in discussing issues further so they
could better evaluate the proposal, and also whether excess capacity in Load Zone K should also be recognized in all Load Zones with which it has ties.

In response to requests from stakeholders, the NYISO posted on its website a detailed
numerical example to further illustrate the Load Zone K export concept it had presented at the
December 18 stakeholder meeting.21  The example shows how the ICAP Spot Market Auction
would clear under the proposal.  The NYISO presented the proposal at the February 24, 2015
meeting of the ICAP Working Group.  Stakeholders were afforded the opportunity to discuss the
example in detail, and to raise any questions regarding it and the related market design concept
proposal.  No stakeholder expressed an interest in the NYISO doing either.  Therefore, the

NYISO did not pursue the discussion.  Since the posting of the numerical examples, some load interests have indicated that they would like to see this discussion brought back to the
stakeholder process for further review and evaluation.  The NYISO will be considering with its stakeholders whether to prioritize that project in the NYISO’s 2016 business plan.

(iv) The MMU’s Locational Capacity Framework



The MMU’s 2013 Annual State of the Market Report 22 included in its list of

recommendations for the NYISO certain capacity market enhancements.  The MMU further

recommended that the NYISO “create a dynamic and efficient framework for reflecting

locational planning requirements, including three key aspects: a) Pre-define interfaces/zones that
address potential resource adequacy needs and highway deliverability constraints to allow prices
to accurately reflect the locational value of capacity; b) Grant internal capacity deliverability
rights between zones when private investors upgrade transmission into a local area; c) Modify
demand curve reset methodology to minimize the cost of satisfying planning requirements.”23
These recommendations built on the MMU’s comments at the February Technical Conference.







be deployed in time for the start of the Capability Year to which new ICAP Demand Curves would apply (May 1, 2017).

21 See Attachment IV.

22 Potomac Economics, Ltd., 2013 State of the Market Report for the New York ISO Markets (May 2014) (“2013 State of the Market Report”), available at:

˂http://www.nyiso.com/public/webdocs/markets_operations/documents/Studies_and_Reports/Reports/M
arket_Monitoring_Unit_Reports/2013/2013%20State%20of%20the%20Market%20Report.pdf˃.

23 See Attachment V.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 10



When the MMU initially discussed its 2013 State of the Market Report recommendations,
stakeholders requested that the MMU further discuss this capacity market framework at a
separate ICAP Working Group meeting due to its complexity.  At two separate ICAP Working
Group meetings, on August 20, 2014 and November 14, 2014, the MMU led two lengthy
discussions of these recommendations. The MMU discussed its recommendation to enhance
locational pricing and described its view on elements of an enhanced framework that could
dynamically recognize the reliability value of capacity in Load Zone K in the G-J Locality ICAP
Demand Curve.

While the MMU’s presentation was apparently met with interest by the meeting

participants, several also indicated that the MMU proposal would likely require a complete
reworking of the NYISO’s capacity market and potentially impact the policies and rules
administered by the New York State Reliability Council.  Stakeholders asked that the MMU
develop and present a cost-benefit analysis that would illustrate a savings to consumers.  Other
stakeholders noted that this proposal would not follow the current LCR setting process and could
result in some Localities procuring capacity at levels below the minimum requirements.  Some
stakeholders expressed concern regarding how this market design concept would support and
ensure reliability.  While there certainly was some interest in the MMU’s market concept,
stakeholders participating in the meeting expressed that further evaluating it would be a
significant long term undertaking that would be unlikely to be completed prior to the next ICAP
Demand Curve reset.

The MMU’s 2014 State of the Market Report included recommendations that effectively repeated the recommendation to adopt a locational framework, but the recommendations in the 2014 report modified the recommendations in the 2013 State of the Market Report based on feedback from stakeholders.24  Specifically, the recommendation was modified to ensure
Localities would not under-procure capacity.  The 2014 State of the Market Report provided additional information on potential benefits, but the MMU has indicated it will work with the NYISO’s Planning Department to provide additional information.

The NYISO reviewed the proposal and has taken the position, which is similar to several comments stakeholders proffered, that the MMU’s presented framework, in general, would
require significant changes to the current capacity market, be complicated to define, and
challenging to administer.











24 Potomac Economics, Ltd., 2014 State of the Market Report for the New York ISO Markets

(May 2015) (“2014 State of the Market Report”) at pp. x - ix, 100 - 101, available at:

˂http://www.nyiso.com/public/webdocs/markets_operations/documents/Studies_and_Reports/Reports/M
arket_Monitoring_Unit_Reports/2014/NYISO2014SOMReport__5-13-2015_Final.pdf˃ at pp. xi, 64-65,
102.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 11





(v)Further Consideration of Pre-Defining, Eliminating, and Export

Constrained Concepts



The NYISO’s discussion with it stakeholders of the topics of pre-defining and

eliminating Localities, and export constrained capacity market design concepts also took place in its annual “project prioritization” process.  This is the stakeholder process through which, among other things, the NYISO obtains stakeholder input as it establishes what proposals it will bring to the stakeholders as a market design concept proposal for discussion, or a market design approval project to be taken through the governance process for a stakeholder vote.  The NYISO
suggested that several issues raised by stakeholders at the Technical Conference and by post-
conference comments, be evaluated in 2015.  The potential list included the MMU’s capacity
market framework recommendation described above, modeling export constraints in the ICAP
Spot Market Auction for nested capacity zones, and developing market rules to pre-define
capacity zones combined with rules to eliminate them.

As part of the project prioritization process, based on input from stakeholders,

consideration of rules to eliminate Localities was separated from consideration of developing market rules to pre-define capacity zones.  Based on further stakeholder input, the NYISO
committed to consider rules for the elimination of Localities or for the achievement of capacity price convergence.  The NYISO is currently developing its follow up discussion on this market design concept, which will be based in part on its consideration of stakeholder input to date.  It will be presenting and discussing this concept to stakeholders.

At the February 24, 2015 ICAP Working Group meeting, the NYISO highlighted for
stakeholders key issues that had been raised during the Technical Conference and in post-
conference filed comments.25  The NYISO offered stakeholders an opportunity to make
presentations at a future ICAP Working Group meeting on export constrained modeling
concepts, with the objectives of defining the preferred approach and alternatives, presenting
numerical examples, and describing the benefits and detriments.26  No party requested an
opportunity to make a presentation or lead a discussion, and no party provided materials.

(vi) Consideration of LCR Setting Methodology



In relation to discussions regarding the November Order, and based on discussions with
the stakeholder Operating Committee, the NYISO initiated a process to identify and evaluate
alternatives to the current LCR setting process.  The NYISO conducts this process after the New
York State Reliability Council sets the NYCA Installed Reserve Margin (“IRM”).  Mark
Younger of Hudson Energy Economics made a presentation to a joint meeting of Market Issues
Working Group, ICAP Working Group, and Price Responsive Load Working Group, on the



25 See Attachment VI.

26 See id. at Slide 8.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 12





“IRM/LCR Process & Dynamics.”27  Mr. Younger described factors that could affect the LCRs, and proposed an analysis of the current methodology, using certain sensitivities.

The NYISO notified stakeholders and the MMU that the LCR Task Force was being

convened and asked them to participate.  On March 5, 2015, the LCR Task Force met.  In order
to facilitate the NYISO’s and its stakeholders’ consideration of a potential alternative process to
calculate LCRs, the NYISO presented background material so that all stakeholders had a
common understanding of the current process by which the LCRs and the IRM were set.  It also
enumerated some concerns previously raised by stakeholders regarding the LCRs, and proposed
next steps for the LCR Task Force to consider alternatives.28  In the meeting, the NYISO,
stakeholders, and the MMU discussed the process to calculate the LCRs and the process by
which it will consider and analyze alternatives.  The NYISO responded to numerous questions.

The LCR Task Force met again on April 8, 2015.  At this meeting, the NYISO presented and described objectives of the current LCR setting methodology and possible alternatives.29  It solicited stakeholder input to develop a consensus on an objective for the group to focus on when evaluating candidate alternative methodologies to determination the LCRs.  The following
objectives were discussed:

  Maintain the existing process

  Minimize the NYCA-wide capacity procurement costs   Minimize the NYCA-wide MW requirement

  Lowest Possible G-J LCR: Retain J and K “as found” and determine the minimum G-J

No consensus on the objective was reached at the meeting.  Rather, stakeholders suggested

that the NYISO perform studies to demonstrate how the results will differ based on the objective. The NYISO indicated such an approach would require extensive use of resources and should only be undertaken until (and unless) clearer objectives were defined.

IV. THE NYISO’S CONCLUSION AND RECOMMENDED NEXT STEPS

Based on the NYISO’s exploration of the issues and evaluation of the proposals

discussed at the February Technical Conference, including the MMU’s recommendations,

through its stakeholder process, the NYISO has concluded that its existing rules are working and
that incremental enhancements may well be beneficial.  It has also concluded that its stakeholder
process and project prioritization process is best suited to continue to explore enhancements to its





27 See Attachment VII.

28 See Attachment VIII.

29 See Attachment IX.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 13





existing market rules.  Due to the complexity, a measured approach to identify and define the enhancements, and address implications is appropriate.

The Services Tariff process for identifying the need for an NCZ, obtaining stakeholder
input throughout the process, filing with the Commission proposed rules to implement it, and
then developing an ICAP Demand Curve for the NCZ along with the other ICAP Demand
Curves, was utilized for the first time, in 2013.  It resulted in the creation of the G-J Locality.  In
accordance with that Services Tariff process, by October 1, 2015 the NYISO will have initiated
the NCZ Study process and have obtained stakeholder input for the NCZ Study to be issued by
January 15, 2016.30  As the NYISO stated at the Joint Technical Conference on New York
Markets & Infrastructure in November 2014, “[t]he NYISO is mindful of the fact that the
creation of the new zone has led to wholesale capacity price increases that have had retail price
implications.  But the NYISO believes that the creation of the new zone was necessary, fully
consistent with tariff requirements, and will benefit all New York consumers over time.  Needed
investments in resources in the lower Hudson Valley are now being made that will bolster long-
term reliability and lower capacity prices in the region as they enter service.”31  The
Danskammer Generating Station announced its return to service and the Bowline Unit 2 has
entered Class Year 2015 as a step towards returning it to its full capacity, and the 720 MW CPV
Valley Energy Center is proceeding with development.32  These projects will enhance reliability,
which will benefit all consumers.

The process for identifying the need for an NCZ is very transparent; it gives stakeholders and all Market Participants and potential developers advanced notice of the changes in the
market place, and then sends price signals that also have been carefully set in the Demand Curve process.  The NYISO recognizes that some incremental adjustments could provide further
benefits and have the potential for reducing costs.  However, it also believes that care must be
taken to develop those rules carefully so that the benefits of the tariff-established process to
create new Localities are not compromised, and that uncertainty surrounding the rules does not
chill potential economic investment.

The NYISO is beginning the project prioritization process with its stakeholders for 2016. As described below, the issues the NYISO is suggesting that stakeholder consider includes issues raised at the February Technical Conference:







30 See Services Tariff Sections 5.16.1.2 and 5.16.

31 Written Statement of Emilie Nelson, Vice President - Market Operations, on Behalf of the New York Independent System Operator, Inc., Docket No. AD14-18-000 (Nov. 3, 2014) at 18.

32 On May 28, 2015, CPV announced that it “expects to commence construction [on the project]
in late 2015.  See Competitive Power Ventures Closes Investment Transaction with Global Infrastructure
Partners (May 28, 2015), available at: ˂http://www.cpv.com/press_releases.html#web˃˃.  The
Interconnection Agreement for the project is fully executed.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 14



  Alternative methods for calculating the LCRs:  This project would consider alternative
methods for calculating the LCRs for each Locality. The project would include a
continuation of the on-going work of the LCR Task Force.



  Modify the ICAP Demand Curve framework to minimize costs of satisfying LCRs:  This
project would create a dynamic and efficient framework for incenting the lowest cost
solutions when setting and meeting locational planning requirements in the capacity
market.  The MMU has proposed this concept indicating it might enable the capacity
market to better provide locational signals in the future and result in more efficient
market outcomes.



  Locational Planning Requirements - Pre-define Localities:   This project would consider
rules for reflecting locational planning requirements in the capacity market to better
enable the market to provide locational signals in the future by predefining a set of
interfaces or zones that address potential resource adequacy needs and highway
deliverability constraints.



  Develop rules for eliminating Localities or achieving price convergence:  This effort

would build on discussions to date and evaluate whether a mechanism to eliminate

Localities is necessary.  If it is deemed necessary, then further evaluate the market design concepts for developing the market rules to allow for the elimination of Localities or achieve price convergence when the deliverability constraint(s) that caused its creation is effectively removed such that the constraint can no longer be expected to bind.



  Model Zone K as export constrained:  This effort would also build upon and enhance
initial design concepts developed with stakeholders.



Over the coming months, the NYISO’s stakeholders will be “scoring” the proposed

projects, which will result in a ranking that the NYISO utilizes to prioritize which projects

stakeholders believe warrant consideration above other projects.  The NYISO believes that this






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 15





input is important to assessing where the greatest benefits to the market can reasonably be achieved.33



In any case, the NYISO will be continuing the LCR Task Force.  As described above,

however, that work must consider potential implications for the New York State Reliability

Council rules that are utilized to set the IRM, and how the process for determining the LCRs can best complement those rules.  It is also possible that the NYISO may have to engage the New York State Reliability Council to consider revisions to the processes or rules for setting the IRM as part of the approach for considering changes in methods for determining LCRs.



Timing of consideration is also important.  The NYISO has already informed

stakeholders that as part of the Demand Curve reset process it is now initiating, it plans on

requesting proposals to consider a 4 or 5 year periodicity in addition to the current 3-year

process, and approaches to enhance the projection of the likely Energy and Ancillary Services
revenues of the proxy plant used for setting the curves.  With the input from the independent
Demand Curve reset consultant, the NYISO plans on evaluating with stakeholders potential rule
changes that could enhance price signals.  This evaluation and any proposal would also consider
revisions to the NCZ Study and the process and timing for the creation of new Localities.  The
NYISO believes that there are benefits to the entire system that are appropriate to pursue at this
time and could be achieved in time for the setting of the next ICAP Demand Curves.

The NYISO sought and considered, and continues to seek and consider, the input of the MMU as it evaluates and develops proposals and market design concepts that are described in this report and works with stakeholders to identify projects to consider in 2016.  The MMU was given an opportunity to review and comment on this report.

Because the NYISO and its stakeholders have undertaken steps to consider important

issues including rules that could enhance price signals, the stakeholder process should be allowed
to continue to work.  The analysis and prioritization in the stakeholder process is perhaps the best
indicator of where value may be achieved for the market.  Accordingly, the NYISO respectfully
requests that the Commission not issue a further compliance obligation to pursue development of
specific rules.



33 Also on the potential 2016 projects for stakeholders to consider is the MMU’s proposal, which
the MMU proposes for “scoping” in the 2014 State of the Market Report and during the February
Technical Conference:  internal capacity Deliverability rights for transmission upgrades into a local area.

See Post Technical Conference Comments of Potomac Economics, Ltd., New York ISO Market

Monitoring Unit, Docket No. AD14-6-000 (March 26, 2014) at 11; see also, 2014 State of the Market Report at xi, 64-65, 102.  The MMU has suggested considering creating a dynamic and efficient
framework for reflecting locational planning requirements in the capacity market to better enable the
market to provide locational signals in the future, by granting internal capacity deliverability rights for AC Transmission between zones when AC transmission is upgraded into a local area.  The State of the Market report has not indicated this as a priority item.  At this stage, the NYISO believes it would require further information in order to assess its potential.






Hon. Kimberly D. Bose, Secretary June 1, 2015

Page 16





V.SERVICE

This filing will be posted on the NYISO’s website at www.nyiso.com.  In addition, the
NYISO will e-mail an electronic link to this filing to the official representative of each party to
this proceeding, to each of its customers, to each participant on its stakeholder committees, to the
New York Public Service Commission, and to the New Jersey Board of Public Utilities.

VI.CONCLUSION

Wherefore, for the foregoing reasons, the New York Independent System Operator, Inc. respectfully requests that the Commission accept this Informational Report.





Respectfully submitted,

/s/ Gloria Kavanah

Gloria Kavanah
Counsel for the

New York Independent System Operator, Inc.



cc:Michael Bardee

Gregory Berson
Anna Cochrane
Morris Margolis
David Morenoff
Daniel Nowak
Kathleen Schnorf
Jamie Simler

Kevin Siqveland






























ATTACHMENT 1








Capacity Zone
(Locality)

Elimination









Mariann Wilczek

Capacity Market Products

New York Independent System Operator

Joint MIWG/ICAP Working Group

October 30, 2014

NYISO, Rensselaer, NY











© 2014 New York Independent System Operator, Inc.  All Rights Reserved.








Problem Statement

Discuss whether there should be a mechanism to
eliminate a Locality, and if so, market design
concepts to eliminate capacity zones

  The Services Tariff uses the term “Locality” to define
established capacity zones





The purpose of this presentation is to solicit
stakeholder feedback

























© 2014 New York Independent System Operator, Inc.  All Rights Reserved.2








Why do we have Capacity Markets ?

  Benefits





Ensure resource adequacy

Provide a market signal for investment

Recover a portion of fixed costs not recoverable in Energy and Ancillary Services Markets


  Capacity zones (“Localities”) recognize the value of capacity in the
area.

   More focused price signal where capacity is needed    Help to address transmission system constraints    Long term investment signal

  New - Locate

  Existing - Maintain or increase capability



















© 2014 New York Independent System Operator, Inc.  All Rights Reserved.3








Localities

The Services Tariff has the set of rules for the

triennial process to determine if a new Locality is
needed and the steps by which it is created (see
Appendix Slides)

The tariff is silent on the elimination of a Locality











































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.4








Stakeholder Discussion

Do we need to eliminate Capacity Zones ?

  G-J, J, K

Suggested Topics

  Elimination of a Locality

  Price convergence

  Elimination of a deliverability constraint

  Effect on Offer Floor of units subject to buyer-side mitigation

  Effect on planning processes

  Timing issues

Comments beyond today’s meeting can be sent to
Debbie Eckels (deckels@nyiso.com)



















© 2014 New York Independent System Operator, Inc.  All Rights Reserved.5




































































































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.6








Background for New Capacity Zones

FERC Filings and Orders

June 30, 2009 - FERC Order accepting the deliverability rules directed the NYISO and the NYTOs to

jointly file a proposal to create a new capacity zone.

January 4, 2011 - NYTOs and NYISO filed proposed criteria and considerations to govern the

evaluation and potential creation of new capacity zones.

September 8, 2011 - FERC issued an order which directed the NYISO to file tariff provisions to

specify the process for evaluating, identifying and, if necessary, establishing new capacity zones.

November 7, 2011 - NYISO filed the tariff sheets containing the specific detail.

August 30, 2012 - FERC issued an order accepting the November 2011 filing and made the tariff

revisions by which new capacity zones would be identified and created effective as of January 9,

2012.

June 29, 2012 - NYISO submitted a filing proposing buyer-side and supplier-side ICAP market power

mitigation rules to apply to any newly created capacity zones.

June 6, 2013 - FERC issued an order conditionally accepting the proposed mitigation rules, subject

to a compliance filing.

July 8, 2013 - NYISO filed in compliance with the June 2012 order.

August 23, 2014 - FERC issued a delegated letter order accepting the July 8, 2013 compliance filing.

















© 2014 New York Independent System Operator, Inc.  All Rights Reserved.7








Process to Define New Capacity Zones

Rules

The Services Tariff Section 5.16 describes the required steps to identify and propose a New Capacity Zone

(NCZ)   and Section 5.14 describes how an NCZ is factored into the triennial ICAP Demand Curve reset

process.

The NYISO is required to

Commence a triennial NCZ Study in the calendar year preceding the calendar year in which the NYISO is required to file the

ICAP Demand Curves (ICAP Demand Curve Reset Filing Year).

Review with the stakeholders by October 1 of that preceding year the inputs and the assumptions to be used in the NCZ Study.

Complete the NCZ Study by January 15 of the ICAP Demand Curve Reset Filing Year.

Filings

The Services Tariff requires the NYISO to make one of two types of filings on or before March 31 of each ICAP

Demand Curve Reset Filing Year.

“[i]f the NCZ Study does not identify a constrained Highway interface, the ISO shall file with the Commission the

ISO’s determination that the NCZ Study did not indicate that any New Capacity Zone is required pursuant to this process, along with a report of the results of the NCZ Study.”

Propose a New Capacity Zone if the NCZ Study identifies a constrained Highway interface into one of more Load

Zones, including identify the boundary of one or more NCZs and file tariff revisions to implement new NCZ(s) along with the NCZ Study results.

Process Timing

The steps were designed so that the NYISO’s filing to propose an NCZ would be made in time for it to be

considered as part of and concurrent with the periodic review of the ICAP Demand Curves for existing

Localities and the NYCA,

Pursuant to the timing in the Services Tariff, the ICAP Demand Curves for an NCZ would be effective at the

same time other revised ICAP Demand Curves; and in time for all ICAP market activities (e.g. setting the

LCRs, import rights processes) for the first Capability Year after it is proposed and accepted.)







© 2014 New York Independent System Operator, Inc.  All Rights Reserved.8






























ATTACHMENT 2










Capacity Zone
(Locality)

Predefine & Eliminate







Mariann Wilczek

Capacity Market Products

New York Independent System Operator

ICAP Working Group

November 17, 2014

NYISO, Rensselaer, NY













© 2014 New York Independent System Operator, Inc.  All Rights Reserved.








Objectives

Discuss whether capacity zones should be

predefined and, if so, market design concepts to
predefine capacity zones

Continue discussion whether capacity zones should
be eliminated and, if so, market design concepts to
eliminate capacity zones







































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.2








Request from October 30 MIWG

Stakeholders requested a presentation on how PJM
and ISO-NE eliminate capacity zones

   Stakeholders recognized that this request was in the context of markets
that had different capacity zone constructs

The following slides provide a brief overview of how
PJM predefines and eliminates capacity zones

   ISO-NE will be presented at a future ICAP Working Group meeting



































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.3








PJM -  Locational Deliverability Area

Locational Deliverability Area (LDA) - Reliability Assurance Agreement

Sub regions used to evaluate locational constraints. LDAs include EDC zones, sub-zones and

combination of zones. A Zone is an area within the PJM Region or such areas that may be

combined as a result of mergers and acquisitions; or added as a result of the expansion of the

boundaries of  the PJM Region. A Zone will include any Non-Zone Network Load located outside the PJM Region that is served from inside a particular Zone.

Limited ability to import capacity due to physical limitations of the transmission system, voltage

limitations or stability limitations.

There are currently 27 LDAs.

PJM will analyze the need for an addition of an LDA - Manual 14b

RTEP Market Efficiency Analysis - constrained facilities will be identified(persistent congestion on

a 500kV or above facility or interface) for multiple years beyond the next Base Residual Auction

RTEP Long Term Planning - Future constrained facilities or clusters of facilities are identified

utilizing the long term planning analysis. Potential facilities are screened using thresholds that are utilized in the RTEP long-term planning studies. This analysis is updated annually based on
approved RTEP upgrades. 500 kV and above facilities that advance more than three years between RTEP cycles are identified for further consideration. If the driver for a 500 kV facility advancing
more than three years is linked to a specific event (e.g. significant generation retirement), it may
require further analysis.

Once a facility has been identified utilizing the above methods, distribution factor analysis is

utilized to determine the specific busses included in the analyzed LDA.

The sequence of evaluating areas of differing size involves nesting small sub-areas into larger

areas and finally areas into larger geographical areas of Locational Deliverability Area (LDA).

Any other party may propose to PJM a new LDA and they will study

PJM required to file with FERC if a new LDA (or aggregate of LDAs) is warranted



Sources - PJM Schedule 10.1 of Reliability Assurance Agreement, PJM Manuals 14b PJM Region Transmission Planning Process, Manual 20 - PJM

Resource Adequacy Analysis, Manual 18 - PJM Capacity Market, Manual 35 - PJM Definitions

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.4








PJM - Load Deliverability Study (CETO/CETL)
Manual 18 - PJM Capacity Market



The process of determining the Installed Reserve Margin (IRM) that meets the PJM reliability criterion

assumes that the internal RTO transmission is adequate and any generation can be delivered to any
load without transmission constraints. This process helps in determining the minimum possible IRM
for the RTO. However, since transmission may have limitations, after IRM is determined a Load
Deliverability analysis is conducted. The RTO is divided into different sub-regions for this analysis.
These sub-regions are referred to as Locational Deliverability Areas (LDAs) in the Reliability Pricing
Model.

The first step in the Load Deliverability analysis is to determine the transmission import capability

required for each LDA to meet the area reliability criterion of Loss of Load Expectation of one

occurrence in 25 years. This import capability requirement is called Capacity Emergency Transfer

Objective (CETO), expressed in megawatts and valued as unforced capacity. The standard generation reliability evaluation model is used to determine CETO.

The second step in Load Deliverability analysis is to determine the transmission import capability

limit for each LDA using the transmission analysis models. For this analysis, a Transmission Upgrade
including transmission facilities at voltages of 500 kV or higher that is in an approved Regional
Transmission Expansion Plan (“Backbone Transmission”) will be included in the system model only
if it satisfies the project development milestones set forth in the tariff. This import capability limit is
called Capacity Emergency Transfer Limit (CETL), expressed in megawatts and valued as unforced
capacity.

If CETL value is less than CETO value, transmission upgrades are planned under the Regional

Transmission Expansion Planning Process (RTEPP). However, higher than anticipated load growth and unanticipated retirements may result in the CETL value being less than CETO value with no lead time to build transmission upgrades to increase CETL value. These conditions could result in
locational constraints in the RTO.



Sources - PJM Schedule 10.1 of Reliability Assurance Agreement, PJM Manuals 14b PJM Region Transmission Planning Process, Manual 20


- PJM Resource Adequacy Analysis, Manual 18 - PJM Capacity Market, Manual 35 - PJM Definitions

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.


5








PJM - Locational Constraints



Locational Constraints are localized intra-PJM capacity import capability limitations (low CETL

margin over CETO) that are caused by transmission facility limitations or voltage limitations that are identified for a Delivery Year in the PJM Regional Transmission Expansion Planning Process (RTEPP) prior to each Base Residual Auction. Such locational constraints are included in the RPM to
recognize and to quantify the locational value of capacity within the PJM region.



An LDA is modeled if:

LDA has CETL < 1.15 CETO

LDA had locational price adder in any of three immediately preceding Base Residual Auctions

LDA is likely to have a locational price adder based on a PJM analysis using historic offer price

levels

LDA is EMAAC, SWMAAC, and MAAC

An LDA that does not meet the criteria above may be modeled if PJM identifies reliability

concerns with LDA

LDAs modeled in a Base Residual Auction are modeled in the Incremental Auctions for the

Delivery Year

A Reliability Requirement and a Variable Resource Requirement Curve will be established for each

constrained LDA to be modeled in the RPM Base Residual Auction.

Capacity Import Limits

First modeled in 2017/2018 year that will limit the delivery of capacity from external source

zones



Sources - PJM Schedule 10.1 of Reliability Assurance Agreement, PJM Manuals 14b PJM Region Transmission Planning Process, Manual 20

- PJM Resource Adequacy Analysis, Manual 18 - PJM Capacity Market, Manual 35 - PJM Definitions







© 2014 New York Independent System Operator, Inc.  All Rights Reserved.6








PJM - LDAs



   Mitigation



   VRR Curves



   Locational Requirements























































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.7








NYISO - Predefine Possible Options

  Pursue an incremental approach first

  Based on the tariff’s current deliverability construct

  Look at what constraints are likely to bind or where  there are likely to be
export constrained zones

  The MMU has proposed a dynamic process  - Discussion  at
August 20, 2014 and November 14 ICAP WG meetings

  Complicated to define

  Complicated to administer

  Requires significant changes to the current capacity market   PJM approach





























© 2014 New York Independent System Operator, Inc.  All Rights Reserved.8








NYISO - Eliminate Possible Options

  Actual or projected price convergence with the NYCA
clearing price

  Deliverability Constraints are Eliminated

  No need to eliminate as prices will converge or nearly
converge

















































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.9






Potential Triggers for Elimination
of a Capacity Zone

Actual or projected price convergence with the NYCA clearing price

   What period of time - past or future or both

  How many months, consecutive ?

  Studies performed that the prices converge in a period in the future ?

  Does the IRM/LCR setting process impact the convergence ?    Upcoming Market Events

Transmission builds and enhancements - how far ahead, base case
inclusion rules

Resource retirements/additions

  What is retiring/being added ?  When ?

  Should Mothballs and ICAP Ineligible be considered ?

How to look forward without Demand Curves for those periods    How to look at Price Convergence

Planning Studies

  Deliverability study, IRM/LCR study, a combination of planning studies or other study ?

  How far out is the study horizon ?











© 2014 New York Independent System Operator, Inc.  All Rights Reserved.10








Triggers for Zone Elimination (cont)



  Deliverability Constraints are Eliminated

   What MW threshold is required to cause elimination

  Incremental MW of interface deliverability capability have been added to

eliminate all likelihood that the interface will become constrained within the horizon period ?

  Compare amount of incremental interface capability to what ?

  What about Generator retirements/additions?

   Planning Horizon

  What is the time required to show the deliverability constraint has been
adequately relieved ?

5 years ? 10 years ? Other ?

  Baseline , inclusion rules ?

  Scenarios


















































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.




























11








Alternative Position

  No need to eliminate as prices will converge or nearly
converge

  Other analysis to support

  Changes to the IRM/LCR processes and/or DCR   Export constrained zone




















































































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.
















































12








Potential Issues to Elimination

  Mitigated Units (buyer-side and supplier-side)

  Buyer -side (BSM)

If a mitigated unit is no longer in a mitigated zone is it no longer
subject to an Offer Floor ?

What if the eliminated zone becomes a mitigated capacity zone in
the future ?

New units could enter the newly eliminated zone  and not be
mitigated and others still mitigated

Continuation of BSM without the associated Locality creates a
disconnect and unlikely the mitigated unit will come out of
mitigation

  Supplier-side (Pivotal Supplier)

Are business decisions affected by the uncertainty of whether or
not this might apply




























© 2014 New York Independent System Operator, Inc.  All Rights Reserved.














13








Potential Issues to Elimination (con’t)

  CY deliverability study , impacts to SDU cost allocations,
built or not built

  Import Rights analysis   Tariff rule changes   Software issues














































































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.












































14








Timing

  When and how frequently is the periodic planning study or
other analyses done?

  Seasonal

  Annual

  With NCZ study in a DCR year

  Should elimination be coupled with examination of other new
zones or a reconfiguration of an existing one

   What time frame does the elimination become effective ?


























































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.
































15








Studies and Analyses Impacted

  Impacts

  What type of impacts
  Consumer impacts    CRP, RNA

  Do market based or backstop solutions impact the elimination
of a zone ?

If so, how ?

  Interconnection, Class Year and Deliverability Studies   MMA BSM determinations linked to CY Studies
  Timing of studies for zone elimination may conflict with
existing studies; e.g.,  DCR and IRM/LCR Studies




































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.


















16








Next Steps

  Elimination

  Provide highlights of ISO-NE

  Continue stakeholder discussions on elimination concepts into
2015


























































































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.




















































17





































































































































































© 2014 New York Independent System Operator, Inc.  All Rights Reserved.






























































































18






























ATTACHMENT 3








Treatment of Zone K Export

Constraints into the G-J

Locality :

Market Design Concept





Randy Wyatt

Capacity Market Products

New York Independent System Operator



MIWG/ICAPWG

December 18, 2014

NYISO, Rensselaer, NY

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.






Background: How did we get here?

  The NYISO Tariff provides for the creation of import
constrained zones (Localities)

  Tariff prescribed triennial process

   New Capacity Zone (NCZ )Study / Highway deliverability constraint test    MST §5.16.2 - “In determining the New Capacity Zone Boundary, the ISO
shall consider the extent to which incremental Capacity in individually

constrained Load Zones could impact the reliability and security of the

other constrained Load Zones, taking into account interface capability between the constrained load zones.”  (emphasis added)

   Other than the above, the tariff is silent on treatment of export constraints
into a Locality

   On April 30, 2013 the NYISO filed with FERC to create a G-J NCZ

  K was not included in the NCZ boundary based on reliability analysis, ( MST
§5.16.2 )

2013 BPWG Process identified MDCP for modeling  export constraints in the

ICAP Auction

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

2




FERC Tech Conference

The purpose of the conference was to discuss
whether or not to model Load Zone K export-

constraints in future Demand Curve reset
proceedings.

NYISO presented transmission security

analysis and resource adequacy analysis

material  that demonstrates a 300 MW export
limit from K to GHI

MMU and stakeholder comments support
valuing K capacity reliability benefits in the
new Locality

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

3


11/25/14 FERC Order

Resulting from the FERC Technical
Conference

FERC’s order

  Directed the NYISO  to work with stakeholders “to explore
whether a proposal can be developed that could reduce

the cost of procuring capacity while meeting the NYISO LOLE objective.”

  Directed the NYISO  to “explore the issues and evaluate
the proposals discussed at the conference, including the

MMU’s recommendations, through its stakeholder

process and file an informational report with the Commission by June 1, 2015.”



“[A]gree[d] with NYISO that it is premature to require it to file tariff language by June 1, 2015.”

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

4




Pricing Hierarchy Rules

  Hierarchy rules link Market-Clearing Price (MCP) outcomes in
the auctions

  If NYC MCP < G-J* MCP, set NYC MCP = G-J* MCP   If G-J MCP < ROS MCP, set G-J MCP = ROS MCP   If LI MCP < ROS MCP, set LI MCP = ROS MCP















Rest of State

* G-J Locality

consists of the Lower


Lower
Hudson

Valley
New York City




Long Island


Hudson Valley

(Zones G-I) and New York City (Zone J)

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

5






Capacity Market Mechanics: Background



  Conduct and solve Spot auctions for all Demand Curve “regions”
(i.e., the 3 Localities and the NYCA), MW that clear above a
Locality’s Locational Minimum Installed Capacity Requirement
(LCR) are automatically “offered” to satisfy LSEs’ additional
minimum requirements as follows

  Zone J MW that clear above requirements are offered in the G-
J Locality.

  Zone K MW and G-J Locality MW that clear above
requirements are offered in NYCA.

  Resale of the MW that cleared above LCRs  offsets the cost to
load in the Locality

  Revenue to ICAP Suppliers in Localities where MW cleared
above requirements is not impacted by the resale

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

6






NYISO’s Proposed Market Design Concept



Originally presented at FERC Tech Conference
NYISO conceptual design elements

  One export constrained zone: Load Zone K   Set up rules to ensure equivalent results to a
simultaneous solution

Determination of a cap on Zone K capacity that could be
used to satisfy the G-J LCR

Model Zone K export caps in the Spot Auction

This cap would stay fixed in the Spot auction

Explore mitigation rules and subsequent settlement rules

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

7


Market Design Concept:

Auction Mechanics for Treatment of
Export Constraints into a Locality

Solve the auction as we do today, apply hierarchal
pricing rules to result in a simultaneous auction
outcome, with an additional step

Offer the MW that clear above the Zone K LCR, up
to the K export limit MW, into the G-J auction at a

zero price

Offer the remaining MW that clear in K above the

Zone K LCR  (i.e., those above the export limit) into
NYCA at a zero price

Clear NYCA same as today

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

8






Questions and Comments

The NYISO is seeking comments on
the treatment of Zone K export
constraints

Additional comments, beyond those
received at today’s presentation,
should be sent to

DEckels@NYISO.com by January 7,
2015

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

9




Next Steps

January - review feedback from

stakeholders re: Treatment of Zone K
Export Constraints

February - Continue discussions with
stakeholders including stakeholder

feedback and alternative approaches

© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

10




© 2014 New York Independent System Operator, Inc.  All Rights Reserved.

11






























ATTACHMENT 4










This Numeric Example has been posted on February 19, 2015 with the December 18, 2014 MIWG Materials to accompany
the NYISO presentation entitled: "Treatment of Zone K Export Constraints into the G‐J Locality: Market Design Concept"





RequirementsLI LSENYC LSELHV LSEROS LSETotalsRequirementsLI LSENYC LSELHV LSEROS LSETotals

LI Zone60000006000LI Zone60000006000

NYC Zone0100000010000NYC Zone0100000010000

GHIJ Zone0105004500015000GHIJ Zone0105004500015000

NYCA (TD) Zone65001100050001750040000NYCA (TD) Zone65001100050001750040000

GHI Zone0500450005000GHI Zone0500450005000

ROS Zone5005005001750019000ROS Zone5005005001750019000



SupplyLINYCLHVGHIJ TotalROSNYCA TotalSupplyLINYCLHVGHIJ Total              ROS

Base Case7000110005500165001750041000Base Case70001100055001650017500



Base Case  LI with 1000MW of Excess over LCR Rqmt., 500MW in Excess of NYCA IRM Rqmt.              Export Case    300MW (Export Limit) of LI Excess to G‐J, LI LSE's Receive G‐J $

LINYCGHIJNYCALI LSE ‐> GHIJLINYCGHIJ              NYCA

Clearing Prices$7$18$12$6Clearing Prices$7$18$10$6





LocationLINYCLHVROSTotalsLocationLINYCLHVROSTotals

Paid to Generators$49,000,000$198,000,000$66,000,000$105,000,000$418,000,000Paid to Generators$49,000,000$198,000,000              $55,000,000              $105,000,000              $407,000,000



LI Requirement60000006000LI Requirement60000006000

LI Excess10000001000LI Excess10000001000

LI Purchased70000007000LI Purchased70000007000

NYC Requirement0100000010000NYC Requirement0100000010000

LI ‐> J Export00000LI ‐> J Export00000

NYC Excess01000001000NYC Excess01000001000

NYC Purchased0110000011000NYC Purchased0110000011000

GHIJ Requirement0105004500015000GHIJ Requirement0105004500015000

LI‐> GHIJ Export00000LI‐> GHIJ Export‐3002109000

GHIJ Excess0105045001500GHIJ Excess0105045001500

GHIJ Purchased0115504950016500GHIJ Purchased‐300117605040016500

GHI Purchased0550495005500GHI Purchased‐300760504005500

NYCA Requirement65001100050001750040000NYCA Requirement65001100050001750040000

NYCA Excess162.5275125437.51000NYCA Excess162.5275125437.51000

NYCA Purchased6662.511275512517937.541000NYCA Purchased6662.511275512517937.541000

ROS Purchased‐337.5‐27517517937.517500ROS Purchased‐37.5‐4858517937.517500



Total Costs to LoadTotal Costs to Load

LI$49,000,000$0$0$0$49,000,000LI$49,000,000$0$0$0

NYC$0$198,000,000$0$0$198,000,000NYC$0$198,000,000$0$0

GHI$0$6,600,000$59,400,000$0$66,000,000GHI($3,000,000)$7,600,000$50,400,000$0

ROS($2,025,000)($1,650,000)$1,050,000$107,625,000$105,000,000ROS($225,000)($2,910,000)$510,000$107,625,000

Total$46,975,000$202,950,000$60,450,000$107,625,000$418,000,000$418,000,000Total$45,775,000$202,690,000$50,910,000$107,625,000$407,000,000



The prices and quantities used in the example are not actual values but are approximated to show relative magnitudes for the purpose of this illustration.






























ATTACHMENT 5










2013 State of the Market Report

Recommendation to Enhance Locational
Pricing in the Capacity Market











Pallas LeeVanSchaick

NYISO Market Monitoring Unit

Potomac Economics



Installed Capacity Working Group
August 20, 2014






Introduction



  Additional details were requested about Recommendation #1 in
the 2013 SOM Report, which was to:

Create a dynamic and efficient framework for reflecting
locational planning requirements, including:

a)  Pre-defining interfaces/zones to satisfy planning reqs

b)  Granting financial capacity transfer rights for Tx upgrades

c)  Set demand curves to minimize cost to satisfy planning reqs

  This presentation covers:

Concerns with current capacity market framework

Principles and objectives of an enhanced framework

Key elements of an enhanced framework for (a), (b), & (c)

An alternative concept for (a) & (c)

- 2 -






Current Capacity Market Framework:
Overview of Concerns

  The following slides discuss five concerns with the current rules:

1)  The delay in the creation of an NCZ in SENY has contributed
to an increase in overall costs for loads in recent years;

2)  Prices are inconsistent with the value of resources in each
zone, leading to over-procurement in low-value areas;

3)  Transmission projects are not compensated for their value in
the capacity market, undermining incentives for investment;

4)  If additional retirements lead to resource adequacy issues

outside SENY, the capacity market will not provide efficient

signals for investment; and

5)  The capacity market does not provide incentives for helping
resolve transmission security issues, although these have
become increasing prevalent in recent RNAs.

- 3 -






Current Capacity Market Framework:

Effects of Delay in Creation of NCZ in SENY

  Resource Adequacy & Transmission Security issues for UPNY-
SENY have long been identified in planning studies.

  The slow process for creating the G-J Locality has:

Contributed to the 21 percent decline in Lower Hudson Valley
unforced capacity from Summer 2006 to Summer 2013;

Led to years of inflated LCRs and capacity prices for NYC (e.g.,

3 percent increase in LCR $47/kW for 2013/14);

Erected inefficient barriers to entry in Zones A to F where new
resources would be subject to a more stringent Highway

Deliverability Test; and

Contributed to a dramatic change in capacity prices for the Lower
Hudson Valley from 2013/14 to 2014/15 (instead of gradual one).

  Under the current process, a new NCZ would be created 2 to 4
years after similar problems would emerge in the future.

- 4 -






Current Capacity Market Framework:

Prices Not Consistent with Reliability Value

  The reliability value of adding resources in each area could be
more efficiently reflected in the Demand Curves or the LCRs.

Capacity prices are not consistent with the LOLE impact of

additional capacity in each area (in the scenario below where each area is at its LCR/IRM).  Note, as Zone K capacity rises above the LCR, LOLE impact falls more quickly than in other areas.

2013 SOM Table 7:  Cost of Improving Reliability from Additional Capacity



Monthly DemandAnnual Change inAnnual Cost of

Curve ReferenceLOLE from 100 MW1 Percent LOLE

Point ($/kW-mo)Capacity AdditionImprovement

Locality(1)(2)=(1)/(2)

G-J Locality$12.140.9%$12 Million

NYCA$8.840.3%$27 Million

Zone J (New York City)$18.551.0%$17 Million

Zone K (Long Island)

$7.96

- 5 -

1.0%

$7 Million






Current Capacity Market Framework:

Under-Compensating Transmission Investment

  The current market rules provide no capacity payments to most
internal transmission facilities.

However, transmission investment can significantly reduce the
cost of maintaining adequate installed reserve margins.

-  Transmission provides a benefit in capacity market
comparable to generation.

This may lead to under-investment in transmission.

  New generation projects may be able to interconnect in a
manner that increases TTC on key interfaces.

However, this may require additional expenditures.

Hence, generators may forego opportunities to increase TTC,
since they receive no compensation in the capacity market.

- 6 -






Current Capacity Market Framework:
Effects of Future Retirements

  Future retirements could change the distribution of resources

dramatically, which could increase the importance of interfaces
not currently addressed in the capacity market.

Example:  Retiring Ginna & Huntley would lead to resource
adequacy violations in western New York.

-  The result of those events under the current market rules
would be an increase in the IRM and/or LCRs.

  Even if necessary NCZs are eventually created, the lengthy and
uncertain process will not provide efficient market incentives

when critical resource adequacy needs arise in the future.

Investors will not have incentives to enter until after these
issues become critical and costly.

- 7 -






Current Capacity Market Framework:

Lack of Incentive to Resolve Tx Security Issues

  Inter-zonal transmission security violations could arise before
resource adequacy violations.

This could occur even for an area modeled in the capacity

market (e.g., RNA identifies violations into the G-J Locality).

A Regulated Solution might become necessary before the
capacity market can incent new entry.

  Retirement/mothball requests by 115kV units outside SENY
have led recent RNAs to identify Tx security violations.

The NYISO markets do not recognize the value of maintaining
115kV reliability and security.

Resources on the 115kV system often have fewer economies
of scale than higher voltage units.  This may lead them to

retire sooner and/or enter into costly RSSA contracts.

- 8 -






Enhanced Capacity Market Framework:
Introduction

  We recommend enhancements consistent with these principles:
Create interfaces and capacity zones based on where resources

are needed to satisfy planning reliability criteria.

Compensate resources (incl. transmission) consistent with
their value in satisfying NYISO planning reliability criteria.

  Such enhancements would provide the following benefits:
Increase incentives to entry for facilities that increase

transmission capability.

Reduce overall cost to load by procuring capacity from
resources most economic for satisfying planning criteria.

Provide more certainty to investors about how emerging
reliability needs will affect capacity prices in the future.

- 9 -






Elements of an Enhanced Framework:
Introduction

  There may be many ways to satisfy the design principles described
above.  This presentation discusses:

Elements of two potential enhanced market designs to illustrate
how concerns with the current market might be addressed:

-  One design would pre-define Capacity Market Interfaces
(slides 11-22) - For each interface, this would include:

  Defining the downstream capacity zone

  Defining the Fungible Area in the capacity zone

  Treatment of Non-Fungible Area(s) in the capacity zone

  Placement of the Demand Curve for the capacity zone

-  An alternative design concept is discussed (slides 26-27).
Compensating transmission for its capacity value (slides 23-25).

- 10 -






Elements of an Enhanced Framework:
Pre-Define Capacity Market Interfaces

  Capacity markets exist to provide the “missing money” needed
to satisfy resource adequacy and transmission security criteria.

  Interfaces modeled in capacity market should be derived from
the associated planning assessments, including:

RNA interfaces that bind into capacity-short areas during

MARS LOL events.  (See possible interfaces in Appendix A)

  Benefits of pre-defined Capacity Market Interfaces:

Satisfies planning criteria at lowest possible cost;

Ensures price separation occurs when capacity is more
valuable in one region; and

Provides more certainty to investors by helping them predict
how reliability needs will affect future capacity prices.

- 11 -






Elements of an Enhanced Framework:
Identify Capacity Zones

  For each Capacity Market Interface, there is a downstream
capacity zone where resources can be placed to satisfy needs
without increasing loading on interface.  (see list of possible
zones in Appendix B)

  Ideally, price separation should occur when the effect of

downstream capacity on the NYCA LOLE is different from the
effect of upstream capacity.

The amount of price separation should be proportional to the
extent that the Capacity Market Interface binds limiting flows

to the capacity-short area during MARS LOL events (for the
As-found system).

- 12 -






Elements of an Enhanced Framework:

Identify Fungible Area in Each Capacity Zone

  Within a particular capacity zone, transmission constraints may
limit the deliverability of capacity from some areas.

However, capacity in such export-limited areas still may
provide some reliability benefit.

  To set efficient capacity prices, it is important to distinguish
between Fungible Areas and Non-Fungible Areas.

The Fungible Area includes zones where resources can

provide relief that is roughly equivalent to the Proximate Zone

(i.e., zone closest to a particular Capacity Market Interface).

Example:  For capacity zone G to K, it is possible that:

-  The Fungible Area would include Zones G to J; and

-  The Non-Fungible Area would include that Zone K.

- 13 -






Elements of an Enhanced Framework:

Identify Fungible Area in Each Capacity Zone

  Transparent and objective criteria for classifying areas as
fungible or non-fungible is beneficial because it:

Facilitates pricing rules that compensate resources in
proportion to the reliability benefit they provide; and

Enables prospective investors to predict how retirements and
other market developments will affect future clearing prices.

  Such criteria could include a process whereby:

1)  The As-found system is moved to 0.1 LOLE by scaling load;

2)  For a capacity zone, MWs are shifted from the Proximate
Zone to another zone until:

-  LOLE increases to 0.105; or

-  MW shifted equals 10% of capacity zone load.

- 14 -






Elements of an Enhanced Framework:
Non-Fungible Areas - Export Limits

  For load zones that are not in the Fungible Area for a particular
Capacity Market Interface:

Export Limit would limit sales from each Non-Fungible Area.

  In the capacity auction:

The Export Limit would be applied relative to the peak load;
Before Export Limit is reached, the value of capacity in a
Non-Fungible Area is the same as the Fungible Area; and

Once Export Limit is reached, the value of capacity in a Non-
Fungible Area would be discounted using a Benefit Ratio.

  The process for identifying a Non-Fungible Area and deriving
an Export Limit would be similar to the NYISO evaluation of
Zone K (although it was based on the As-found system).

- 15 -






Elements of an Enhanced Framework:
Non-Fungible Areas - Export Limits

Slide 10 in NYISO Presentation at Zone K Tech Conference

- 16 -






Elements of an Enhanced Framework:
Non-Fungible Areas - Benefit Ratios

  Non-Fungible Areas provide reliability benefit to the extent that
additional capacity relieves the Capacity Market Interface.

The benefit is inversely proportional to the extent of binding
constraints in MARS LOL events (when the Capacity Market

Interface is also limiting flows into the capacity-short area).

The price of capacity should be discounted accordingly.

  A Benefit Ratio could be used to clear and to discount the
clearing price in the spot auction.  (Appendix C discusses

possible ways to calculate a Benefit Ratio.)

Example:  if Zone K exports bind in 40% of LOL events when
interfaces into capacity zone G to K also bind:

-  Zone K Benefit Ratio would be 60%, and the last 100 MW in
Zone K would satisfy 60 MW of G to K requirement.

- 17 -






Elements of an Enhanced Framework:

Non-Fungible Areas - Clearing the Spot Auction

  Spot Auctions should clear such that the reliability value of
Non-Fungible Areas is accurately reflected in clearing prices.

  In each capacity zone, offers would be cleared from lowest to
highest until intersection with demand curve.

Offer MWs & prices evaluated as current market for capacity:

-  In the Fungible Area; and

-  In the Non-Fungible Area until Export Limit is reached.
After Export Limit is reached:

-  Offer MWs multiplied by Benefit Ratio; and

-  Offer prices divided by Benefit Ratio.

  This is illustrated in Appendix D.

- 18 -






Elements of an Enhanced Framework:
Demand Curve Parameters

  The current rules do not ensure that relative capacity prices are
efficient.  To illustrate, suppose that adding 100 MW in:

Zone 1 lowers LOLE by 0.010 where the price is $120/kW-yr.
Zone 2 lowers LOLE by 0.005 where the price is $100/kW-yr.
In this example, the price of improving reliability by 0.01 is

$20 million/year in Zone 2 and $12 million/year in Zone 1.

-  Hence, prices are too high in Zone 2 and too low in Zone 1.

  Ideally, demand curves should be set such that capacity prices
reflect the reliability value of additional capacity in each zone.

All areas would have the same ratio of: (a) capacity price to

(b) rate of change in LOLE per MW.

This way, 1 MW in a $10/kW-month zone would provide

twice the benefit of 1 MW in a $5/kW-month zone.

- 19 -






Elements of an Enhanced Framework:
Demand Curve Parameters

  Pricing consistent with value would have several implications:
More capacity would be attracted to zones with a low Net

CONE and where capacity provides greater benefit; and

Less capacity would be attracted to zones with a high Net
CONE and where capacity provides lesser benefit.

Overall, capacity market costs would fall because each dollar
of investment would provide more reliability.

- 20 -






Elements of an Enhanced Framework:
Demand Curve Parameters

  In the demand curve reset, the NYISO could:

Create a Procurement Target to be used in place of the LCR.

-  The Procurement Target would be adjusted at the same time
as other demand curve parameters rather than annually.

Define each demand curve (including a Procurement Target, a
Reference Point, and a Zero Cross Point) such that:

-  All Proximate Zones have same ratio of:  (a) capacity price to

(b) rate of change in LOLE/MW of additional capacity,

-  When each capacity zone is at 100% of its Excess Level; and

-  When each capacity zone is at X% of its Excess Level
(where X is a pre-defined margin moderately above the
Excess Level).

- 21 -






Elements of an Enhanced Framework:
Inter-zonal Transmission Security

  If the demand curve for each capacity zone is set relative to the
Procurement Target as described, the zone may not satisfy
inter-zonal transmission security criteria.  In this case, a second
demand curve could be modeled for the capacity zone with:

Procurement Target raised until criteria met at excess level.

-  This would give the security-constrained capacity zone a
higher ratio of: (a) capacity price to (b) rate of change in
LOLE per MW of additional capacity.

-  This would allow for downward adjustments in the
Procurement Targets for all other capacity zones.

For any Non-Fungible Area, the Export Limit should be set to
reflect transfer capability for the relevant N-1-1 scenario and
the Benefit Ratio should equal 0.

- 22 -






Elements of an Enhanced Framework:
Financial Capacity Transfer Rights

  The current market rules provide no capacity payments to
internal transmission facilities.

However, transmission investment can significantly reduce the
cost of maintaining adequate installed reserve margins.

-  Transmission makes existing resources more deliverable and
reduces the effects of contingencies.

This may lead to under-investment in transmission.

  Ideally, transmission should receive capacity compensation to
the extent it provides a service comparable to installed capacity.

Compensation should be based on the amount by which

installed capacity requirements are reduced by the facility.

- 23 -






Elements of an Enhanced Framework:
Financial Capacity Transfer Rights

  Efficient compensation for a transmission facility requires
quantifying:

1)  The effect on the TTC of one or more interfaces from adding/
removing a facility.

2)  The marginal effect of a change in TTC on LOLE for the As-
found system.

3)  The value of reliability in $s per unit of LOLE implied by the
placement of the demand curves.

  Efficient compensation = (1) × (2) × (3)

- 24 -






Elements of an Enhanced Framework:
Financial Capacity Transfer Rights

  Some generation affects the TTCs of interfaces in the RNA.
The 2014 RNA (pages D-11 & D-12) provides a list of

Dynamic Limits, which are interface TTCs that depend on the
commitment status of individual generators.

Example:  Two Dunkirk units raise the Dysinger East interface
TTC by 750+ MW.

  It would also be appropriate to compensate (or charge)
individual generators for their impact on interface TTC.

Such compensation would provide incentives to interconnect
at points that increase the deliverability of other generators.

Such charges would be more efficient than assigning SDU

costs, since these can be a barrier to efficient investment if the
SDU costs are higher than the value of the upgrade.

- 25 -






Alternate Capacity Market Framework



  An alternative approach (to the one discussed in earlier slides)
would consist of:

1)  Developing a single capacity demand curve for all areas

expressed in $/unit of change in LOLE (rather than $/kW in a

particular location).

2)  Running MARS studies on the “As-cleared” system in each
Spot Auction to estimate the marginal effect on LOLE from
cleared MW for each zone.

Cleared capacity resource payment (in $/MW) = (1) × (2).

- 26 -






Alternate Capacity Market Framework



  Advantages over the approach discussed earlier:

Capacity prices in each zone more accurately reflect the value
of capacity, since this alternative approach uses fewer
intermediate calculations and approximations.

May be less resource-intensive than the process of defining
capacity zones, Fungible Areas, Benefit Ratios, etc.

-  However, some of these would still be necessary to account
for inter-zonal transmission security.

  Disadvantages:

Spot auction becomes more resource-intensive, and it may be
impractical to allow most resources to offer > $0.

- 27 -






Appendix A:  Pre-Define Capacity Market Interfaces
Slide 6 in NYISO Zone K Tech Conference Presentation

- 28 -






Appendix B:  Identify Capacity Zones
List of Potential Capacity Zones

Capacity Market Interface(s):Capacity Zone:

Dysinger EastZones B - K

West CentralZones C - K

Volney EastZones D - K

Moses SouthZones A - C, E - K

CE GroupZones F - K

UPNY-SENYZones G - K

UPNY-CEZones H - K

Millwood SouthZones I - K

City & East (group)Zones J, K

Dunwoodie SouthZone J

Y49/Y50Zone K

- 29 -






Appendix C:  Elements of an Enhanced Framework:
Non-Fungible Areas - Benefit Ratios

  At least two methods might be used to calculate Benefit Ratios.
Both start with a base case scenario where the Non-Fungible

Area is at the Export Limit.

1)  Delta LOLE Comparison Method:  Calculate LOLE for:
  Sensitivity Case 1:  +X MW in upstream region;
  Sensitivity Case 2:  +X MW in Fungible Area; and
  Sensitivity Case 3:  +X MW in Non-Fungible Area.
  Benefit Ratio = (LOLE1 - LOLE3) ÷ (LOLE1 - LOLE2)
  X could be based on size of demand curve unit

- 30 -






Appendix C:  Elements of an Enhanced Framework:
Non-Fungible Areas - Benefit Ratios

2)  Binding Constraint Frequency Method:

  Run one MARS case where X MW is added to the base case
in the Non-Fungible Area.

  Analyze the configuration of binding constraints relative to
capacity short areas during MARS LOL events.

For both methods, the Benefit Ratio could be calculated from

more than one value for X.

The second method would be less resource intensive.

- 31 -






Appendix D:  Elements of an Enhanced Framework
Non-Fungible Areas - Clearing the Spot Auction







$12

Offers - Not Export LimitedOffers in Fungible Area

Offers - Export LimitedOffers in Non-Fungible Area -Not Export Limited

$10Export LimitOffers in Non-Fungible Area -Benefit Ratio Adjusted

Demand Curve



$8Clearing Price in Fungible Area if

Benefit Ratio Adjusted Offers Excluded



$6Clearing Price inClearing Price in

Non-Fungible AreaFungible Area



$4





$2





$0

5.566.51313.51414.515

Offers in Non-Fungible Area (GW)Supply of Offers in Capacity Zone (GW)






























ATTACHMENT 6








Compliance with FERC Order

on Technical Conference re:
Treatment of Zone K Export
Constraints into the G-J

Locality



Randy Wyatt

Capacity Market Products

New York Independent System Operator



ICAPWG

February 24, 2015

NYISO, Rensselaer, NY

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

1








Objective: In Compliance with the  November
25, 2014 FERC Order on the (February 25,

2014) Technical Conference:



  Explore with stakeholders “whether a proposal can be

developed that could reduce the cost of procuring capacity

while meeting the NYISO LOLE objective.”[emphasis added]:
and

“[E]xplore the issues and evaluate the proposals discussed

at the conference, including the MMU’s recommendations,

through its stakeholder process and file an informational

report with the Commission by June 1, 2015.”



To facilitate exploration and evaluation, this presentation groups
by issue proposals discussed at the Technical Conference.

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

2






Proposals Raised During the Tech Conference

Treatment of Zone K Export Constraint Limits in NYISO G-J Demand

Curves

Accurately reflect the reliability benefits of Zone K  excess in SENY and NYCA

Monitor export constraints for each DCR to determine if Zone K should be added to boundary of G-J

Locality

Recognize the reliability and  transmission security benefits that Zone K can provide the NCZ

Evaluate to what extent any export constrained zone in the NYISO should  be allowed to sell capacity in

any other zone

Evaluate alternative LCR methodologies that

better reflect the export constraint constraints

more accurately reflect the reliability value of capacity resources in different areas, or

considers a deliverability-based methodology for the LCRs associated with new Localities

Evaluate rules to achieve price convergence or eliminate Localities

Assess improved methodologies for modeling deliverability constraints

and identify deliverability constraint triggers that warrant pre-definition of

capacity zones

Seek tariff amendments to include a detailed description of tests/metrics to be used in establishing NCZ

boundaries

Consider developing a Capacity Deliverability Right for Transmission

Expansion increasing the deliverability of the constrained interface

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

3






Status of Discussions

MMU discussions at August 20, and

November 14, 2014 ICAPWG meetings
clarifying SOM recommendations re: An
Enhanced Capacity Market Framework:

  Dynamic locational requirements

  Fungibility and treatment of export constraints

  Procurement Targets to be used in place of the LCR

  Requires significant changes to current capacity market   Complicated to define and administer key elements

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

4






Status of Discussions (continued)

NYISO led discussions at ICAPWG and
MIWG meetings regarding market design
concepts for:

   Capacity Zone Elimination - October 30, 2014 ICAPWG

Is there a need to eliminate?

Zone elimination objectives and challenges

  Capacity Zone Predefine and Eliminate - November 17,
2014, ICAPWG

Discussed whether there is a need to predefine and eliminate

capacity zones, and if there is, discuss design concepts for each

Reviewed how PJM predefines and eliminates zones

NYISO possible options for predefine and eliminate

Potential triggers and issues to be addressed for zone elimination

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

5






Status of Discussions (continued)

NYISO led discussions at December 18
MIWG regarding market design concepts
for the “Treatment of Zone K Export
Constraints into the G-J  Locality”

  Reviewed existing pricing hierarchal rules and auction
mechanics

  Proposed to solve the ICAP Spot Auction as we do today,
with an additional step

Count the MW that clear above the Zone K LCR, up to the K export
limit MW, toward the G-J requirement, and count the remaining MW
that clear in K above the Zone K LCR  (i.e., those above the export
limit) toward the NYCA requirement

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

6






Status of Discussions (continued)

NYISO is in the process of creating a task
force to review within the ICAPWG the
current LCR determination process for
localities

  The Task Force was discussed with the Operating
Committing meeting on January 15, 2015

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

7






Process Steps for Evaluating Technical

Conference Proposals

March 18 ICAPWG - Stakeholders can present
export constrained zone modeling concepts

  Objective

  Preferred approach and alternatives   Numeric example

  Benefits and detriments

April 30 ICAPWG: Continue stakeholder
discussions

June 1, 2015 - NYISO to submit informational
report to FERC

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

8




© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

9






























ATTACHMENT 7








IRM/LCR  Process  &  Dynamics











Presented  to  Joint  ICAP/MIWG/PRLWG  Mee;ng
January  29,  2015

by

Mark  Younger

Hudson  Energy  Economics,  LLC




Background



•  The  NYISO  presented  their  analysis  on  the

required  LCRs  for  the  2015/2016  capability  year
at  this  month’s  OC  mee;ng

•  This  engendered  substan;al  discussion  about

what  was  driving  the  LCR  numbers  and  whether
the  methodology  needs  to  be  revised.

•  The  NYISO  agreed  to  coordinate  a  discussion

about  the  exis;ng  IRM/LCR  seYng  methodology
and  a  review  of  whether  the  methodology  should
be  revised.




LCR  Driving  Factors?



•  During  the  discussion,  some  par;es  proposed
that  under  the  exis;ng  IRM/LCR  methodology
adding  capacity  to  a  zone  will  cause  the  zones
LCR  to  increase

•  I  noted  that  changes  in  UDR  elec;ons  could
impact  the  LCR  calcula;ons

•  A  number  of  par;es  raised  the  concern  that  it  is
cri;cal  to  understand  how  specific  drivers  impact
the  LCR  determina;on  for  each  Sub-­‐Zone




The  Need  To  Analyze  the  Current
Methodology

•  The  first  step  to  determining  whether  the  IRM/
LCR  seYng  methodology  should  be  revised  is  to
get  a  beaer  understanding  of  how  the  process
responds  to  changes  to  the  system

•  MPs  are  significantly  hampered  in  geYng  this
understanding  because  most  of  the  data  is
appropriately  confiden;al

•  Only  the  NYISO  is  in  a  posi;on  to  perform  the
analysis




Proposed  Analysis

•  I  have  developed  some  simple  sensi;vi;es  to

provide  beaer  understanding  of  how  the  exis;ng
process  works  and  the  factors  that  will  affect  it

•  The  intent  of  the  analysis  is  to  provide

informa;on  on  how  discrete  system  changes  will
affect  the  IRM/LCR  values  in  the  different  zones
under  the  exis;ng  methodology

•  With  the  analysis  results  we  can  get  a  beaer

understanding  of  the  current  IRM/LCR

methodology  and  whether  those  results  indicate
a  need  to  revise  the  methodology




Proposed  Analysis  (cont’d)



•  Start  with  the  final  database  for  the  IRM/LCR  that
was  approved  for  2015/2016

•  Each  Sensi;vity  is  a  discrete  change  to  the  final
database

•  Run  a  complete  TAN-­‐45  analysis  for  each  of  the
sensi;vi;es  to  determine  the  IRM  and  then  apply
the  LCR  calcula;on  process  for  each  of  the
Capacity  Zones

•  Report  the  resul;ng  IRM  and  LCRs  for  each
sensi;vity




Sensi;vi;es

•  Add  a  500  MW  generic  generator  to  NYC  with
the  generator  EFORd  set  at  the  Zone  J  average

•  Add  a  500  MW  generic  generator  to  Zones  G  -
I  with  the  generator  EFORd  set  at  the  LHV
average

•  Reduce  UDR  elec;ons  into  NYC  by  300  MW

•  Increase  UDR  elec;ons  into  NYC  by  300  MW

•  Model  the  TOTs  Projects






























ATTACHMENT 8






LCR Process

Review

Dana Walters

Director Economic and Reliability Planning

New York Independent System Operator

LCR Task Force

March 5, 2015

NYISO, Krey Corporate Center

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY






Administrative

Introductions

Approach to Meeting

Provide a starting reference for task force
members for consistent understanding of

objectives, issues, and processes

Discuss background information

Discuss expressed concerns with LCR process
Discuss existing processes

Discuss topics for next meeting, but don’t discuss
specifics of alternatives or solutions at this
meeting

Discuss meeting schedule

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

2






Issue Statement

Some stakeholders have expressed
concerns with the existing Locational
Capacity Requirements (LCRs)

process because:

  When load decreases and resources increase, then
requirements in G-I may increase

  If the requirements increase, then Load Serving Entities
(LSEs) need to buy more capacity.

  This seems counter-intuitive when new resources are
available to respond to a need.

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

3






Background of Request

NYISO was asked by the Operating Committee to
work with the ICAP WG to take the lead in
considering an alternative process to calculate
LCRs to address the concerns raised

NYISO extended to stakeholders an invitation to
participate on a LCR Task Force to consider the
issue

NYISO is coordinating the effort to scope the
request, consider alternatives and perform

analysis of potential viable options, as resources
permit

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

4




Installed Reserve Margin

A Power Grid requires Installed Reserve Margin
(IRM) to operate its generating fleet and provide
customers with reliable service

There are infinite ways to calculate the LSE
obligations to provide for the IRM and LCRs

In NY, the Transmission Owners (TOs) reached an
agreement to balance the obligation for the IRM

between the upstate (north of NYC; Zones A-I) LSEs

and the downstate LSEs (NYC & LI; Zones J & K)

Roughly 50% of the peak electrical demand in NY is
in Zones A-I and 50% in J & K

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

5






Background of Unified Methodology

Unified Methodology is a two step process

  Step 1 (referred to as the Tan 45 method): Develop a curve with
varying IRM versus locational requirements in Zones J & K,

where all points on the curve will provide a one day in ten year

(0.1) Loss of Load Expectation (LOLE)

  Use a 45 degree line to intersect the curve and provide a 50%
balance point

  Step 1 is administered by NYSRC

  Step 2 (LCR Method): Starting with the IRM as a reference,

determine the locational requirements of Zones J & K and the G-
J Locality

  Step 2 is administered by NYISO

Both steps use the GE Multi-Area Reliability

Simulation (MARS) program, which uses a Monte
Carlo probabilistic simulation to evaluate the LOLE

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

6






Creation of New G-J Locality

NYISO was directed by FERC to create a new
Locality based on the outcome of study

NYISO created the G-J Locality

An LCR has to be established for each Locality, so
the NYISO developed a process to calculate the G-J
requirement without impacting the existing Tan 45
process

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

7




© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

8










Setting of the IRM and LCRs

The Basic Process





Greg Drake

Supervisor - Resource Adequacy

New York Independent System Operator







ICAP WG Task Force for LCR Review

March 5, 2015

NYISO , Rensselaer, NY

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

1




Objectives

Basic understanding of the NYSRC’s
process for setting the IRM1

Basic understanding of the NYISO’s
process for setting the LCRs2

The LCR process starts with the completed
base case database for the IRM.









1.To find NYSRC Policy 5-8 go to Documents/Policies at http://www.nysrc.org.

2.To find NYISO LCR Calculation Process go to NYISO website at nyiso.com and look

under Market Data/ICAP/Reference Documents/LCR_Calculation_Process

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

2






IRM Process - Background

The IRM study3 occurs over a calendar year
for an upcoming Capability Year (May-
April)

NYISO populates data and performs

simulations under guidance of NYSRC’s
ICS.

The NYISO is a technical resource for the
NYSRC







3. To find present and past IRM reports go to Documents/Reports at http://www.nysrc.org.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

3






IRM Process - Background

IRM answers the question of how much
ICAP is needed to meet the peak load.

The year is simulated at least 1,000
times to give a Loss of Load

Expectation (LOLE).

Capacity is adjusted so that over the

1,000 iterations, the LOLE comes out to

the NYSRC criterion of 0.100 days/year.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

4






IRM Process - Load Inputs

The load forecast is based on previous year

actual plus forecast growth (TO/NYISO agreement)

  The forecast represents a 50% chance the actual load is higher
(50/50 forecast)

Uncertainty of load due to weather is
studied.

  Each 1,000 iteration case is run against seven load levels with
various probabilities.

  For example, one of the levels could indicate the load if there
was only a 6% probability of being above that load (94/6
forecast).

Each load level can have its own historic
hourly load shape.

  We currently use 3 shapes.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

5






Load Forecast Uncertainty

LFU Model



Load Forecast Uncertainty Models

Multiplier  Zones A-E Zones F&GZones H&I Con Ed (J)  LIPA (K)

0.00620.85500.82450.78930.84490.7971

0.06060.90210.88300.85000.89290.8677

0.24170.95100.94200.91230.93970.9364

0.38301.00001.00000.97410.98311.0000

0.24171.04741.05541.03291.02021.0554

0.06061.09161.10671.08561.04811.0996

0.00621.13091.15241.12891.06351.1295







LFU Distributions



0.450

0.400

0.350

0.300

0.250

0.200

0.150

0.100

0.050

0.000

0.7800.8200.8600.9000.9400.9801.0201.0601.1001.1401.180



JKZones H&IZones A-EZones F&G

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

6






IRM Process, Load Inputs-continued

Reasons for using different load shapes:

  Historically, years where the peak was around the 90/10
forecast (higher load level), the hourly load shapes were

peaked.

By peaked, we mean that the number of days whose peaks are near
to the peak day were small

The shapes chosen are based on a conservative year, a peaked year,
and a typical year

Even though there are seven load levels,
risk (LOLE events) occurs only in the top
four bins.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

7






IRM Process - Capacity Inputs

              5 years of historical performance is used to predict

future availability of thermal and large hydro

generators.

  Wind and solar use one year of production data.

  Run of river hydro uses a plot of monthly output based on
history

The simulation program uses a Monte Carlo

methodology to probabilistically generate hourly
outage patterns for thermal units for each of the
1,000 iterations.

Special Case Resources (SCRs) are modeled based
on registrations and are derated based on tested
and historic performance.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

8






IRM Process - Other Inputs



We model interface limits between Zones and

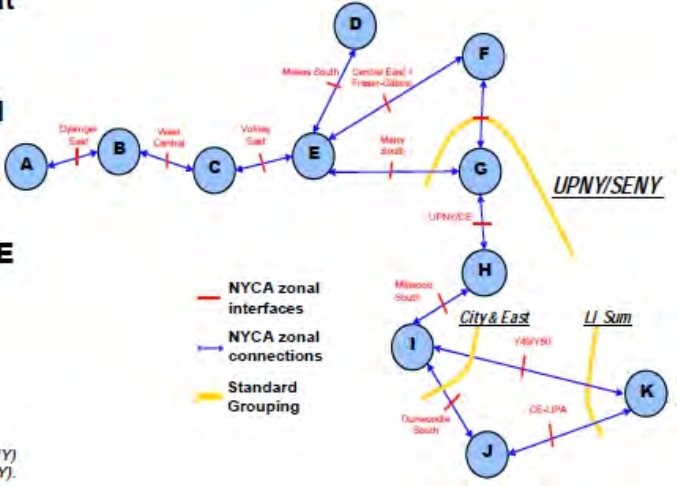

between Areas4 (line and bubble diagram).

Unforced Deliverability Rights (UDR) facilities, to
the extent they have not elected to return them for

the upcoming Capability Year (i.e., notification to
NYISO by August 1) are modeled as contracts.

   Contract levels on UDRs are considered confidential

   Any tie capacity left (after contracts) is available for emergency
assistance













4.  Current computing capabilities do not support use of a power flow model in GE MARS.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

9






IRM Process - Other Inputs

We model the Emergency Operator Procedures
(EOPs) that can be employed during a system

emergency.

  Such as: Voltage reductions, Emergency Demand

Response Program (EDRP), Public Appeals, voluntary industrial curtailments, and operating reserves.

Finally, we can ask for emergency assistance from
our neighbors.

  We model neighboring interconnected Control Areas of

PJM (classic footprint), New England, Ontario and Quebec

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

10










Transmission System Representation for Year 2015 - Summer Emergency Ratings (MW) 6/30/2014


IRM 2015/ICS
10/01/2014

Final Review

1850

IESO
(Ontario)


Hydro
Quebec

1912(HQ)

1,000



Cedars

1



300


1200



100





1,500

190D

03250/3200/

3003140/3035/

16002920


















F


Phase 2 Highgate

250

0

Vermont

1400

800

NY / NE


1300







1700Dysinger

East

1999

A






B


Moses South









West13002650

Volney East
Central

1999

E

1300C5650


1999









3475

1999

Marcy
South

G


Central MA

1400 →  ← 1400



800

W estern MA

Athens-

Gilboa

New England


2200/1575/

950600
550


16001700

4800/4725/600

4640/4485/1999


Zone A Group  2300/1550/

775



PJM

Central

550

2005700

1015


300

CE Group



300







8400


4310← 3400

UPNY-CE

5210

H

Millwood South

1999

8450


UPNY-SENY800

Connecticut

5150

330



Norwalk
CT



428


PJM
West



5500


7500

850



PJM South

6500West



PJM Mid-Atlantic


PJM East





0







See Next Slide


I

530

1999





Dunwoodie
South


City & EastLI Sum

51601525 →  ← 297/260/144



428/388

1290

K

330Cross Sound

4400Controllable Line

235660


NYCA zonal interfaces
NYCA zonal connections
External connections


1,500 Dynamic internal transfer limits 1,500 NYCA internal transfer limits

1,500External transfer limits


Neptune Controllable

JLine

510/ 403/283

← 199

LI West


99,999 →


Standard Grouping
Grouping used for monitoring


X  NYCA zone
X “Dummy” zone for analysis

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

11












Transmission System Representation for Year 2015 - Summer Emergency Ratings (MW)

PJM-SENY MARS Model

6/30/2014

Joint interface to


monitor flow balance



PJMNYCA









1000

RECO

10001000

1000/600/


1000


G



0

H



I

1000/600/
500/400

J




1000



PJM

East





0


500/400



1000





815

A Line + VFT



HTP


Dummy

Zone (J2)0



815Dummy

Zone (J3)

500



Dummy

660Zone (J4)0




815/700/500/200660

K





660





Neptune Controllable Line




(PJM East to RECO)  + (PJM East to J2) + (PJM East to J3) + (PJM East to J4) = 3075 MW

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

12






IRM Process - One Curve Point

If, after utilizing all means possible to meet
the peak load, there is still a shortage, a
loss of load event is registered.

A single load level LOLE value is the

expected loss of load events per year at this

level.

  The final LOLE is arrived at by multiplying each load level
probability times its result and adding the seven values.

The model is re-run varying the amount of
capacity removed until 0.100 LOLE is met.

  NYCA currently has excess capacity

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

13






IRM Process - Multiple Curve Points

Capacity upstate has a different statewide
LOLE impact than capacity downstate.

Where and how the capacity is adjusted
affects the final results.

The IRM-LCR curve (next slide) shows the
relationship of the tradeoffs between

statewide and J&K locality values (all points
are at criteria).

The NYSRC technical report indicates the
IRM at the knee (or tan 45) of the curve.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

14










Figure 3-2 NYCA Locational Requirements vs. Statewide Requirements



New York City [IRM = 17.3%, MLCR = 83.4%]

90






88





86





84





82





80

1415






y = 0.3686x2 - 13.621x + 208.77
R² = 0.9999





















1617181920 In stalled R eserve Margin  (%)

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

15












Long Island [IRM = 17.3%, MLCR = 103.7]

112





110



y = 0.4114x2 - 15.313x + 245.47

108R² = 0.9999





106





104





102





100

14151617181920

In stalled R eserve Margin  (%)

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

16






LCR Process - Background

The IRM study shows indicative LCR
values for Zones J & K.  Actual LCR
values are found during the LCR study.

  The LCR Study starts with the completed IRM database

The LCR values must also comply with
the LOLE criteria.

A separate IRM-LCR curve is not

created since the IRM value is a fixed
input to the LCR study.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

17






LCR Process - Input Changes

The load forecast is updated between
the time of the IRM and LCR studies.

Other material changes5 could also be
incorporated.

The resulting LCRs could look different than the
ones shown in IRM.











5. Material capability changes are individual changes that would increase or decrease generation, CRIS MW, or transmission transfer capability by 200 MW or greater.

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

18




LCR Process - Steps

At the established IRM study point:

  Reset all capacity to Zones J & K. to their ‘as found’
condition.

  Shift capacity from Zone J to upstate zones (A, C, and D)
until the LOLE criteria is met.

  Reset the capacity from J and shift from Zone K.

  Reset the capacity from K and shift from J & K based on
ratios found above.  This sets the recommendation for

the J and K LCRs.

  Reset J’s capacity and freeze K’s at the above found LCR
level.

  Shift capacity from G-J. The remaining capacity divided
by the G-J peak load is the proposed G-J LCR6.



6.  The LCR values are rounded to the nearest 0.5% and the LOLE is verified to satisfy LOLE criteria

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

19






Numerical Example7 of LCR Calculations

Setting of Zones J and K LCRs (example)

MWsStartingAfter ShiftPeak LoadMargin

ZonesShifted:J Ratio:K Ratio:CapacityCapacityForecast%

Shift J alone500105001000011929

Shift K alone400600056005539

=500/(400+500)=400/(400+500)

Ratios found:0.55555560.4444444



Shift J and K700

Final J388.9=700*0.561050010111.11192984.8%

Final K311.1=700*0.4460005688.95539102.7%



Setting LCRs for the G -J Locality (example)

MWsStartingAfter ShiftPeak LoadMargin

ZonesShifted:J Ratio:K Ratio:CapacityCapacityForecast%



Shift G - J70515425147201634090.1%

Fixed Shift of K:311.160005688.95539102.7%



7.  All capacity values are in ICAP

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

20




Numerical Example8 of LCR Calculations

After 600 MW Unit Addition in Zone G

Setting of Zones J and K LCRs (example)

MWsStartingAfter ShiftPeak LoadMarginInitial Case

ZonesShifted:J Ratio:K Ratio:CapacityCapacityForecast%Margin(%)

Shift J alone60010500990011929

Shift K alone500600055005539

Ratios found:0.5454550.454545



Shift J and K900

Final J490.91050010009.11192983.9%84.8%

Final K409.160005590.95539100.9%102.7%



Setting LCRs for the G -J Locality (example)



MWsStartingAfter ShiftPeak LoadMargin

ZonesShifted:J Ratio:K Ratio:CapacityCapacityForecast%



Shift G - J90516025151201634092.5%90.1%

Fixed Shift of K:409.160005590.95539100.9%102.7%



8.  All capacity values are in ICAP

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

21


























The New York Independent System Operator (NYISO) is a not-for-profit
corporation that began operations in 1999. The NYISO operates New York’s
bulk electricity grid, administers the state’s wholesale electricity markets, and
provides comprehensive reliability planning for state’s bulk electricity system.

__________________________________________________________



www.nyiso.com

© 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

22








LCR Process Review:

Next Steps

Dana Walters

Director Economic and Reliability Planning

New York Independent System Operator

LCR Task Force

March 5, 2015

NYISO, Krey Corporate Center

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY




Scope

Discuss stakeholder concerns with the
current process

Discuss viable options to explore

Strictly from the LCR perspective

Whether it would be beneficial to involve IRM

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

2




Concerns with changing the

LCR process

If the LCR increases in G-I, but the other
Localities and NYCA minimum

requirements decrease, stakeholders’
views of the change may vary.

There is only one variable in the LCR

process after the application of the Tan 45
process (trade-offs for LSEs south of
UPNY/SENY)

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

3






Stakeholder Suggestion

Suggestion: As opposed to TAN45

optimizing b/w Zone J vs K and letting G-J
“fall out” as a result; TAN45 optimizing b/w
Zone K vs  G-J and let J “fall out” as a
result.  In this manner Zone J is partially

optimized through G-J.

Issue: We would need to decide how to

optimize and what quantities to add/deduct
by individual Zone (G, H, I, J). Optimization
may not result in minimum requirements
for an individual Zone.

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

4






Stakeholder Concerns: Inter-relationship with IRM
process

Some possible LCR process revisions might not
be possible without the IRM process being
changed prior to or concurrent with a change to

the LCR process

Changing the IRM process is a more complicated
issue and will raise other issues, most notably the
IRM is under the jurisdiction of the NYSRC

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

5




© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

6






























ATTACHMENT 9












Objective of LCR Methodology Review:

Possible Alternatives





Dana Walters

Dir. Reliability and Economic Planning
New York Independent System Operator



LCR Task Force

April 8, 2015

KCC

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY




Current Process

NYSRC: Determine Installed Reserve Margin
(IRM), where the IRM maintains reliability and
establishes balance between the upstate and
downstate requirements per Policy 5

NYISO: There are multiple possible

approaches to determine the Locational

Minimum Installed Capacity Requirements

(LCRs)

The NYISO has been using Policy 5 as a

guide for the methodology to establish the

LCRs

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

2






Possible Alternatives

(Subject to maintaining LOLE of 0.1 and the IRM determined by NYSRC)

Continue with current methodology

Minimize Cost: Explore methodologies to set LCRs
for J, K and G-J with the objective of minimizing

the NYCA-wide capacity procurement costs

Minimize total MW: Explore methodologies to set
LCRs for J, K and G-J with the objective of
minimizing the NYCA-wide MW requirement

Lowest Possible G-J: Retain J and K “as found”
and determine the minimum G-J

Other ideas

© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

3




© 2000 - 2015 New York Independent System Operator, Inc.  All Rights Reserved.

DRAFT - FOR DISCUSSION PURPOSES ONLY

4
